Prefab Modular ADU — Complete Guide

Prefab Modular ADU: Real Costs, Code Paths, and When It Actually Works

By The Dwelling Index Editorial TeamLast updated: Last verified: ~25 min read

The bottom line, up front

A prefab modular ADU is a factory-built accessory dwelling unit that ships to your property and sets onto a permanent foundation. It’s the right move when your lot is flat and accessible, your city accepts the unit’s building-code path, and your quote covers the full installed scope. It is not automatically cheaper than building on-site. The factory unit is often advertised from roughly $100,000 to $250,000+, but the finished, permitted project routinely runs $200,000–$400,000+ once foundation, site work, utilities, delivery, crane, and permits are included — because the factory unit is only 40–60% of the total project cost.

Applies to: U.S. homeowners actively comparing a factory-built backyard unit against site-built, panelized, manufactured, or conversion ADUs.

Two ways to start: Check your address before you spend a dollar on plans → See What You Can Build — Get Your Free ADU Report. Already have a quote in hand? Jump to the Quote Checker to see which cost lines it’s probably missing.

Finished prefab modular ADU installed in a backyard at dusk — a single-story unit with wood accents and large windows

A completed prefab modular ADU. The factory unit is one cost layer — foundation, site work, and utilities are others.

ADU stands for accessory dwelling unit — a self-contained second home (kitchen, bath, sleeping area) on the same lot as a main house. A prefab modular ADU is simply one way to build that unit: in a factory, in finished sections, then delivered to your lot and crane-set onto a permanent foundation. The code path, delivery constraints, and all-in cost determine whether it actually works for you — and this guide gives you all three answers.

Is a prefab modular ADU right for you? (start here)

Answer: A prefab modular ADU fits best on flat, accessible lots with a standard floor plan, in cities that permit factory-built residential construction. On tight, sloped, or tree-and-wire-blocked lots, panelized or site-built construction usually wins because it doesn’t depend on a crane lift. A cheap tiny home or park-model unit may not qualify as a legal permanent dwelling at all.

Prefab modular ADU situation-to-path routing table
Your situationBest first pathWhy
Flat lot, clear street and crane access, a standard floor plan worksModular ADUFastest physical set; most predictable structural cost.
Tight side yard, mature trees, overhead power lines, no crane pathPanelized or site-builtPanelized ships in flat pieces and assembles on-site; no crane lift required.
You found a "$50K" tiny home, RV, or park modelVerify the code path firstIt may not be legal as a permanent ADU. Seattle treats tiny houses on wheels like camper trailers.
You need a custom footprint, historic-district or HOA design matchSite-builtBest for slopes, odd lots, and strict design review.
Your budget depends on rental incomeQuote check + financing reviewInstalled cost and local rental rules matter far more than the sticker price.

See What You Can Build → Get Your Free ADU Report

Check your lot’s zoning, setbacks, likely ADU type, and early cost-risk flags before you pay for plans or put down a prefab deposit. Free, about 60 seconds, no obligation.

Check My Address Free →

✅ What we verified for this guide

  • Building-code and financing distinctions from primary sources: Fannie Mae Selling Guide B2-3-02 (Factory-Built Housing, dated 02/04/2026) and B4-1.4-02 (dated 10/06/2021); HUD Manufactured Home Construction and Safety Standards at 24 CFR Part 3280.
  • Published provider pricing and scope from Abodu, Samara, Studio Home / Studio Shed, and BOXABL pricing pages (2025–2026).
  • City and state permitting rules from official sources: City of San José, City of Los Angeles (LADBS), City of Seattle (SDCI), City of Portland, City of Austin, Town of Truckee, MRSC (Washington), and Mass.gov (M.G.L. c. 40A).
  • Cost-range data from published cost guides (Angi, HomeGuide, AmeriSave, 2025–2026), reconciled to separate module-only pricing from all-in installed pricing.

Verification date: . We recheck provider pricing monthly to quarterly, and laws, permit rules, and financing guidance quarterly and after agency or legislative updates. Spot an outdated figure? Email editorial@dwellingindex.com.

What is a prefab modular ADU, exactly?

Answer: A prefab modular ADU is a factory-built accessory dwelling unit delivered to a property and installed on a permanent foundation. The decisive feature is not the word “prefab” — it’s the building-code standard the unit is built to: state/local residential code (modular), the federal HUD Code (manufactured), or a non-residential RV standard (many tiny homes and park models). That code path determines whether your city will permit it, whether a lender will finance it, and how it appraises.

“Prefab” — short for prefabricated — just means a structure built partly or fully off-site and trucked to your lot. It’s an umbrella term, not a code category, and that’s exactly where buyers get burned. Under that umbrella sit several very different products that cities and lenders treat very differently.

“Prefab” is an umbrella — the five things hiding under it

Modular ADU
Built in finished three-dimensional sections in a factory, trucked in, and set — usually by crane — onto a permanent foundation. Built to the International Residential Code (IRC), administered by your state. The category most people mean by "prefab modular ADU," and the one that behaves like normal real estate.
Panelized ADU
The factory builds flat components — walls, floor, and roof panels, often with windows and wiring pre-installed — and ships them flat. A local crew assembles them on-site. The workaround when a lot can't take a crane-set module.
Manufactured ADU
Built on a permanent steel chassis to the federal HUD Code (24 CFR Part 3280), not local code. Identified by a metal HUD Certification Label on the exterior and a HUD Data Plate inside. Different foundation, title, appraisal, and lender rules apply.
Park model / RV-style unit
Built to recreational-vehicle standards (often RVIA-certified), not residential code. Frequently marketed alongside "tiny homes."
Tiny home on wheels (THOW)
Often built to RV or no residential standard at all, and frequently not legal as a permanent dwelling. Seattle is explicit: tiny houses on wheels are treated like camper trailers, and you cannot live in one on a lot inside city limits.

A useful field test from lending guidance: If the unit has a HUD Data Plate or HUD Certification Label, it’s a manufactured home. If it has a state inspection certificate or builder certificate of origin referencing the IRC/IBC, it’s modular. That single document changes which loan products and appraisal rules apply — ask for it in writing before you sign anything.

The code-path classifier: modular vs. manufactured vs. tiny home

Answer: The fastest way to avoid a financing or permitting disaster is to identify the unit’s code path before you ever discuss price. Modular (IRC) units are generally the easiest to permit and finance; HUD-code manufactured units carry stricter foundation, title, and lender requirements; tiny homes on wheels are frequently not legal permanent ADUs.

Prefab ADU code-path classifier
What marketing calls itThe one question to askWhy it matters
Modular ADUIs it built to the IRC / state residential code, with a state inspection certificate?Usually the smoothest path for permits and lending once permanently installed.
Manufactured ADUIs it HUD-code? Where are the HUD label and data plate?Triggers different appraisal forms, title and foundation certification, and a narrower lender pool.
Panelized ADUWho assembles it on-site, and who pulls the local permits?Flexible for tight lots, but still on-site construction with local permits and inspections.
Tiny home / park model / THOWIs this legal as a permanent dwelling in my specific jurisdiction?Often NOT the same as a legal ADU. Confirm in writing with your planning department.

Why this distinction decides your financing and appraisal

Answer: Per Fannie Mae’s Selling Guide (B2-3-02, dated February 4, 2026), modular, prefabricated, panelized, and sectional housing “is not considered manufactured housing” and, when built to local code, permanently attached, and classified as real property, receives the same treatment as site-built housing. Manufactured (HUD-code) homes follow a separate, stricter chapter.

  • Modular homes must be built to the IRC administered by the state. Fannie Mae purchases loans on them and “affords modular, prefabricated, panelized, or sectional housing the same treatment as site-built housing” — meaning no minimum requirements for width, size, or roof pitch, and standard appraisal treatment.
  • Manufactured homes are any dwelling “built on a permanent chassis… evidenced by a HUD Data Plate or HUD Certification Label(s)” and built to HUD’s federal standard (24 CFR Part 3280). They fall under a different guide chapter with extra foundation-certification and titling steps.

In plain English: a true modular ADU on a permanent foundation is normal real estate. Your lender and appraiser can treat it like an addition to your house. A HUD-code manufactured unit can still be financed, but it’s a narrower road. And a tiny home on wheels usually isn’t real estate at all — it’s closer to a vehicle, which is why mortgages generally won’t touch it.

Some states have written this preference straight into law. Massachusetts, for instance, requires that prefab and modular homes be allowed as ADUs as long as they meet the state building code — and bars cities from adding extra restrictions just because a unit is modular (M.G.L. c. 40A, as amended by the Affordable Homes Act, Ch. 150 of the Acts of 2024).

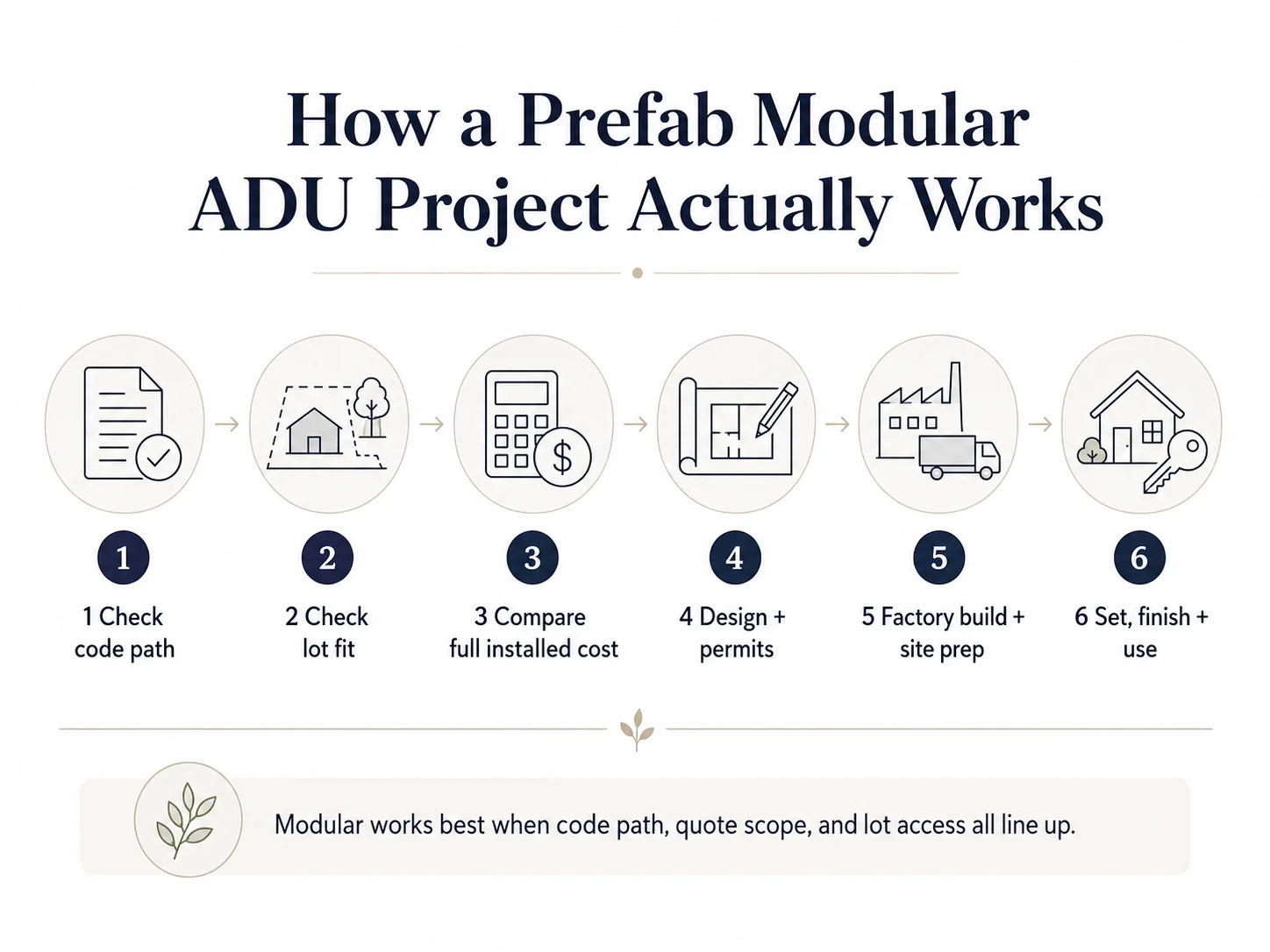

How a prefab modular ADU project actually works: six steps from code path check to set, finish, and use

How much does a prefab modular ADU really cost installed?

Answer: The honest number is the installed cost, not the factory unit price. A unit advertised at $100,000–$250,000 frequently becomes a $200,000–$400,000+ finished project once foundation, grading, utility hookups, delivery, crane, permits, engineering, and finish work are added. Published cost guides put ADU construction around $150–$300 per square foot on average; module-only figures of roughly $80–$160 per square foot must be read carefully because they often exclude major site-work lines.

Why you see two completely different prices (the sticker vs. all-in gap)

The low per-square-foot number almost always describes the factory module by itself — the box, delivered, before it touches your dirt. AmeriSave’s 2026 modular breakdown is blunt about it: the complete installed cost averages $80–$160 per square foot once delivery, site work, and assembly are added — and the factory modules represent only “roughly 40–60% of your final project cost.”6 For a custom or constrained ADU, the all-in figure climbs higher: Angi’s 2026 data puts ADU construction around $150–$300 per square foot, with higher-cost regions exceeding $600.7

The factory unit is only 40–60% of your total. Everything in the next table is the other 40–60% — and it’s exactly what a “starting at” ad leaves out.

The four (really seven) cost layers a unit-only quote hides

Cost layers hidden in a unit-only modular ADU quote
Cost lineIn a true turnkey quote?In a unit-only quote?Why it swings your budget
Factory-built unitYesYesThe visible "starting at" price.
FoundationSometimesUsually missingRequired for permanent, legal, financeable occupancy.
Site prep / gradingSometimesUsually missingSloped or wooded lots can erase the entire factory savings.
Utility hookups (water, sewer/septic, electric, gas)SometimesUsually missingThe biggest swing cost. A long utility lateral gets expensive fast.
Delivery + crane / setSometimesUsually missingEntirely access-dependent. No crane path, no module.
Permits + engineeringSometimesUsually missingModular still requires full local permits and stamped plans.
On-site finish workSometimesUsually missingA set module is not always move-in ready; final tie-ins and trim remain.
Landscaping / repairRarelyUsually missingDriveways, fences, and a torn-up yard often need restoring.
“Site work” is everything done to your land to receive the unit: clearing, grading, the foundation, utility trenching, and the driveway or crane pad. It’s the line item that turns a clean factory price into a real project budget — and it’s almost entirely a function of your specific lot, which is why no honest national page can hand you a single number.
Prefab modular ADU all-in cost breakdown: factory unit price vs. site-work layers including foundation, utilities, delivery, permits, and finish work

Real published pricing (examples, not universal quotes)

All figures verified May 27, 2026 against each provider’s own pricing pages. These illustrate how scope changes the number — not a provider ranking.

  • Abodu publishes California prefab ADU base pricing from $278,800. The base price includes permit services, pre-approved plans, unit delivery and installation, foundation, and standard utility connections — but excludes sales tax and permit fees, utility trenching beyond 50 feet, craning beyond 100 feet, demolition, tree removal, and unique site engineering. Average upgrades range from about $21,700 for the 340-sq-ft Studio to about $52,000 for the 800-sq-ft Two+, with permit fees and taxes averaging roughly $17,000.8
  • Samara publishes Backyard models starting at $152,000 plus installation, with a 950-sq-ft Backyard XL from $277,000 plus installation. Note the explicit “plus installation.”9
  • Studio Home / Studio Shed ships panelized ADUs to all 50 states and select Canada locations, identifying foundation, shipping, and assembly as separate cost items.10
  • BOXABL advertises a foldable Casita on a payment basis (“from $895/mo”) but discloses that the actual price and payment vary by model, location, site work, taxes, delivery, installation, credit approval, and financing terms.11 There is no guaranteed monthly payment.
The cautionary extreme: In higher-cost markets, a $120,000–$150,000 modular quote can finish at $350,000–$450,000 after foundation, septic/sewer, utilities, permits, engineering, and finish work.12 That’s not a scare tactic — it’s what happens when all the hidden layers stack on a difficult lot. The fix is simple: get every line in writing before you sign.

🧮 Quote Checker — the cost lines your quote is probably missing

Use the 7-point checklist and cost-layer table above to audit your quote. For each line below, the answer you need is either “included” or a specific dollar figure — never “that varies” with no number attached.

  1. Foundation (slab, piers, or stem wall) — design AND construction
  2. Site prep and grading — clearing, leveling, soil work
  3. Utility trenching and hookups — exact footage included before extra charges
  4. Sewer or septic — tie-ins or capacity review
  5. Delivery to your specific address — confirmed, not estimated
  6. Crane / set — access requirements and inclusions
  7. Permits, plan check, engineering, impact/school fees, taxes

For brand-by-brand price ranges by size, see our deeper guide: Prefab ADU Cost: Real All-In Prices. To shortlist providers, see Best Prefab ADU Companies.

Is a prefab modular ADU cheaper than building on-site?

Answer: Sometimes, but not automatically. Off-site construction can compress timelines by 20–50% and offers more cost predictability and far less on-site disruption, per the International Code Council. But once equal site work is added, the all-in cost gap between modular and site-built is often smaller than buyers expect — and modular trades away design flexibility.

The honest admission: Prefab modular is marketed as cheaper and faster, and the savings can vanish if your quote excludes site work or your lot has access, slope, septic, utility, or design-review complications. The total order-to-occupancy timeline for factory-built units is often roughly comparable to site-built once factory queues and permitting are counted. The dramatic time savings show up mainly in on-site disruption, not the whole calendar.

Equal-scope comparison: modular vs. site-built

Modular ADU vs. site-built cost and risk comparison
Cost / risk linePrefab modularSite-built
Core unit / build costFixed at contract signing; most predictable lineVariable; exposed to labor and material price swings
FoundationRequired; usually a separate site-work lineRequired; part of the on-site build
Utility trenching (lateral)Same lot-driven cost either waySame lot-driven cost either way
Delivery + crane / setRequired and access-dependentNot applicable (built in place)
Permits + engineeringFull local permits still requiredFull local permits required
Site-access riskHigh — narrow lots, wires, trees can block deliveryLow — crews work in place
Customization riskHigher — catalog footprints; custom is limitedLow — full design flexibility
Financing draw riskFactory deposit may precede on-site progress drawsDraws align with on-site milestones
On-site disruptionWeeksMonths

When prefab modular wins

Flat lot with a level building pad; a clear delivery route and crane staging area; a standard catalog floor plan meets your needs; a genuine all-in scope; your city has a pre-approved or streamlined ADU path; speed of set and fewer months of backyard chaos matter.

When site-built or panelized wins

Narrow or tight lot; no crane reach; mature trees or overhead wires blocking the lift; sloped grade needing engineered foundations; historic district or HOA review; custom footprint; utility or septic complexity; lender draw schedule clashes with factory deposits.

Compare Modular ADU Pricing → See Current Models & What Each Quote Includes

Filter by model, service area, and code path before you commit. Always confirm a provider’s service area, code path, and ADU eligibility for your jurisdiction before paying a deposit.

Explore Modular Home Direct ↗

For the full cost showdown with worked numbers, see Prefab vs. Site-Built ADU Cost.

Will your city allow a prefab modular ADU?

Answer: Most cities that permit ADUs will permit modular ADUs if the unit meets the applicable residential code and local site rules. But “allowed” never means “permit-free.” The city still reviews your site plan, setbacks, utilities, foundation, fire access, and energy code — and “pre-approved plans” approve the building design, not your lot.

The biggest misconception here is that buying a “pre-approved” or “state-approved” model skips local permitting. It doesn’t. A pre-approved plan means the building drawings have already cleared review; your plan check (the city’s review of how that building sits on your parcel) and your site-specific permits still apply.

City feasibility matrix (verified from official sources, May 27, 2026)

City-by-city modular ADU feasibility matrix
MarketModular / prefab pathFast path?The watch-out
San José, CAPreapproved ADU programSame-day permit issuance available for qualifying preapproved ADUs¹⁴Site-specific review still applies to your parcel.
Los Angeles, CALADBS ADU Standard Plan ProgramSimplified permitting for repeatable, pre-reviewed designs¹⁵The standard plan does not remove site-specific review.
Portland, ORPre-approved ADU plansHelpful, but limited¹⁶Still needs zoning, utility connections, flood-hazard review, separate electrical/plumbing/mechanical permits, and possibly system development charges (SDCs).
Seattle, WAPre-approved DADU plansOften permits in 2–6 weeks¹Must meet current building, land-use, and energy codes; tiny houses on wheels are not legal dwellings on city lots.
Austin, TXAdditional Dwelling Units on qualifying SF-1/SF-2/SF-3 lotsStandard building-permit path²Minimum lot area 5,750 sq ft; ADUs built after Oct 1, 2015 limited to 30 days/year of short-term rental.
Truckee, CATown-maintained informational company list (not an endorsement)Vetted by you, not the town¹⁷Extreme snow loads of 170–480+ PSF ground snow load narrow which factory units qualify.
Washington (statewide)GMA jurisdictions must allow ADUs under state lawLocal implementation varies¹⁸Two ADUs/lot in urban growth areas; bars size caps below 1,000 gross sq ft; removes owner-occupancy mandates; caps ADU impact fees at 50% of the principal unit's.
Massachusetts (statewide)Protected-use ADU by rightStatewide baseline⁵Protected-Use ADUs up to ½ the principal dwelling's gross floor area or 900 sq ft allowed by right in single-family zoning; local building, septic, and reasonable site rules still apply.

What “pre-approved” really means

A pre-approved or standard ADU plan means the building design has already passed code review, which can shorten permitting. It does not approve your lot, foundation, utilities, or setbacks — those remain site-specific reviews. Portland’s guidance is explicit that pre-approved plans still require separate electrical, plumbing, and mechanical permits, zoning compliance, utility connections, flood review, and possibly system development charges.16 Treat “pre-approved” as a head start, not a finish line.

Check My Property → Get My Free ADU Report

See your local size limits, setbacks, permit-risk flags, and whether prefab/modular is likely to fit your address — before you call a single builder.

Check My Address Free →

For the rules where you live, see ADU Laws by State and your local city ADU page.

Will a prefab modular ADU physically work on your lot?

Answer: A modular ADU can be perfectly legal on paper and still fail in reality if a truck, crane, foundation, utility route, or climate code overlay doesn’t work. Crane access and lot slope are the two most common deal-killers, and a long utility lateral is the most common budget-buster.

This is the section the glossy provider pages skip, and it’s where deposits get lost. A module is a large, heavy, three-dimensional object that has to be delivered and lifted into place. Physics doesn’t care how nice the floor plan is.

Seven lot-fit checks for a prefab modular ADU delivery: street width, crane reach, overhead wires, side/rear access, slope, utility distance, and code overlays

The 7 lot-fit checks — score each one

Rate each as Pass / Caution / Fail. A single “Fail” can stop a modular project cold — but it usually points you straight to panelized or site-built instead.

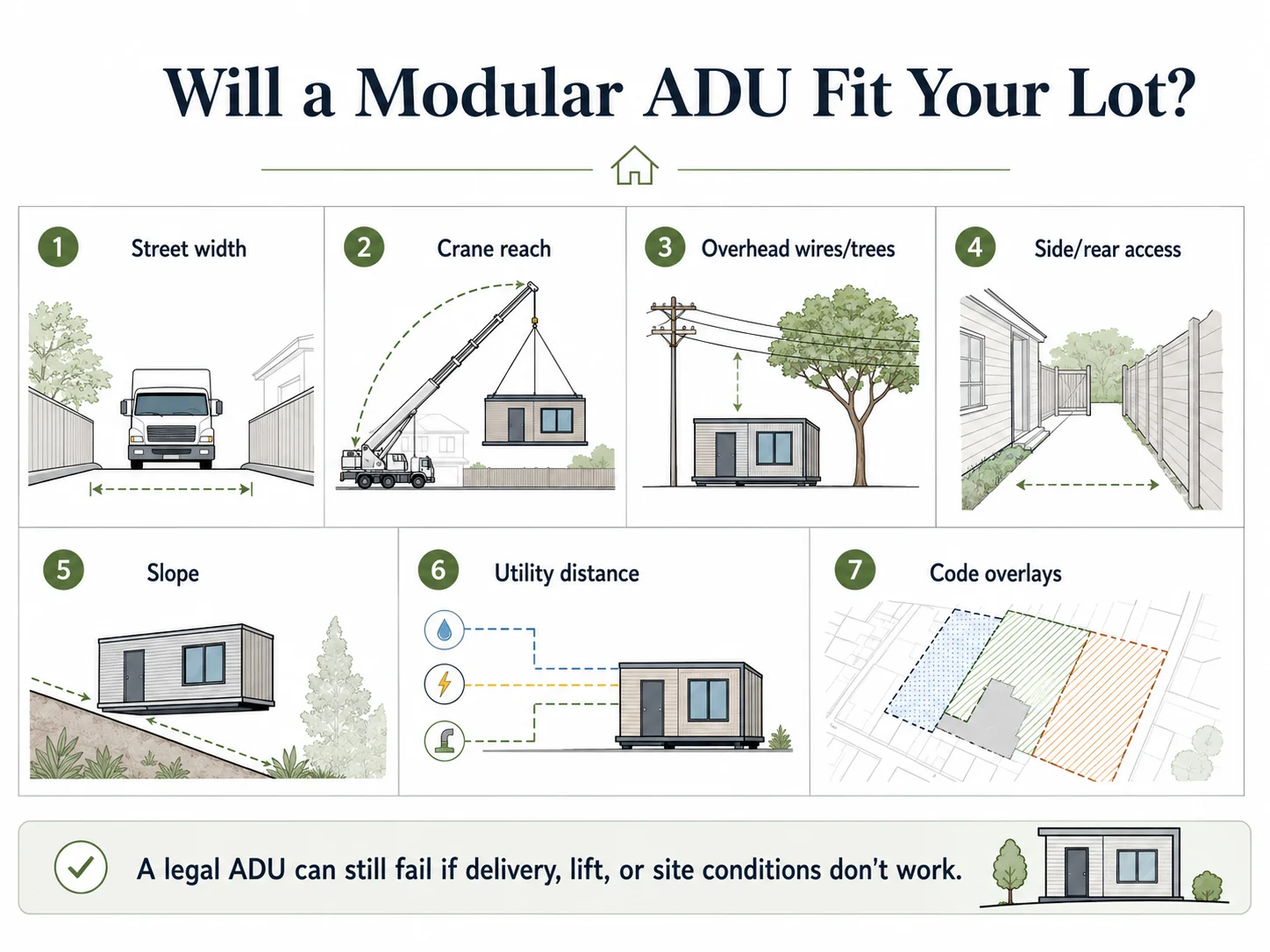

7 lot-fit checks for a prefab modular ADU
CheckWhy it mattersCaution / Fail trigger
Street widthDelivery truck and crane need room to stageNarrow urban street with no staging area
Crane reachThe unit must clear obstacles and reach the padYour main house blocks the crane's reach path
Overhead clearanceTrees and wires block the liftPower lines or a mature tree canopy over the pad
Side / rear accessSome delivery routes need a clear pathNarrow gates, fences, tight side yards
SlopeModular needs a level foundationSteep grade or required retaining walls
Utility lateral distanceTrenching cost rises with every footSewer/water/electric far from the unit location
Code overlaysFire, flood, snow, coastal, or historic rulesA standard catalog unit may not meet them
Climate overlay example: Truckee is the cleanest case we found — the town’s own resource page notes modular and kit ADUs are hard to source there because local ground snow loads run 170 to 480+ PSF — far beyond what a standard catalog module is engineered for.17 Coastal wind zones, wildfire (WUI) requirements, and flood-elevation rules create the same problem elsewhere. Confirm your overlays before you fall in love with a model.

If your lot fails the modular test, here’s your next move

Alternatives when a lot fails the modular ADU test
What failedThe better alternative
No crane pathPanelized (assembles in pieces) or site-built
Sloped lotSite-built or a custom/stepped foundation design
Utility lateral too expensiveGarage conversion, attached ADU, or relocating the pad closer to existing services
HOA / design-review conflictSite-built with a custom exterior to match
Tight budgetA JADU, garage conversion, or panelized quote comparison
Investor plan blocked by short-term-rental rulesUnderwrite for long-term rental, or pick a different market

See What You Can Build at Your Address → Get Your Free ADU Report

We flag crane-access, slope, and utility-distance risks specific to your parcel — so you don’t pay a deposit on a unit your lot can’t physically receive.

Check My Address Free →

Can you finance a prefab modular ADU?

Answer: Yes — and a true modular ADU on a permanent foundation is generally financed like any site-built home, because Fannie Mae’s Selling Guide (B2-3-02) classifies modular, prefabricated, and panelized housing as not manufactured housing when it’s built to local code, permanently attached, and titled as real property. The available path (HELOC, cash-out refinance, construction or renovation loan) depends on your equity, the build method, and the provider’s deposit schedule. This is financing-path education, not a lender ranking — and no rate, payment, or approval is ever guaranteed.

HELOC
A home equity line of credit — a revolving credit line secured by your home's equity.
Cash-out refinance
Replaces your existing mortgage with a larger one and gives you the difference in cash.
Construction-to-permanent loan
Funds the build in stages ("draws") and then converts to a regular mortgage.

Financing-path matrix by build method

ADU financing paths by build method
ADU build typeLikely financing lanesWhat the lender will ask for
Modular ADU (built to IRC/state code)HELOC, cash-out refinance, construction-to-permanent, renovation loanApproved plans, permits, specs, foundation details, signed contract
Panelized ADUHELOC, renovation loan, construction loanGC contract, draw schedule, permits, inspection milestones
Manufactured (HUD-code) ADUManufactured-home-eligible loan; sometimes construction loanHUD label + data plate, permanent-foundation certification, real-property title conversion
Tiny home / RV / park modelSpecialty, chattel (personal-property), or cash; often not mortgage collateralWhether it's even legal housing and classifiable as real property

The factory-deposit trap

Here’s the friction point that surprises even well-prepared buyers: many prefab/modular payment schedules front-load factory payments before your home is finished on-site, while construction loans release money based on inspected on-site progress. Abodu’s published schedule, for example, requires 10% of the unit contract at signing, 40% when manufacturing begins, and the remaining 50% at manufacturing completion — before the separate site-work payment milestones even start.8 Ask both your lender and your provider about deposit timing before you sign, and confirm whether the lender will fund off-site fabrication.

Explore ADU Financing Paths → Compare HELOC, Refinance, and Construction-Loan Options

An independent educational walkthrough of the lanes above. No guaranteed rates, payments, or approvals — just the real documentation and tradeoffs for each path. Routes to our financing hub and Mortgage Research Center.

Compare ADU Financing Paths →

For the full breakdown, see How to Finance a Prefab ADU.

Which prefab modular ADU path fits your situation?

Answer: The right provider path depends less on the prettiest model photo and more on whether the provider’s scope, code path, and service area match your property. We sort this by fit, never by anyone’s payout. Match the service area on every recommendation — a builder that doesn’t serve your county is irrelevant no matter how good it is. (Verify each provider’s current service area and code path before committing; details verified May 27, 2026.)

Provider-fit routing table for prefab modular ADU buyers
Your situationWhere to look nextService-area note
Broad national modular/prefab researchModular Home DirectNationwide research starting point. Not BBB-accredited; unresolved complaints on file — treat as an exploratory lead, confirm contract terms and code path before committing.¹⁹
California turnkey, fixed-price buyerCompare all-in CA turnkey providers (e.g., Abodu-style)California-focused; "base price" still excludes some site work.
Central Coast / Bay Area-adjacent CaliforniaFramework FirstBased in Monterey County; serves general area roughly within 150 miles.²⁰ Outside that radius, not a match.
Wants panelized, no crane, nationwide shippingStudio Home / Studio Shed-style panelized pathShips to all 50 states + select Canada; foundation, shipping, and assembly are separate local costs.
Compact foldable-unit interestBOXABL-specific researchInclude the full price/payment disclaimer; site work, delivery, and installation are extra.
Utah or Southern California tiny-home/ADU buyerNest Tiny HomesUtah (Utah County / Salt Lake / Weber) and Southern California (San Diego / Imperial County) only.
Greater San Diego, lot fails modularSnapADU as a site-built local alternativeGreater San Diego / San Diego County and surrounding areas.

See Current Pricing & Floor Plans → Filter by Model, Service Area, and Code Path

Start your shortlist with options that can actually reach your lot and qualify as an ADU where you live.

Explore Modular Home Direct ↗

To compare companies head-to-head with red flags and fit notes, see Best Prefab ADU Companies.

What should you ask before signing a prefab modular ADU contract?

Answer: Before paying any deposit, get seven things in writing: the unit’s code path, who pulls permits, every cost line that is and isn’t included, delivery and crane requirements, the deposit and payment schedule against your financing, cancellation terms, and the warranty. The most expensive mistakes are locked in at contract signing, not during the build.

The 15-question contract checklist

  1. 1.Is this unit modular, panelized, manufactured (HUD-code), park model, or a tiny home on wheels?
  2. 2.Which building code does it meet — IRC/state, or HUD?
  3. 3.Is it eligible as a legal, permanent ADU in my specific city?
  4. 4.Who confirms zoning, setbacks, and lot coverage?
  5. 5.Who is responsible for pulling permits?
  6. 6.Is the foundation included in this price?
  7. 7.Is site prep / grading included?
  8. 8.Are utility hookups (water, sewer/septic, electric, gas) included?
  9. 9.Is delivery included?
  10. 10.Is crane / setting included?
  11. 11.Who schedules and clears inspections?
  12. 12.What happens — and what's refundable — if the city rejects the plan?
  13. 13.What deposit is due before permit approval?
  14. 14.Does the payment schedule align with my lender's draw schedule?
  15. 15.What, specifically, is excluded from the quoted price?

📥 Download the Free ADU Starter Kit

Get this 15-question contract checklist, a permit-document list, and the first-call questions to ask any provider — delivered by email, no cost.

Get the Free ADU Starter Kit →

What are the biggest prefab modular ADU mistakes?

Answer: The five costliest mistakes are buying the wrong code path, comparing a unit price to an all-in budget, assuming “pre-approved” means permit-free, ignoring crane access, and financing the structure before confirming the site. Each is avoidable with one verification step.

  1. 1

    Mistake 1Believing "installed in one day" means move-in ready

    The crane set can take a day. The certificate of occupancy comes after foundation, utility tie-ins, finish work, and final inspection — typically a multi-month total timeline. "Set in a day" describes the lift, not the project.

  2. 2

    Mistake 2Buying a cheap tiny home that isn't legal housing

    Seattle treats tiny houses on wheels like camper trailers; you can't live in one on a city lot. Confirm permanent-dwelling eligibility in writing before you buy.

  3. 3

    Mistake 3Ignoring local rental restrictions

    If your plan is rental income, the rules govern the math. Austin caps short-term rental of post-2015 ADUs at 30 days per calendar year. Verify your city's rules before underwriting.

  4. 4

    Mistake 4Assuming every lender treats prefab the same

    They don't. The Fannie Mae modular-vs-manufactured distinction decides your loan pool and appraisal form. Get the code path documented before you shop financing.

  5. 5

    Mistake 5Paying a factory deposit before confirming the site

    Zoning, code path, permit responsibility, refund terms, and your financing schedule should all be confirmed first. The deposit is the point of no easy return.

Is a prefab modular ADU good for rental income?

Answer: It can be, but only if the installed cost, local rental rules, financing cost, vacancy, management, taxes, insurance, and market rent all support the project. Model returns from the installed cost and legal rent — never from the advertised unit price.

Monthly rent − vacancy reserve − utilities/maintenance − insurance/taxes/management − financing cost = your real monthly operating picture.

The single biggest mistake here is underwriting off the sticker price. A unit that pencils beautifully at a $150,000 sticker may not pencil at a $300,000 all-in basis. This table shows roughly how much rent you’d need just to cover financing at different all-in costs — before operating expenses — using an illustrative 30-year term at an 8% annual rate.

Illustrative rental income coverage by all-in cost
All-in installed costIllustrative monthly financing cost (30 yr, 8%)Rough rent needed before operating expenses
$200,000~$1,470$1,800–$2,200+
$300,000~$2,200$2,700–$3,300+
$400,000~$2,940$3,600–$4,400+

These are illustrative examples, not guarantees of returns. Actual results depend on local market conditions, construction costs, financing terms, and regulatory approvals.

Prefab Modular ADU FAQ

Is a prefab modular ADU the same as a manufactured home?
No. Per Fannie Mae's Selling Guide B2-3-02, modular, prefabricated, panelized, and sectional housing "is not considered manufactured housing" and is treated like site-built housing when built to local code, permanently installed, and classified as real property. Manufactured (HUD-code) homes follow a separate, stricter set of rules.
Do prefab modular ADUs need permits?
Yes. Even pre-approved or "standard plan" designs still require site-specific local approvals, permits, inspections, and utility review. Pre-approval shortens the building-design review; it does not approve your lot.
Is a prefab modular ADU cheaper than site-built?
Sometimes, not automatically. Compare installed cost, not unit price. Off-site construction can save 20%+ and compress timelines 20–50% under favorable conditions, but site work, lot difficulty, and the factory-queue plus permit timeline can close the gap.
Can I put a prefab ADU in my backyard?
Maybe — it depends on zoning, setbacks, lot coverage, the unit's code path, foundation, utility distance, and physical access for a truck and crane. Run a feasibility check on your specific address first.
Can I finance a prefab modular ADU?
Often yes. A true modular unit on a permanent foundation can typically use a HELOC, cash-out refinance, or construction/renovation loan. The path depends on your equity, the code path, permit status, and whether the provider's deposit schedule aligns with your lender's draw schedule.
What's the biggest hidden cost?
Site-specific work — foundation, utility trenching (the "lateral"), sewer/septic, grading, crane/delivery, or an electrical-service upgrade. These layers commonly add 40–60% to the factory price.
Are tiny homes on wheels ADUs?
Usually not as permanent ADUs, unless your jurisdiction specifically allows them. Seattle treats tiny houses on wheels like camper trailers and prohibits living in them on city lots.
What's the fastest city permitting path?
Cities with pre-approved or standard-plan programs are quickest. San José offers same-day permit issuance for qualifying preapproved ADUs; Seattle's pre-approved DADU plans often permit in 2–6 weeks. Site-specific review still applies.
What if my lot has no crane access?
Compare a panelized ADU (assembled on-site in flat pieces) or site-built construction. Neither depends on a crane-set module.
Should I pay a prefab deposit before checking permits?
No. Confirm zoning, code path, permit responsibility, refund/cancellation terms, and your financing schedule first. The deposit is the hardest dollar to get back.

How we researched this guide

  • Official / legal sources: Fannie Mae Selling Guide (B2-3-02 dated 02/04/2026; B4-1.4-02 dated 10/06/2021); HUD Manufactured Home Construction and Safety Standards (24 CFR Part 3280); official planning/building pages for San José, Los Angeles (LADBS), Seattle (SDCI), Portland, Austin, and Truckee; MRSC (Washington) and Mass.gov (M.G.L. c. 40A, Affordable Homes Act, Ch. 150 of the Acts of 2024).
  • Provider pricing: Abodu, Samara, Studio Home / Studio Shed, and BOXABL pricing pages, used to demonstrate the unit-vs-installed scope difference.
  • Cost-range data: published cost guides (Angi, HomeGuide, AmeriSave, 2025–2026), reconciled to separate module-only pricing from all-in installed pricing.
  • Voice-of-customer: Reddit and Houzz homeowner threads — used only to understand real questions and objections, never as a source for costs, codes, or laws.
  • Editorial judgment: fit recommendations weigh code path, lot fit, scope transparency, and service-area match — never advertiser payment.
  • Update cadence: provider pricing monthly to quarterly; laws and permit rules quarterly and after agency updates; financing rules after Fannie/Freddie/FHA changes.

The Dwelling Index is an independent research resource covering ADU financing, costs, and regulations. We did not use AI-generated reviews, fabricated testimonials, or invented expert credentials anywhere on this page. This guide is educational and is not legal, financial, tax, or construction advice. Verify all information with qualified local professionals before making decisions.

Sources

  1. City of Seattle, SDCI — Accessory Dwelling Units (DADU pre-approved plans permit in ~2–6 weeks; tiny houses on wheels treated as camper trailers). seattle.gov/sdci. Verified May 27, 2026.
  2. City of Austin — Additional Dwelling Units (SF-1/SF-2/SF-3; 5,750 sq ft minimum lot; post-Oct 1, 2015 STR 30-day cap). austintexas.gov. Verified May 27, 2026.
  3. Fannie Mae Selling Guide, B2-3-02, Special Property Eligibility and Underwriting Considerations: Factory-Built Housing (dated 02/04/2026). selling-guide.fanniemae.com. Verified May 27, 2026.
  4. HUD — Manufactured Home Construction and Safety Standards, 24 CFR Part 3280. hud.gov. Verified May 27, 2026.
  5. Commonwealth of Massachusetts — M.G.L. c. 40A §1A (Affordable Homes Act, Ch. 150 of the Acts of 2024): Protected-Use ADUs ≤ ½ principal dwelling GFA or 900 sq ft; modular/prefab must be allowed if code-compliant. mass.gov. Verified May 27, 2026.
  6. AmeriSave — 2026 modular home pricing breakdown (modules ≈ 40–60% of final cost; installed ≈ $80–$160/sq ft). amerisave.com. Verified May 27, 2026.
  7. Angi — How Much Does an ADU Cost to Build? [2026 Data] (≈ $150–$300/sq ft; high-cost regions $600+). angi.com. Verified May 27, 2026.
  8. Abodu — Pricing & Models (base from $278,800; inclusions/exclusions; payment schedule 10%/40%/50%). abodu.com/pricing. Verified May 27, 2026.
  9. Samara — Backyard Models (from $152,000 + installation; Backyard XL from $277,000 + installation). samara.com. Verified May 27, 2026.
  10. Studio Home / Studio Shed — ADU cost & financing (ships to all 50 states + select Canada; foundation/shipping/assembly separate). studio-home.com. Verified May 27, 2026.
  11. BOXABL — Casita order page ("from $895/mo" with price/payment-varies disclaimer). boxabl.com. Verified May 27, 2026.
  12. Builder hidden-cost breakdown (higher-cost market): $120K–$150K modular quote finishing at $350K–$450K after site work. Cited as an illustrative extreme. Verified May 27, 2026.
  13. International Code Council — Off-Site Construction (timelines accelerated 20–50%; 20%+ potential cost savings under favorable conditions). iccsafe.org. Verified May 27, 2026.
  14. City of San José — Preapproved ADUs (same-day permit issuance for qualifying preapproved ADUs). sanjoseca.gov. Verified May 27, 2026.
  15. City of Los Angeles, LADBS — ADU Standard Plan Program. dbs.lacity.gov. Verified May 27, 2026.
  16. City of Portland — Pre-approved ADU plans (separate trade permits, zoning, utilities, flood review, possible SDCs still apply). portland.gov. Verified May 27, 2026.
  17. Town of Truckee — Modular and Kit ADUs (informational company list; 170–480+ PSF ground snow load). townoftruckee.gov. Verified May 27, 2026.
  18. MRSC — Accessory Dwelling Units, Washington (two ADUs/lot in GMA urban growth areas; no size cap below 1,000 gross sq ft; no owner-occupancy; impact fees capped at 50%). mrsc.org. Verified May 27, 2026.
  19. Better Business Bureau — Modular Home Direct (South Salt Lake, UT): not BBB-accredited; unresolved complaint(s) on file. bbb.org. Verified May 27, 2026.
  20. Framework First — service area (based in Monterey County; general area ~150 miles). frameworkfirst.com. Verified May 27, 2026.

Our bottom-line verdict

Prefab modular ADUs are the best choice for straightforward lots where the unit’s code path, delivery access, provider scope, and city review all line up. They become risky when a buyer compares a sticker price to an all-in budget, buys a non-residential tiny home expecting it to count as housing, or pays a deposit before zoning, utilities, foundation, and financing are verified. Get the three foundations right — code path, all-in scope, lot access — and a modular ADU behaves like the smart, financeable, real-estate asset it is.

Not sure where to start? See what’s possible at your address — get your free ADU report in 60 seconds.

Get Your Free ADU Report →
