Turnkey Prefab ADU: 32-Point Scope Matrix, Real 2026 Costs & Quote Checklist

Last updated: May 28, 2026 · Last verified: May 28, 2026 · By The Dwelling Index Editorial Team · 20+ sources cited

The short answer.

“Turnkey” is a marketing word, not a legal definition. A real turnkey prefab ADU includes one accountable company, a written scope covering all 32 line items in this guide, a fixed total-project price, and the builder named on the permit. In 2026, real all-in turnkey pricing runs $200,000–$500,000+ for a 340–1,200 sq ft unit. Verified Abodu base prices: Studio $278,800, One $326,800, Two $360,800, Two+ $426,800, Dwell House $439,000 — all before approximately $17,000 average in permit fees and sales tax. The $99K–$150K ads you see are almost never all-in; the gap between unit price and project price is typically $80K–$160K. The 32-line Scope Verification Matrix below is the tool that closes that gap.

See What You Can Build → Get Your Free ADU Report

Reader-supported. The Dwelling Index is an independent research resource covering ADU financing, costs, and regulations. When you use our links to explore builder pricing or financing options, we may earn a commission at no extra cost to you. Our editorial recommendations are based on independent research and are never influenced by compensation. Full disclosure →

Modern turnkey prefab ADU installed in a suburban backyard.

1. What “Turnkey” Actually Means in the Prefab ADU Market

“Turnkey” means one company is contractually responsible for everything from your lot to a livable, permitted, connected ADU — with a fixed price and one phone number when something goes wrong. It does not mean cheap. It does not mean simple. And it is not a legally defined term, which is why the same word is applied to three very different service models.

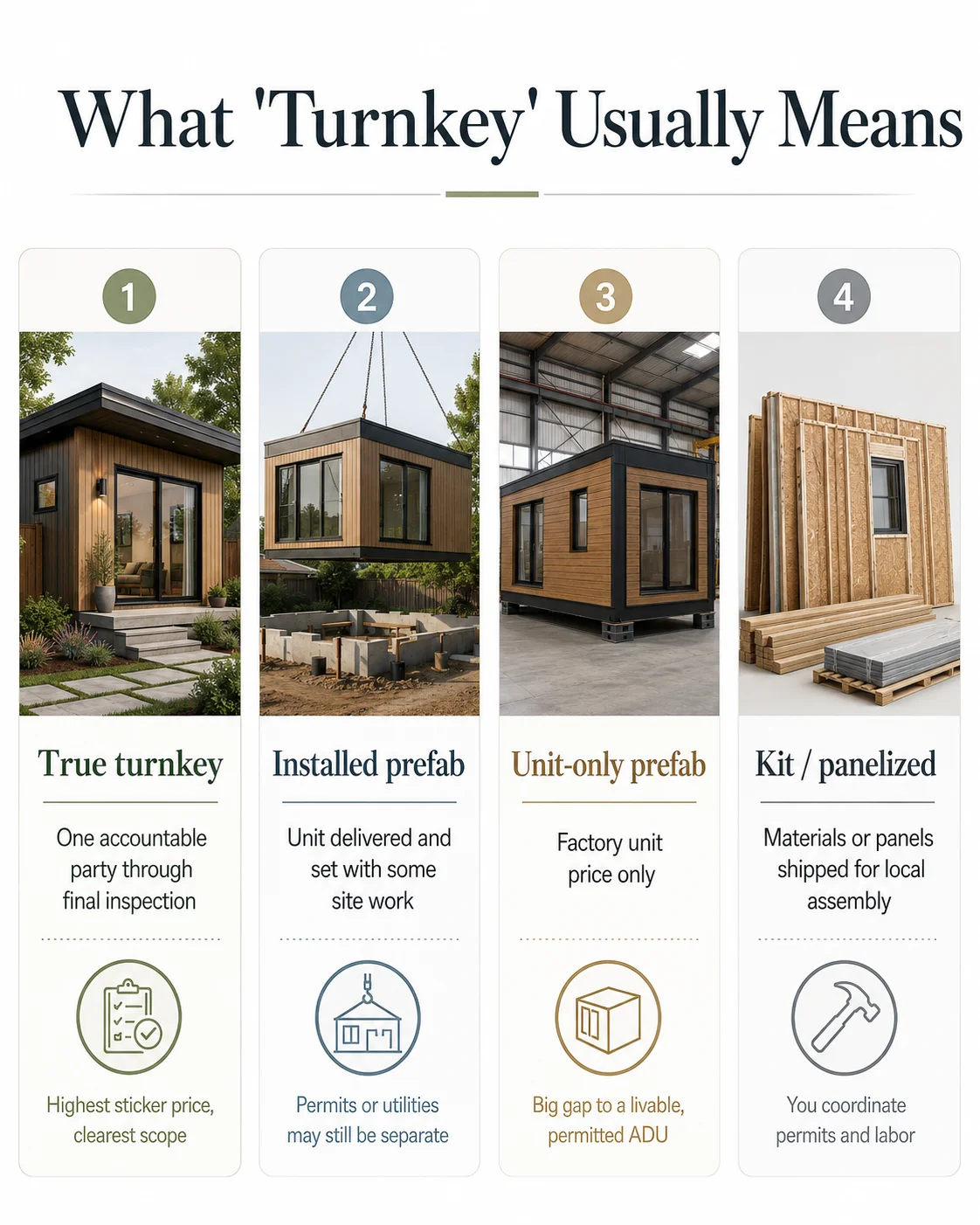

Three prefab ADU service models compared: unit-only kit, installed semi-turnkey, and true turnkey.

The three service models that get called “turnkey”

ModelWho’s accountableWhat’s includedWhat you coordinate
Unit-only (product sale)Manufacturer for the unit onlyFactory-built module or shellEverything else — foundation, permits, utilities, finishes, inspection, labor coordination
Semi-turnkey (installed)Builder for unit + install; you manage the gapsUnit, delivery, set, partial site workPermit fees, some site work, utility upgrades, finish coordination
True turnkeyOne company for the full project scopeDesign, permits, foundation, manufacturing, delivery, crane, utilities, finishes, COInformed decisions about model, options, and exclusions

Verified against builder published service descriptions, May 28, 2026.

The distinction matters because the same word is used across all three. A builder marketing “turnkey delivery” may mean only that it will crane the unit onto your lot. The only way to know which model you’re buying is the 32-line Scope Verification Matrix in Section 2.

Before you get any quote, confirm what your lot can actually hold.

The Scope Matrix tells you what should be in a turnkey contract. The Feasibility Engine tells you what your specific lot can support — setbacks, utility access, slope, and which builders actually deliver to your zip code.

See What You Can Build → Get Your Free ADU Report

2. The 32-Line Turnkey Scope Verification Matrix

Print this. Take it to your next builder meeting. Go down the list one row at a time and confirm in writing which column each item lands in for your specific quote. Any builder that won’t answer in writing has just told you the quote isn’t truly turnkey.

Column key: Always IN = included in real turnkey contracts • Sometimes IN = site-dependent, verify in writing • Usually OUT = almost always outside base scope, paid separately

#Scope Line ItemAlways INSometimes INUsually OUT
1Architectural design and floor plan
2Title report / lot survey⚠️
3Structural engineering
4Geotechnical / soil testing⚠️
5Permit application & plan check submission
6City permit fees (the actual dollar amount paid to the city)⚠️
7School impact fees
8Park / traffic / development impact fees
9Demolition of existing structures or fences⚠️
10Tree removal
11Grading & site preparation
12Foundation (slab, stem wall, or pier)
13Manufacturing of the unit
14Title 24 / state energy-code compliance
15Solar (where required by code)⚠️
16Delivery / transport to site
17Crane / set day
18Police escort or oversize-load permits⚠️
19Street closure / traffic control⚠️
20Utility trenching from primary home to ADU (up to a footage cap)
21Trenching beyond included footage⚠️
22Electrical panel upgrade on the primary home⚠️
23New water meter or submeter⚠️
24Sewer lateral upgrade in the public right-of-way
25Septic system addition or expansion⚠️
26HVAC equipment + installation
27Interior finishes (flooring, cabinets, counters)
28Appliances⚠️
29Final inspection coordination & certificate of occupancy
30Property-tax reassessment
31Sales tax on the unit (where applicable)
32Owner-initiated change orders

Sources: Abodu published pricing and exclusions on abodu.com/pricing (verified May 28, 2026, which explicitly lists “Sales tax and permit fees,” “Utility trenching beyond 50 ft,” “Craning beyond 100 ft,” “Building or structure demolition,” “Tree removal,” and “Unique site engineering” as excluded); Villa Homes service descriptions; Cover FAQ (buildcover.com/faq, verified May 28, 2026); Bay Modular pricing pages; BOXABL Casita and order pages; Samara starting price and process; LSTK construction-contract standard.

🛠️ Free Tool: Turnkey Prefab ADU Quote Checker

Paste or enter your quote details and the Quote Checker returns a turnkey completeness score (out of 32 line items), the missing scope items flagged for follow-up, and the exact questions to ask the builder before you pay a deposit.

Check My Quote → See What’s Missing Before You Sign

Free. No email required. Your inputs stay on your device.

Before You Get Another Quote, Check What Your Lot Can Actually Hold

The Matrix tells you what should be in a turnkey contract. The Feasibility Engine tells you what your specific lot can support — setbacks, utility access, slope, jurisdiction rules, and which builders actually deliver to your zip code. Most blown-budget stories start with a lot the homeowner didn’t pre-screen.

See What You Can Build → Get Your Free ADU Report

Free. 60 seconds. No credit card. No sales call unless you ask for one.

3. How Much a Real Turnkey Prefab ADU Costs in 2026

A real turnkey prefab ADU in 2026 typically costs $200,000–$500,000+ all-in for a 340–1,200 sq ft unit, depending on size, region, and site conditions. Unit-only quotes start as low as $50,000 but exclude every other line in the Scope Matrix above. Sub-$150,000 prefab pricing is almost always product-only, not all-in. The gap is where homeowner budgets break.

Quick all-in ranges by size

Unit SizeReal Turnkey All-In Range (2026)What Pushes You to the Top of the Range
300–500 sq ft$180,000–$300,000California, dense urban lot, long utility runs, panel upgrade
500–800 sq ft$230,000–$420,000Multi-bath layout, premium finishes, coastal zone, sloped lot
800–1,200 sq ft$300,000–$500,000+Two-bath / two-bedroom layouts in CA, PNW, Northeast

Ranges reflect national variation. California, the Pacific Northwest, and the Northeast trend higher than the Sun Belt and Midwest. For full line-by-line analysis, see Prefab ADU Cost: Real All-In Prices →

Verified 2026 turnkey pricing from named builders

Real published numbers pulled from each builder’s official pricing page or verified third-party reporting, verified May 28, 2026. Builders sorted alphabetically.

Builder / ModelStarting / Base Price (2026)Unit SizeWhat’s Included / Notable ExclusionsService Area
Abodu StudioBase $278,800 / Avg $300,500340 sq ftProject manager, complete unit, permit services, pre-approved plans, delivery, install, foundation, standard utility connections. Excludes ~$17K avg permit fees & sales tax, trenching beyond 50 ft, craning beyond 100 ft, demolition, tree removal, unique site engineering.California
Abodu OneBase $326,800 / Avg $352,500500 sq ft, 1 BRSame scope; ~$17K permit fees & taxes excluded.California
Abodu TwoBase $360,800 / Avg $392,500610 sq ft, 2 BRSame scope; ~$17K permit fees & taxes excluded.California
Abodu Two+Base $426,800 / Avg $478,800 (~$495,800 all-in)800 sq ft, 2 BR / 2 BASame scope; avg upgrades + $17K fees = ~$495,800 before non-standard excluded scope.California
Abodu Dwell HouseBase $439,000 / Avg $498,500540 sq ft, 1 BRSame scope; ~$17K permit fees & taxes excluded.California
Villa HomesRequires Feasibility Study; ~$95K–$195K unit / ~$200K–$360K+ all-in (3rd-party est.)450–1,200 sq ft, 1–3 BRADU + permitting, delivery, site work, install, utility hookups.CA (LA, Bay Area, expanding)
Samara$152,000 starting (unit cost) — installation separate420 sq ft Studio → 950 sq ft 2 BR / 2 BADesign, site proposal, permits, manufacturing, site readiness. Installation costs add separately.California
CoverCustom-priced; fixed after engineeringVariesFull process from permitting to move-in; permit guarantee in service area. Two-story available. Targets 4 months.Southern CA (SLO, Kern, San Bernardino, Santa Barbara, Ventura, LA, Orange, Riverside, San Diego, Imperial)
Bay ModularQuote-based; permitting ~8% of construction costMultiple ADU modelsLicensed CA housing manufacturer; handles permitting; works with local contractors on foundations and utilities.Bay Area, CA
BOXABL CasitaDirect quote required; financing-based monthly estimates publicly shownStudio 361 sq ft; 1 BR 722 sq ft; 2 BR 722 sq ftBuilt to residential building code. 2-Bedroom received CA state approval Dec 2025. Verify state/local availability.Expanding nationally
Studio Home (Summit Series)$98,029–$191,523308–1,000 sq ftNationwide delivery & assembly. Verify permits, foundation, utility hookups, and local inspection before comparing to all-in quotes.Nationwide delivery & assembly
Modular Home Direct$56,500–$116,000+284–800+ sq ftUnit pricing only. Nationwide GC Search for local contractors. Verify foundation, permits, utilities, local code compliance separately.National catalog
SnapADU (site-built turnkey alternative)$300,000–$450,000+ all-in400–1,200 sq ftFull design-build, permits, foundation, structure, utilities, finishes, inspection.Greater San Diego County

All prices verified at each source on May 28, 2026. Builder pricing changes — confirm directly with the builder before signing anything.

Why “starting at $99,000” ads are almost never turnkey

A factory-built modular unit shell costs roughly $30K–$80K to produce. Once margin is added, the unit retail price lands at $70K–$200K — the number the ads quote. The remaining work (foundation $8K–$40K, site prep $10K–$30K, utility trenching $10K–$25K, permit fees $5K–$15K, crane and set $5K–$15K, interior finishes $15K–$40K) runs another $60K–$160K depending on site conditions. That’s how a $99,000 ad becomes a $200,000 reality. This isn’t fraud. It’s the difference between unit price and project price, dressed up by marketing departments that know “starting at $99K” gets the click.

One counterintuitive cost lesson: a 340 sq ft turnkey ADU isn’t half the price of a 700 sq ft turnkey ADU. The unit cost scales with size, but foundation, permitting, utility trenching, electrical panel work, crane, delivery, and inspection fees are largely fixed. Per Abodu’s verified 2026 base pricing, the 340 sq ft Studio is $278,800 and the 610 sq ft Two is $360,800 — the larger unit is 79% bigger but only 29% more expensive. That’s why per-square-foot pricing for the smallest prefab units often runs higher than for mid-sized ones.

4. How Long a Turnkey Prefab ADU Actually Takes

A turnkey prefab ADU typically takes 3–9 months from contract signing to certificate of occupancy. Specific builder timelines: Cover targets ADU completion in as little as 4 months; Abodu’s published payment schedule targets six to eight months from signed contract to move-in; Samara says backyards can be ready in “as few as eight weeks on site” after earlier design/permit phases. A comparable site-built ADU usually runs 8–14 months.

The reason prefab compresses the timeline is parallel-track scheduling: the factory builds the unit at the same time your local crew is pulling permits, surveying the lot, pouring the foundation, and running utility trenches. In site-built construction, those phases run sequentially. The prefab advantage is mostly in calendar time, not labor hours.

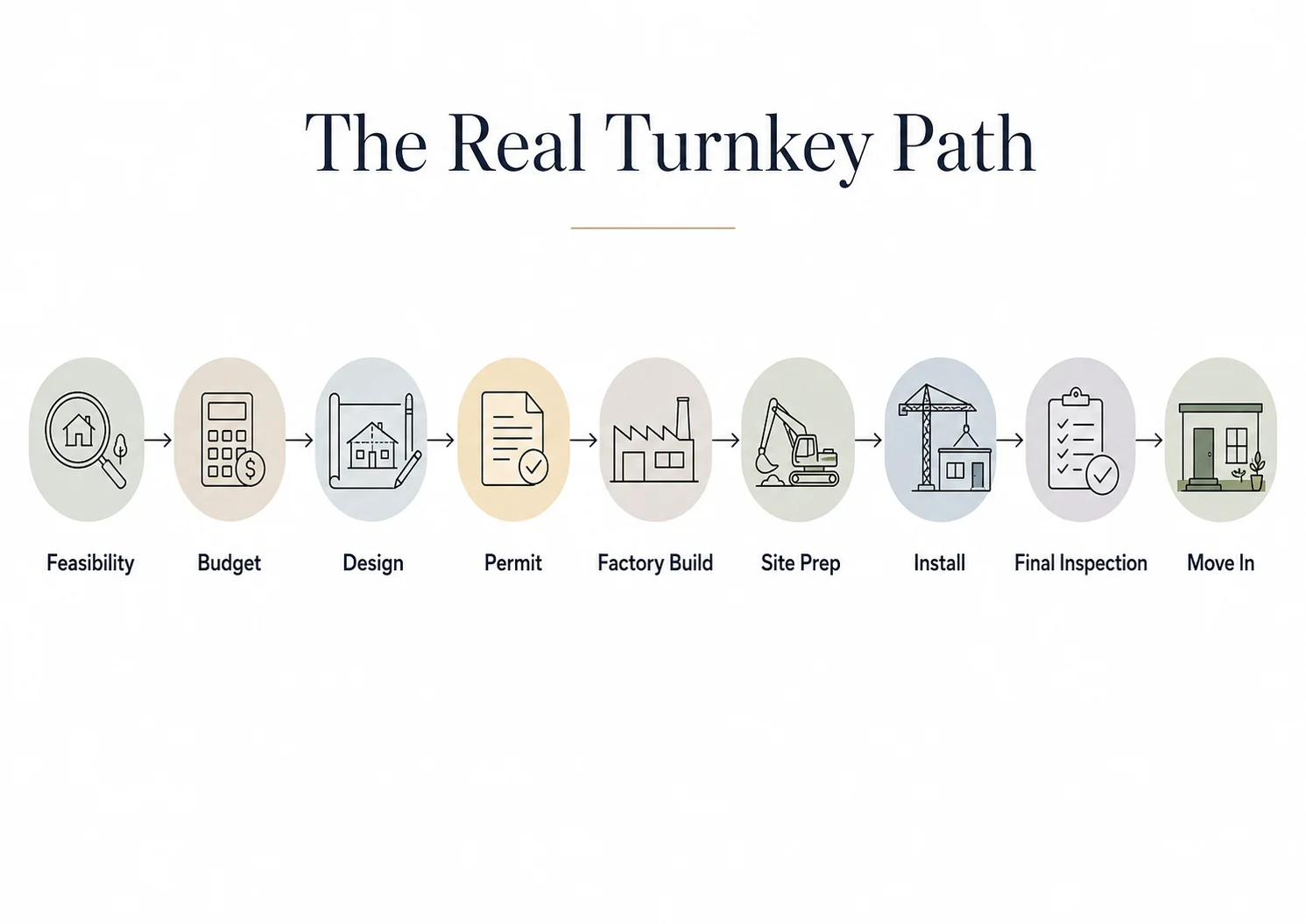

The seven phases of a real turnkey timeline

PhaseTypical DurationCommon Delay Triggers
1. Feasibility & design2–6 weeksLot constraints discovered late; HOA review
2. Permit application & plan check4–12 weeksCity correction cycles; coastal or fire-overlay review
3. Factory manufacturing (parallel to permits & site prep)6–14 weeksProduction queue at the factory; supply-chain issues
4. Site prep & foundation (parallel)2–4 weeksSoils surprises; sewer or utility location issues
5. Delivery & crane set day1 day to 1 weekOversize-load permits; street closure; tree clearance
6. Final hookups, finishes, inspections3–8 weeksCity inspection backlog; correction items
7. Certificate of occupancy1–4 weeksInspection scheduling
Turnkey prefab ADU timeline showing seven phases from feasibility through certificate of occupancy.

Where the timeline really stretches: any phase not in the builder’s direct control. City plan check is the most common culprit. California’s 60-day shot clock under Government Code §66317 requires ministerial approval of complete ADU applications, but “ministerial” doesn’t mean instant — cities still issue corrections, and corrections take weeks. SB 543 (effective October 2025) added a 15-business-day completeness review requirement.

California’s permit accelerators (AB 1332, AB 818, AB 462)

If you’re in California, ask any turnkey builder whether they have HCD-approved plans and whether your city accepts them via a pre-approved-plan program. Those two answers can shorten your permit timeline by months.

5. Which Prefab ADU Companies Offer Real Turnkey Service

A company is only “turnkey” for your project if it serves your location and gives you a written total-project scope covering permits, site work, foundation, delivery, placement, utility hookups, inspections, and closeout. The table below scores active builders against the most material turnkey scope criteria, sorted alphabetically, based on each builder’s published service description as of May 28, 2026.

Affiliate disclosure (before the comparison table): Some links in this section go to affiliate partners (clearly marked). We did not rank by payout. This table is sorted alphabetically. Scoring reflects each builder’s publicly stated scope; your specific contract may include more than the marketing suggests. Always verify in writing.

The Turnkey Scope Comparison Table

BuilderFixed-Price Total Scope?Foundation Incl.?Permitting Incl.?Utility Trenching?Crane / Set?Finishes Incl.?Service Area
Abodu✅ (fees ~$17K avg billed separately)✅ (within 50 ft)✅ (within 100 ft)California
Bay Modular⚠️ Partial⚠️ Coordinated locally⚠️ CoordinatedBay Area, CA
BOXABL Casita⚠️ Verify⚠️ Verify locally⚠️ Verify locally⚠️ Verify locallyNational (verify state/local)
Cover✅ (permit guarantee)All of Southern CA (10 counties)
Samara✅ unit; ⚠️ install separate⚠️ Install separate⚠️ Part of process⚠️ Site-dependentCalifornia
Studio Home (Summit Series)Unit price only⚠️ PartialNationwide delivery & assembly
Villa HomesCA (LA, Bay Area, expanding)

Verified at each builder’s official site on May 28, 2026. ⚠️ = scope varies by site or contract; always verify in writing. Modular Home Direct excluded from this scored table because its catalog is product-only. Studio Home included because it uses “turnkey” language while being a unit-only product; the table makes that distinction visible.

Red flags inside a “turnkey” claim

Find a Region-Matched Builder or Prefab Starting Point

Not every prefab builder ships nationwide, and not every nationwide shipper installs locally. These are our active partners, geo-matched. We don’t rank by payout — we route by service-area fit.

Affiliate disclosure: These are our active partners. We earn a commission if you request a quote or place an order, at no extra cost to you. Service-area accuracy verified May 28, 2026.

  • Greater San Diego County (turnkey site-built alternative): SnapADU → — serving San Diego, Oceanside, Carlsbad, Encinitas, Del Mar, Solana Beach, Poway, San Marcos, Escondido, La Mesa, El Cajon, Vista, Chula Vista, Rancho Santa Fe, Santee, Lemon Grove, Imperial Beach, National City, and unincorporated San Diego County.
  • California Central Coast / Monterey / Bay Area-adjacent (~150 miles): Framework First → — family-owned modular ADU builder with 40+ years of building experience.
  • Utah and Southern California: Nest Tiny Homes → — Utah County, Salt Lake, Weber County, and San Diego / Imperial County.
  • National modular/prefab catalog: Modular Home Direct → — transparent unit pricing; verify local permitting, foundation, and utility scope separately.
  • BOXABL-specific (compact, foldable Casita): BOXABL Casita → — Studio 361 sq ft, 1BR/2BR layouts at 722 sq ft.

6. The 4-Question Test for Fake-Turnkey Quotes

If a builder labels their quote “turnkey,” ask these four questions before signing anything. A real turnkey builder will answer all four in writing without hesitation. A fake-turnkey builder will hedge on at least two. The test takes about ten minutes to run.

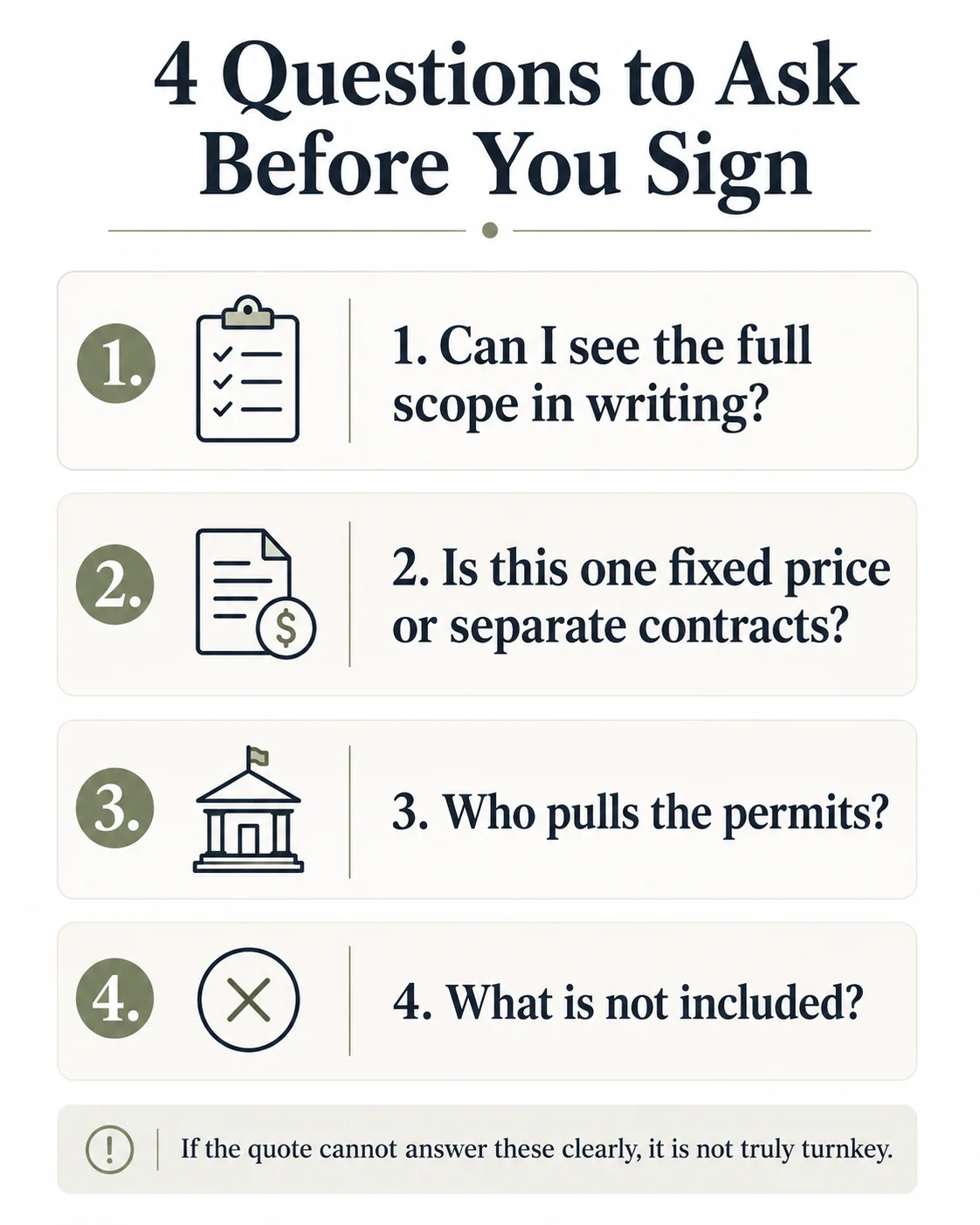

4 Questions to Ask Before You Sign a Turnkey Prefab ADU Contract

Question 1 — “Can I see the full scope of work in writing, line by line, before I pay any deposit?”

A real turnkey builder publishes or sends a formal scope document covering the 32 line items in Section 2 above. A fake-turnkey builder sends a one-page summary that lists “unit,” “site work,” and “permits” as if each is a single bullet.

What an honest answer looks like: a multi-page scope document listing 20+ specific items, what’s included, and what’s excluded with stated assumptions. What a dishonest answer looks like: “Everything is included — we’ll go over it on the call.”

Question 2 — “Is the total project price fixed in writing, and is one company accountable for the entire scope?”

Fixed-price total accountability is the core of turnkey. If the answer is “the unit price is fixed, and then your local GC handles everything else,” you’re buying a product, not a turnkey project. The “local GC” is your coordination risk.

What an honest answer looks like: a single contract (or two co-signed contracts with one project manager) naming the builder as the fixed-price responsible party for the full scope. What a dishonest answer looks like: a unit contract with separate “recommendations” for local contractors to handle the rest.

Question 3 — “Who pulls the permits, and who pays the city fees?”

In a real turnkey project, the builder is the named applicant on the city permit. If the answer is “you file the permit, we provide the plans,” you are managing the permit process — and if the city pushes back, you are the one spending evenings decoding the corrections.

City fees are typically separate line items even in real turnkey contracts (Abodu’s ~$17K average for permit fees and sales tax is the cleanest published example). But who pays whom and on what timeline should be explicitly specified.

Question 4 — “What specifically is excluded from this price?”

Every honest turnkey builder has a published or written exclusion list. Abodu’s is on its pricing page: sales tax, permit fees, trenching beyond 50 ft, craning beyond 100 ft, demolition, tree removal, unique site engineering. If a builder doesn’t give you a specific exclusion list, the exclusion list is “everything that costs more than we thought it would.”

Have a quote? Run it through the free Quote Checker.

The tool scores your quote against all 32 scope items and returns the specific questions you should ask before signing — in about 2 minutes.

Check My Quote → See What’s Missing Before You Sign

7. Permits, State Law, and the Code That Governs Your Unit

Prefab ADUs still require local permits. State laws have made ADU approval easier in many jurisdictions, but your specific property still has to satisfy local zoning, setbacks, utility capacity, access, fire rules, design standards, and building-code requirements. State law sets the floor; cities and HOAs build on top of it.

StateWhat the State Law SetsWhat Your City Still Decides
CaliforniaGov. Code Ch. 13: §66317 (60-day ministerial approval); §66321 (max size 850 sq ft studio/1BR, 1,000 sq ft 2BR+); §66323 (state-exempt categories up to 800 sq ft); §66313 (manufactured homes included); §66329 (60-day coastal CDP per AB 462); SB 543 (Oct 2025) school fee exemption for ADUs ≤500 sq ftSetback overlays, height in specific zones, lot coverage/FAR, utility capacity, WUI fire standards, lawful design review, HOA review where permitted
WashingtonHB 1337 / RCW 36.70A.680: allows at least two ADUs per residential lot in planning cities within urban growth areas; limits on parking and owner-occupancy requirementsDimensional standards, design standards, fees
OregonORS 197A.425: qualifying cities must allow at least one ADU per single-family dwelling in eligible UGB areas; cannot require off-street parking or owner-occupancy. ORS 197A.425(2) preserves local authority to regulate vacation occupancies.Vacation/STR regulation, dimensional standards, design standards
MassachusettsAffordable Homes Act: one protected-use ADU by right in single-family zoning; size limit commonly cited at 900 sq ft or 50% of primary dwelling (whichever smaller); building code review and Title 5 septic where applicableSeptic compliance, dimensional standards, lawful local design rules
ColoradoHB24-1152: requires subject jurisdictions (after June 30, 2025) to allow one ADU as an accessory use to a single-unit detached dwelling wherever single-unit detached dwellings are allowedLocal dimensional standards, design rules, fees

Modular vs. manufactured vs. tiny home: the code difference that matters

Want to Know Whether Your Lot Qualifies?

State law tells you what cities must allow. Your city tells you what your lot can hold. We pull both together in 60 seconds, with no sales call attached.

See What You Can Build at Your Address → Get Your Free ADU Report

Free. No credit card. Powered by independent zoning and utility data.

8. Is Turnkey the Right Path for You? A 6-Question Decision Tree

Turnkey isn’t always the right model. It costs more than coordinating contractors yourself, offers less customization than site-built, and most prefab builders are limited on configurations like two-story ADUs (though some, like Cover, do offer two-story builds). The decision comes down to six questions about your time, your tolerance for risk, your lot, and your timeline.

1. Do you have time to project-manage 6–14 subcontractors yourself?

If yes, semi-turnkey or DIY-coordinated typically saves 10–20% versus full turnkey. You’ll hire a foundation contractor, a GC, an electrician, a plumber, a roofer, a finish carpenter, an inspector liaison, and a permit expediter. If managing that many vendors stresses you out — or if your day job won’t accommodate it — turnkey is the time-buy.

2. Is your lot a standard, flat, accessible site?

Turnkey pricing assumes a normal site. Steep slopes, narrow access for delivery trucks and cranes, long utility runs, mature trees blocking the install path, or coastal-zone overlays can blow up “fixed” prices through change orders. Abodu explicitly excludes trenching beyond 50 feet and craning beyond 100 feet. If your lot is unusual, get a feasibility study before signing any turnkey contract.

3. Do you need a custom design or two-story configuration?

Most prefab turnkey builders don’t offer two-story units — factory transport constraints cap the buildable footprint for a single module. Cover is a notable exception, stating on its FAQ that it builds two-story structures. If two-story is non-negotiable — typical on narrow urban lots where setbacks eat into the buildable area — site-built turnkey from a local design-build firm is often the better path.

4. How time-sensitive is your project?

If an aging parent is moving in within nine months, or rental income is part of your 2026 financial plan, turnkey prefab wins on speed (3–9 months vs. 8–14 for site-built). Cover targets 4 months for ADUs in its service area. Abodu targets six to eight months from signed contract to move-in. If your timeline is loose, the cost case for turnkey weakens.

5. Is your builder’s HCD-approved plan available in your city?

In California, an HCD-approved plan can compress permitting by months under AB 1332’s pre-approved-plan program (30-day approve/deny timeline). If your city has adopted a pre-approved-plan ordinance and your builder’s plans are on it, turnkey gets faster and the value-per-dollar improves. Outside California, this advantage is smaller — most states don’t have an equivalent program.

6. How much “construction risk” can you actually carry?

Turnkey is, at its core, risk transfer. You pay a premium for fixed-price certainty and single-point accountability. If a budget overrun would derail your finances or your relationship, that premium is reasonable. If you have a comfortable financial buffer and construction experience, semi-turnkey may make more sense.

The honest tradeoff

Turnkey prefab is rarely the cheapest path to an ADU. Once foundation, site prep, utilities, permits, and finishes are added to any prefab quote, the all-in cost often lands within 10–15% of a comparable site-built ADU. Snap ADU, which has completed over 100 ADU projects in San Diego, has publicly noted they are “continually surprised that there is not a big cost difference once you do the required permitting, site work, utilities & finish work for a prefab ADU.” What you pay for in turnkey is not savings. It’s certainty, speed, and one accountable company when something goes wrong.

9. Turnkey Prefab vs. Site-Built vs. Garage Conversion

Turnkey prefab wins on speed and predictability. Site-built turnkey wins on customization and difficult lots. Garage conversion wins on absolute lowest cost when the existing structure is sound and parking loss is acceptable.

FactorTurnkey PrefabSite-Built TurnkeyGarage / Internal Conversion
Typical all-in (2026)$200K–$500K+$250K–$450K+$50K–$180K
Timeline3–9 months8–14 months2–6 months
Best forSpeed, predictability, fixed-price certaintyCustom design, two-story (with most builders), difficult lotsLowest cost if existing structure is sound
CustomizationLimited (factory model lineups)MaximumConstrained by existing footprint
Lot flexibilityRequires crane/truck accessWorks on most lots including hillsidesRequires existing garage or unused interior space
Disruption to your life1–4 weeks of on-site activity6–12 months of on-site activity2–6 months
Price certaintyHigh (fixed-price contracts common)Varies; change orders commonVariable; existing-condition surprises
Two-story optionUncommon (Cover and a few others)AvailableN/A

For a deeper comparison on the cost math, see our Prefab ADU Cost guide, which covers per-square-foot pricing by build type, and our How Much Does an ADU Cost? overview for budget-under-$200,000 options.

10. What’s Usually Outside Base Scope

No matter how “all-in” a turnkey quote is, certain costs are usually outside base scope and paid separately by the homeowner. A builder who claims otherwise is selling, not informing.

None of these are signs of a bad builder. They’re signs of how the system works. A 2026 California turnkey project with a $300,000 base contract may carry an additional $15,000–$45,000 in items outside the builder’s base scope, depending on lot conditions and jurisdiction. Budget accordingly.

11. How Homeowners Actually Pay for It

Most turnkey prefab ADU projects are paid through one of four financing paths: HELOC, cash-out refinance, construction-to-permanent loan, or a specialized renovation/ADU loan. The right path depends on your equity, your timeline, your credit profile, and whether the unit will be classified as modular real property or manufactured personal property. Finance the all-in project number, not the advertised unit price.

HELOC (Home Equity Line of Credit)

Flexible, draw as you go, typically variable-rate. Best when you have 20%+ equity in your primary home and want flexibility on draws. You only pay interest on what you draw, which can be useful when project timing is uncertain. Risk: variable rates can move during the project.

Cash-out refinance

Replaces your existing mortgage with a larger one, fixed rate. Best when current rates are equal to or below your existing rate, and when you want the project financed under one consolidated mortgage. Risk: if your current rate is well below market, refinancing increases your overall housing cost.

Construction-to-permanent loan

One closing, staged draws during construction, converts to a permanent mortgage when the build completes. Best when you have less equity and need lender-disbursed staged payments tied to construction milestones. Most common for new-construction site-built ADUs; also available for modular projects through select lenders.

Specialized renovation or ADU loan (including FHA 203(k))

Government-backed in some forms, lower down-payment requirements, designed for home improvement projects. Best when equity is tight or when you want a structured program.

Financial disclaimer: These descriptions are general. Specific terms — rate, APR, fees, eligibility, state availability, and product features — vary by lender and borrower profile. The Dwelling Index is not a lender, broker, or financial advisor. Confirm rates, fees, and eligibility with a licensed loan officer before deciding. Do not finance based on illustrative numbers.

Financing path matched to build classification

Build ClassificationHELOCCash-Out RefiConstruction-to-PermRenovation Loan
Modular IRC, permanent foundation
HUD Code manufactured, permanent foundation⚠️⚠️⚠️⚠️
Site-built (no prefab component)
Kit / panelized (owner-built)⚠️⚠️⚠️⚠️

⚠️ = lender-dependent or varies by state and borrower profile. This matrix reflects general industry availability, not a guarantee for any specific loan.

Common mistake: financing the unit, not the project. Borrowers who finance the advertised unit price — say, $150,000 — and then run out of money halfway through site work. Foundation, utility upgrades, permit fees, and finish work need to be in your loan from day one. If your lender won’t fund the all-in project (including the items in Section 10), you have the wrong financing path for an ADU.

Now You Know What Turnkey Should Cost — How Will You Pay for It?

We cover each financing path in depth — organized by your financial situation, not by which lender pays the highest commission. Match the path to your equity, your timeline, and your credit profile before you talk to any lender.

See ADU Financing Paths Compared →

Affiliate disclosure: Mortgage Research Center is a paid partner. We recommend it because its multi-lender quote model fits the path-not-pitch approach we describe — not because of payout.

12. Turnkey by Region: Who Delivers Where

Turnkey prefab ADUs are most mature in California, with growing markets in the Pacific Northwest, Utah, Greater San Diego, Massachusetts, and Florida. Outside these regions, “turnkey” typically means a regional design-build firm using prefab components, not a nationwide turnkey prefab manufacturer.

California

The most developed turnkey prefab ADU market in the country, driven by Government Code Chapter 13, AB 1332’s pre-approved-plan program, AB 818’s accelerated modular permit timeline, and HCD’s state plan-approval pathway. Verified turnkey or fixed-price builders include Abodu, Villa Homes, Samara, Bay Modular, and Cover.

Greater San Diego County

A specialty market with deep design-build expertise navigating San Diego’s city-specific permitting and pre-approved-plan programs across cities including San Diego, Oceanside, Carlsbad, Encinitas, Del Mar, Solana Beach, Poway, San Marcos, Escondido, La Mesa, El Cajon, Vista, Chula Vista, Rancho Santa Fe, Santee, Lemon Grove, Imperial Beach, National City, and unincorporated San Diego County. For homeowners in this region, SnapADU offers a turnkey design-build alternative to prefab. (Affiliate disclosure applies; see banner above.)

California Central Coast / Monterey County / Bay Area-adjacent (~150 miles)

Served by Framework First, a family-owned modular ADU builder with 40+ years of construction experience. Affiliate disclosure applies.

Utah and Southern California

Served by Nest Tiny Homes for Utah County, Salt Lake, Weber County, San Diego, and Imperial County. Affiliate disclosure applies; verify current service area before committing.

Pacific Northwest (Oregon, Washington)

A smaller but real turnkey market, anchored by regional design-build firms. Oregon ORS 197A.425 and Washington HB 1337 have made ADU approval substantially easier in many cities.

Northeast (Massachusetts, New York)

A newer market anchored by regional design-builders. The Massachusetts Affordable Homes Act has created by-right ADU rights in many municipalities.

Florida and the Southeast

Emerging. Verify state and city availability before assuming a builder serves your specific market.

13. What Can Go Wrong (and How to Catch It Early)

Most turnkey prefab ADU problems come from one root cause: scope mismatch. The buyer thinks they bought a finished ADU, while the contract sold them a unit, a shell, or a partial installation. The pattern: the gap between what the marketing said, what the contract actually said, and what the homeowner believed they bought. Closing that gap before signing — using the Section 2 Matrix and the Section 6 Test — prevents most of the trouble.

Scope mismatch (the #1 failure mode)

The homeowner sees “turnkey” in the marketing, signs a unit-only contract, and discovers at delivery that foundation, utilities, permits, and finishes are separate. Defense: the Scope Matrix. If every line item isn’t classified before signing, you don’t have a real turnkey contract.

Provider financial failure

This is the one most homeowners don’t worry about until it’s too late. Dwell reported in 2025 that Los Angeles modular builder Connect Homes filed for liquidation in January 2025 after debt and supply-chain issues, with one Northern California family who had paid more than $400,000 for an undelivered ADU. Earlier, San Diego ADU builder Multitaskr abruptly closed in 2024 after its license was revoked and was accused of taking $15 million from customers. Defense: check the builder’s BBB profile, year-founded, number of completed projects, and recent independent reviews. Avoid any payment structure that has 40%+ paid before the unit is on your property.

Permit incompatibility

The unit is built to a code (HUD vs. IRC) or a configuration the city won’t accept. Defense: confirm in writing that the builder will pull the permit, that the unit is IRC-compliant, and that the builder has completed a permitted project in your specific city within the last 12 months.

Lot access surprises

The crane can’t reach the install location. The delivery truck can’t make the turn. Overhead power lines block the drop. Tree canopies require clearance. Defense: a paid feasibility study or site visit before signing. Most established turnkey builders require this. If yours doesn’t, demand one.

Utility upgrade discoveries during plan check

The city plan-check process surfaces that your existing electrical panel can’t handle the new load, or your sewer lateral needs replacement, or your water service needs upsizing. These are “Sometimes IN” items on the Scope Matrix — often discovered mid-project, often expensive. Defense: ask your builder to inspect or document the existing primary-home systems during the feasibility phase.

Payment schedule risk

The builder asks for large up-front payments before milestones. Defense: structure payments around documented milestones — signed contract (small percentage), permits issued, foundation complete, unit delivered and set, all systems connected, final inspection passed.

Rental income overconfidence

Financing the project on the assumption of $3,500/month in rental income, then discovering the local market supports $2,200 or that short-term rentals are prohibited. Defense: research actual local long-term rental comps for similar-sized units, assume a 5–10% vacancy rate, and underwrite on conservative net rents.

These are illustrative examples, not guarantees of returns. Actual results depend on local market conditions, construction costs, financing terms, and regulatory approvals.

14. Your Next Step

The right next step depends on where you are in the process. If you have a quote in hand, run it through the Quote Checker and the 4-Question Test. If you don’t have a quote yet, start with the Feasibility Engine to confirm what your lot can hold.

Where You Are Right NowBest Next Step
Have a quote and want to verify it's actually turnkeyOpen the Free Quote Checker and run the 4-Question Test
Want to know whether your lot qualifies before getting any quoteGet Your Free ADU Property Report
Need rental income; want to confirm financial viabilityProperty Report + ADU Financing Paths
Housing an aging parent; speed matters more than costProperty Report + Section 5 builder shortlist matched to your region
Budget under $200,000 and considering smaller units or conversionsHow Much Does an ADU Cost →
Researching financing paths before committing to any builderADU Financing Paths →

Want This in Your Inbox?

Get our free ADU Starter Kit — the 32-line Turnkey Scope Checklist (printable), the 4-Question Test (one-pager), our financing-path decision matrix, and a permit-readiness checklist. Sent once. No follow-up spam.

Download the Free ADU Starter Kit →

15. Frequently Asked Questions

What is a turnkey prefab ADU?

A turnkey prefab ADU is a factory-built accessory dwelling unit delivered under a written total-project scope by one accountable company — covering design, permits, foundation, site prep, manufacturing, delivery, installation, utility hookups, finishes, and final inspection through certificate of occupancy. The word "turnkey" isn't legally protected, so always verify scope in writing using the 32-line matrix in Section 2.

How much does a turnkey prefab ADU cost in 2026?

A real turnkey prefab ADU in 2026 typically costs $200,000–$500,000+ all-in for a 340–1,200 sq ft unit, depending on size, region, and site conditions. Verified 2026 Abodu base prices: Studio $278,800 (340 sq ft), One $326,800 (500 sq ft), Two $360,800 (610 sq ft), Two+ $426,800 (800 sq ft), Dwell House $439,000 (540 sq ft) — all before approximately $17,000 average in permit fees and sales tax. For full line-by-line analysis, see our Prefab ADU Cost guide.

Is a turnkey prefab ADU really turnkey?

Only if the contract meets four criteria: (1) full written scope of work line by line, (2) fixed total-project pricing with one company accountable for the entire scope, (3) builder is the named permit applicant, and (4) explicit list of what's excluded. If a builder won't confirm all four in writing, the quote isn't truly turnkey regardless of marketing language.

What is included in a turnkey prefab ADU?

A real turnkey contract typically includes design, structural engineering, permit application, plan check, grading and site prep, foundation, factory manufacturing of the unit, Title 24 (or state energy-code) compliance, delivery, crane and set, utility trenching (usually up to a footage limit), HVAC, interior finishes, final inspection, and certificate-of-occupancy coordination. See the full 32-line matrix in Section 2.

What is NOT included in a turnkey prefab ADU?

Items usually outside base scope: city impact fees, school fees, sales tax in some jurisdictions, owner-initiated change orders, sewer lateral upgrades in the public right-of-way, property-tax reassessment, tree removal, demolition of existing structures, unique site engineering, and primary-home electrical or water upgrades discovered during plan check. Abodu, for example, lists these exclusions explicitly on its pricing page.

Is a prefab ADU cheaper than site-built?

Usually no, once all-in costs are included. Once foundation, site prep, utilities, and permits are added to any prefab quote, the all-in cost typically lands within 10–15% of a comparable site-built ADU. Turnkey prefab wins on speed, predictability, and single-point accountability — not on sticker price. Snap ADU has publicly noted there is "not a big cost difference" between prefab and site-built once full scope is included.

How long does a turnkey prefab ADU take?

3–9 months from contract signing to certificate of occupancy. Cover targets 4 months for ADUs in its service area. Abodu publicly targets six to eight months from signed contract to move-in. Samara says backyards can be ready in "as few as eight weeks on site" after earlier design and permit phases. Site-built ADUs typically run 8–14 months.

Do prefab ADUs need permits?

Yes. Every prefab ADU requires city or county permits — building permits, plan check, often electrical and plumbing sub-permits, and a certificate of occupancy. California's current 60-day ministerial approval rule is in Government Code §66317. State ADU laws have streamlined the process in many states (California, Washington, Oregon, Massachusetts, Colorado), but local permitting is still required.

What is the difference between modular and manufactured ADUs?

Modular ADUs are built off-site to the same IRC building code as a site-built home, inspected at the factory, and installed on a permanent foundation. They are typically classified as real property and financeable like site-built homes. Manufactured homes are built to the federal HUD Code. In California, Government Code §66313 expressly includes manufactured homes in the ADU definition; outside California, local acceptance varies. Confirm what code your unit is built to before signing.

Can a prefab ADU be used as a rental?

Yes, in most jurisdictions, as a long-term rental. For ADUs approved under California's state-exempt §66323 pathway, the unit must be rented for terms longer than 30 days. Separately, §66315 allows local agencies to require ADU rentals of 30 days or longer. Always verify your city's short-term rental rules before assuming Airbnb income is available.

Can I finance a turnkey prefab ADU?

Yes. The four main paths are HELOC, cash-out refinance, construction-to-permanent loan, and specialized renovation loans (including FHA 203(k)). The right path depends on your equity, timeline, credit profile, and whether the unit is classified as modular real property or manufactured personal property. See our ADU Financing Paths guide for path-by-path comparison.

What should I ask before paying a deposit?

The 4-Question Test in Section 6: (1) Can I see the full scope in writing, line by line? (2) Is the total project price fixed, and which company is accountable for the entire scope? (3) Who pulls the permits? (4) What's specifically excluded? Plus payment-schedule milestones, warranty terms, cancellation policy, and the builder's recent completed projects in your specific city.

How do I find a turnkey prefab ADU builder near me?

Ask any builder three questions: Has your company completed a permitted ADU in my city or county within the last 12 months? Who is the install crew that will work on my project, and where are they based? Will your company be the named applicant on the city permit? Specific answers to all three indicate genuine local turnkey capacity. Vague answers indicate coordinated-partner work, which may still be useful but is not turnkey in the contract sense.

Is BOXABL Casita a legal ADU everywhere?

Not automatically. BOXABL's Casita page describes the unit as built to residential building code, and BOXABL announced California state approval for its 2-Bedroom Casita in December 2025. However, legality as an ADU at a specific address still depends on local jurisdiction acceptance of the unit's foundation system, zoning, and permitting requirements. Verify with your city's building department before assuming the unit qualifies as a permitted ADU at your address.

Is a tiny home the same as an ADU?

Usually not. Tiny homes on wheels are typically classified as RVs and cannot serve as permanent ADUs without a foundation conversion and code compliance review. Tiny homes on permanent foundations may qualify as ADUs in some jurisdictions if built to the IRC or equivalent state-recognized code. Verify the specific code path before committing.

Does turnkey include utility hookups?

In a real turnkey contract, yes — typically within a stated footage limit from the primary home. Abodu, for example, includes standard utility connections within 50 feet of trenching, with trenching beyond that distance excluded. Electrical panel upgrades on the primary home, new water meters, and sewer lateral work in the public right-of-way are commonly excluded or itemized separately. Always confirm the exact utility scope and footage cap in writing.

Not sure where to start?

See what’s possible at your address — get your free ADU report in 60 seconds.

Get Your Free ADU Report →

Sources and Methodology

We classify pricing claims as one of three types: product-only (unit cost without site work), installed / partial-scope (unit cost plus some site work), or all-in / true turnkey (fixed total-project scope from design through certificate of occupancy). When a provider does not clearly publish whether permits, foundation, delivery, crane, utility hookups, inspections, taxes, and site-specific work are included, we mark that scope item as needing verification.

Builder sources verified May 28, 2026

Regulatory sources

Cost-range cross-checks

Industry-risk sources

Refresh cadence: Monthly for active affiliate partner pricing and service areas; quarterly for neutral builder pricing, builder scope, and price-range checks; annually for the underlying definitional framework; immediately upon any regulatory or partner status change.

Read our editorial standards →
