Skip to main content

Best ADU Builders Del Mar (2026): A Buyer’s Guide From an Independent Research Team

Independent research by the Dwelling Index Research Team · Last updated May 6, 2026 · Last verified May 6, 2026 · 19 sources · No paid placement

Builder GuideNext scheduled review: August 6, 2026
Disclosure. Dwelling Index is reader-supported. When you use our links to explore financing options, request prefab pricing, request a builder consultation, or purchase floor plans, we may earn a commission at no extra cost to you. SnapADU and Mortgage Research Center are disclosed affiliate partners on this page. Editorial recommendations are based on independent research and are never influenced by compensation. We are not a builder, lender, or broker. See full disclosure →

The Bottom Line on the Best ADU Builders Del Mar

The best ADU builders Del Mar are not interchangeable, and there is no honest single “top contractor” for every property. The right builder depends on your project type — new detached, garage conversion, attached, junior ADU (JADU), prefab/modular, or a multifamily build under SB 1211 — and on whether your lot sits in Del Mar’s certified Coastal Zone, the Bluff/Slope/Canyon Overlay, or under City of San Diego jurisdiction (some properties addressed in Del Mar are reviewed by San Diego, not Del Mar).

For most Del Mar homeowners building a new detached ADU between 700 and 1,000 square feet, our shortlist starts with SnapADU (CSLB #1075582) — a woman-owned, BBB A+ design-build firm with 100+ completed Greater San Diego ADUs and documented Del Mar service-area projects. SnapADU is also one of our approved affiliate partners. They specialize only in new detached stick-built ADUs, so for garage conversions, attached units, or prefab/modular shoppers, we list separate builder lanes below — independent research, not affiliate steering.

Realistic 2026 turnkey cost in Del Mar is $375 to $600+ per square foot for new detached construction, or roughly $300,000 to $500,000+ all-in for most builds (SnapADU March 2026 cost guide; Better Place Design & Build February 2026). Del Mar’s June 2025 ordinance caps detached ADUs at 850 sq ft (1-bedroom) or 1,000 sq ft (2+ bedrooms), limits detached height to 16 feet (or 18 feet within ½ mile of major transit), and requires an Administrative Coastal Development Permit unless a narrow exemption applies (DMMC Chapter 30.91, effective June 12, 2025).

The biggest 2026 update most Del Mar pages haven’t caught yet: California’s AB 462 (signed October 2025, amending Government Code §66329) now requires local governments to decide ADU coastal development permits within 60 days, prohibits public hearings, and removes the Coastal Commission appeal path that previously held projects up for months. We walk through exactly what that changed below.

Find Your Fit in 30 Seconds

Del Mar ADU project-type guide — data verified May 6, 2026
Your projectBest first-call builder laneWhere to jump
New detached ADU (700–1,000 sq ft)ADU specialist design-build with coastal experienceJump →
Garage conversionLocal remodeler-GC with ADU permit repsJump →
Attached or interior conversionWhole-home remodeler with ADU portfolioJump →
Junior ADU (JADU, ≤500 sq ft inside primary)Designer/remodeler familiar with current JADU rulesJump →
Multifamily detached (state law: up to 8)Specialist with multi-unit ADU experienceJump →
Coastal-bluff or Bluff/Slope/Canyon Overlay lotArchitect-led team with coastal entitlement repsJump →
Prefab / modular shopperVerify who handles permits, foundation, utilities, GC of recordJump →

Last updated: May 6, 2026 · Last verified: May 6, 2026
By The Dwelling Index Editorial Team — an independent research resource covering ADU financing, costs, and regulations.

Reader-supported disclosure: The Dwelling Index is reader-supported. When you use our links to explore financing options, request prefab pricing, request a builder consultation, or purchase floor plans, we may earn a commission at no extra cost to you. Our editorial recommendations are based on independent research; affiliate relationships do not influence builder placement or matrix ordering. We are not a builder, lender, or broker.

Primary next step — see what you can build on your Del Mar lot

See What You Can Build on Your Del Mar Lot \u2192 Get Your Free ADU Report

Get your free ADU report in 60 seconds — coastal status, applicable setbacks, max buildable size, and recommended builder lane. No phone call, no commitment.

Detached ADU on a Del Mar coastal-zone single-family lot, illustrating the typical project type covered by this Del Mar ADU builder guide.
Representative detached ADU in the Del Mar coastal zone. Del Mar’s June 2025 ordinance (DMMC Chapter 30.91) caps new detached ADUs at 850 sq ft (1-bedroom) or 1,000 sq ft (2+ bedrooms). Last verified May 6, 2026.

What “Best ADU Builder in Del Mar” Actually Means in 2026

“Best” in Del Mar isn’t decided by Yelp star count or generic “San Diego County” volume — it’s decided by whether the contractor has actually permitted under the city’s June 2025 ordinance, understands the AB 462 coastal-permit framework that took effect in late 2025, and matches your specific project type. The wrong filter is generic San Diego experience; the right filter is Del Mar permits pulled and Del Mar projects completed under current rules.

Del Mar is small — roughly 4,200 residents and a few square miles of coastline — but it concentrates risk. Most of the city sits inside the California Coastal Zone, which means most ADUs trigger Coastal Development Permit (CDP) review. The city’s certified ordinance, DMMC Chapter 30.91, became effective June 12, 2025 after the California Coastal Commission’s final certification. Any guidance written before that date is potentially outdated; any guidance written before October 2025 doesn’t reflect AB 462’s coastal-permit reforms.

Layer on California’s January 1, 2026 ADU package — AB 1332 (each local agency must operate a pre-approval program for ADU plans, with 30-day approval for qualifying detached ADU applications using preapproved or identical-previously-approved plans), AB 1154 / SB 543 (clarified JADU rules, 500 sq ft interior cap), SB 1211 (up to one detached ADU per existing multifamily unit, capped at eight), SB 1077 (Coastal Commission and HCD must publish coastal-ADU permitting guidance by July 1, 2026), and AB 2533 (path to legalize unpermitted ADUs built before January 1, 2020) — and the regulatory surface in Del Mar is more complex than in any inland city of comparable size. Note that AB 976 (chaptered in 2023) already prohibits owner-occupancy requirements on standard ADUs; that change is not new for 2026.

That complexity is exactly why the wrong builder is expensive. A general remodeler who quotes a 1,200 sq ft detached design (above Del Mar’s local cap) wastes your design dollars before plan check. A San Diego builder who hasn’t worked under the current Local Coastal Program may price a CDP as a footnote when on a bluff-adjacent lot it’s the project’s main risk variable.

That’s the work this guide does — sort builders into project lanes, decode the local rules that change pricing and design, walk through what AB 462 actually changed about coastal review, and give you a license-verification and contract-vetting checklist that California’s Contractors State License Board itself recommends.

Best ADU Builders Del Mar: Which Lane Fits Your Project?

Six builder lanes serve Del Mar with verifiable evidence of operating in San Diego County, and each one fits a different ADU project type. We list strengths and limitations honestly — including for our affiliate partner — and we tell you when a builder you’ve heard about is the wrong call for your specific scope.

Inclusion Criteria

To make our shortlist, a builder had to clear four filters. First, an active California CSLB license verifiable at cslb.ca.gov as of our verification date. Second, explicit Del Mar service area stated on the builder’s own current website. Third, at least one publicly documented project in San Diego County (Houzz, BBB, builder portfolio, or third-party press). Fourth, no pattern of unresolved BBB complaints or CSLB disciplinary action visible at the time of verification. We re-verify quarterly and at any major regulatory update. Inclusion is not endorsement; verify CSLB status and Del Mar references directly before signing anything.

The Builder–Project Fit Matrix

Affiliate disclosure (repeated near comparison table per FTC guidance). SnapADU is one of our approved affiliate partners. We have placed SnapADU into the new-detached lane based on documented Del Mar service-area and project evidence. The remaining builders are listed by project-type fit and are not paying for placement. Mortgage Research Center is also a disclosed partner link on this page. The matrix is ordered by project type, not affiliate status.

Del Mar ADU builder shortlist — May 2026. Ordered by project type, not affiliate status. Verify every license at cslb.ca.gov on the day of decision.
BuilderCSLB # (verify at cslb.ca.gov)Best fit when…Bad fit when…Del Mar evidenceAffiliate?
Affiliate disclosedSnapADU1075582New detached ADU, predictable pricing, coastal lots, multi-unitGarage conversions, attached ADUs, prefab buyers, sub-$300K budgetsDel Mar listed in service area; published 1,199 sq ft Del Mar project (used as service-area evidence; current ordinance caps detached at 850/1,000 sq ft, so verify your specific size against current rules); selected by Chula Vista and San Marcos through competitive bid to design pre-approved plansYes — approved partner
Better Place Design & Build1031735Mixed scopes including detached, garage conversion, attached additionsIf you want a builder doing only ADUs full-timePublishes Del Mar regulations content; lists Del Mar Village, Rancho Del Mar, Del Mar Heights, Beach Colony, Del Mar Mesa, and Del Mar Terrace service areasNo
OneStop ADU1094838Pre-designed site-built ADU plans with transparent starting pricesConstrained coastal lots requiring redesign; bluff-adjacent lotsPublishes pre-designed plans starting at $215K (400 sq ft) to $273K (800 sq ft) per their pricing page (pricing as of March 1, 2025; verify current pricing); references Del Mar in their pre-approved-plan contentNo
Beckham Builders975842Del Mar-local custom remodel that includes an ADU elementStandalone backyard new detached if you want an ADU specialistDel Mar location; ADU service page; established local custom-home contractorNo
Green Room Design Build (Solana Beach)1043138Boutique custom design from adjacent Solana Beach for hands-on ownersVolume-builder pricing predictabilityLocated in Solana Beach; Del Mar listed in service area; ADU-focused since 2018No

Research leads to verify before contacting — not part of the verified shortlist:

  • Vision ADU — markets ADU + garage conversion services in San Diego County. Active CSLB license, recent Del Mar permit experience, and current Del Mar service area all need direct verification before you sign anything.
  • Lars Remodeling & Design — 30+ years in San Diego County with whole-home remodel experience. Recent ADU-specific permits in Del Mar (under the June 2025 ordinance) need direct verification.
  • US Modular / NestADU — modular and tiny-home providers with Del Mar marketing pages. We did not place either in the verified shortlist because no approved prefab partner has documented Del Mar coastal-zone fit in our verification, and several published Del Mar code summaries we reviewed pre-date the June 2025 ordinance.

Best for New Detached ADUs

For new detached ADUs in Del Mar between 700 and 1,000 square feet, the strongest lane is a San Diego County ADU specialist that can document coastal-zone permitting and similar-size completed projects. SnapADU, Better Place Design & Build, and OneStop ADU all qualify on different pricing and customization models.

SnapADU focuses exclusively on new detached stick-built ADUs in Greater San Diego. They publish a feasibility process — their Feasibility SnapShot evaluates 75+ project variables before contract — and offer a six-month price lock. Their pricing model is turnkey design-build, which means a single accountable team from feasibility through permitting through framing and finish. Their per-square-foot turnkey cost in San Diego County, per their March 2026 published cost guide, runs $375 to $600+. SnapADU’s Del Mar project listing shows a 1,199 sq ft 4BR/3BA build at snapadu.com/projects; we reference this as service-area evidence only. Del Mar’s current ordinance caps standard detached ADUs at 850 sq ft (1-bedroom) or 1,000 sq ft (2+ bedrooms), so this older project may have been designed under different timing, jurisdiction, or category. Verify what’s permitted on your specific lot under the June 2025 rules.

Better Place Design & Build carries license #1031735 and publishes service to Del Mar Village, Rancho Del Mar, Del Mar Heights, Beach Colony, Del Mar Mesa, and Del Mar Terrace. Unlike SnapADU, they handle detached, attached, and garage conversion scopes plus larger remodels. Their published Del Mar cost framing — $375 to $600+ per square foot, with smaller units (around 500 sq ft) running closer to $600 and larger units (up to 1,200 sq ft) closer to $375 — aligns with the broader market.

OneStop ADU (license #1094838) takes a pre-designed plan approach. Their published starting prices are unusually transparent: a 400 sq ft studio starts at $215K, a 600 sq ft 1-bedroom at $241K, and an 800 sq ft 2-bedroom 2-bathroom at $273K (per their published pricing page, with pricing stated as of March 1, 2025). OneStop’s pricing page specifies inclusions — structure, landing/pad, design and complete plans, Title 24 documentation, permit processing, individually metered electrical upgrade (excluding SDG&E fees), and required solar where applicable. Items separately billed include city permit fees, school and impact fees, soil reports, site work, upgraded utilities, water/sewer connections, surveys/title, upgraded finishes, sprinklers if required, septic, and other site-specific costs. Verify current pricing before relying on these figures.

Affiliate-disclosed partner

Planning a new detached ADU in Del Mar? Request a free design-build proposal from SnapADU — independent feasibility scoping plus a six-month price lock.

SnapADU is an approved Dwelling Index referral partner for Greater San Diego. We may earn a commission if you become their client at no extra cost to you. We recommend SnapADU based on documented Del Mar service-area project work, ADU-only focus, and self-published completion data — not because of the partnership.

Request a Del Mar ADU Proposal from SnapADU →

Affiliate link. We are reader-supported; see disclosure above.

Best for Garage Conversions

A garage conversion in Del Mar typically runs $200 to $350 per square foot if the existing structure is legal, accessible, and structurally suitable. Del Mar’s CDP exemption applies only to conversions of legally established habitable space inside the primary structure — so most garage conversions in the coastal zone still require an Administrative CDP. The right builder is a remodeler-GC with documented ADU conversion permits, not a stick-built specialist.

Better Place Design & Build is our first call here — they have documented garage conversion experience and the ordinance literacy to scope coastal-permit triggers. Beckham Builders is a credible alternate for a Del Mar-local custom remodel feel. (Cost ranges aggregated from BNC Builders, Subworkit Contracting, and Fabrick Construction 2025–2026 published guidance; verify against builder bids for your specific project.)

A common Del Mar garage conversion question: California state law generally prohibits replacement off-street parking when a garage, carport, or covered parking space is converted to or replaced by an ADU (Government Code §66314). Del Mar adds a specific coastal-access caveat — replacement parking may be required only if the loss of off-street parking has a significant effect on public shoreline access. This is exactly the kind of code interaction that distinguishes a Del Mar-competent builder from a generalist.

Best for Attached or Interior Conversion ADUs

An attached ADU adds onto your existing home or carves out a self-contained unit inside it; in Del Mar, attached ADUs are subject to the same 850/1,000 sq ft caps as detached, plus a 50%-of-primary-residence cap on habitable space. Whole-home remodelers with documented ADU portfolios — Better Place, Beckham Builders — fit this lane better than ADU-only specialists.

The advantage of attached and interior conversion is regulatory: an ADU created through conversion of legally established habitable space within an existing primary structure (with no major structural-component removal), or directly attached to an existing single-family residence and otherwise qualifying as exempt development under Coastal Commission regulations, may be exempt from an Administrative CDP under DMMC §30.91.030(E)(2). For Del Mar coastal-zone properties this is the single most cost-effective path to ADU legality.

On second-story attached ADUs: Del Mar’s June 2025 ordinance permits an attached ADU at the second-story level only when there is not enough buildable area on the first story to accommodate a first-story ADU up to 800 sq ft and a second-story attached ADU is necessary. Where allowed, the attached ADU height cannot exceed 25 feet, the base-zone height limit if lower, or two stories. This is a narrower path than state law in most other San Diego cities — the design must justify why a first-story unit isn’t feasible.

Best for Junior ADUs (JADUs)

A Junior ADU (JADU) is a unit of no more than 500 square feet of interior livable space, contained entirely within the walls of a single-family residence, with a separate exterior entry and an efficiency kitchen. Del Mar permits one JADU on lots in single-dwelling-unit zones (CVPP, R1-5, R1-5B, R1-10, R1-10B, R1-14, R1-40), and AB 1154 and SB 543 (effective January 1, 2026) explicitly cap JADUs at 500 sq ft of interior livable space.

The current state JADU rules under California Government Code §66333 and the 2026 update package: if the JADU shares sanitation facilities with the main home, owner-occupancy is required. If the JADU has its own bathroom, owner-occupancy is not required. JADUs cannot be used as short-term rentals under 30 days. A JADU cannot trigger a sprinkler requirement if the main home does not already have sprinklers. Confirm current JADU requirements with Del Mar Planning before relying on the local ordinance PDF alone.

Best for Multifamily Detached ADUs (SB 1211)

California Senate Bill 1211 (effective January 1, 2025) requires ministerial approval of multiple detached ADUs on existing multifamily lots, capped at eight detached ADUs and not exceeding the number of existing units, plus conversion of up to 25% of existing multifamily units to ADUs in non-livable space (Government Code §66323). Del Mar’s June 2025 local ordinance still references up to two detached ADUs on multiple-dwelling-unit lots — where local code is more restrictive than state law, state law generally controls. Verify before designing.

For a multi-unit Del Mar property the entitlement value typically dwarfs the design fees. The builder lane for SB 1211 multifamily ADU work is narrow. SnapADU is the most experienced San Diego County firm we’ve found with documented multi-unit ADU experience and a published process for handling SB 1211 builds; this is worth a feasibility consult before architectural design begins.

Best for Coastal-Bluff or Bluff/Slope/Canyon Overlay Lots

If your Del Mar lot is in the Bluff, Slope, and Canyon Overlay Zone, the Coastal Bluff Overlay Zone, or the Beach Overlay Zone, your project is no longer a generic ADU — it’s a coastal entitlement project that happens to include an ADU. The right team is architect-led, with a coastal entitlement consultant or land-use attorney involved before a builder is selected.

For Bluff/Slope/Canyon Overlay lots specifically, the ADU height drops from 16 feet to 14 feet maximum. A geotechnical report is required for an ADU or JADU in a new structure (or within non-habitable space converted to habitable space) in the Coastal Bluff Overlay Zone (DMMC §30.91). Coastal bluff setbacks apply in addition to the standard 4-foot side and rear setbacks. Properties seaward of the first public roadway must comply with street-yard setbacks where necessary to protect public scenic views to the ocean. None of the volume design-build firms is the right first call here. Engage an architect with documented Coastal Commission case experience first; choose your contractor after the entitlement strategy is set.

Best for Prefab and Modular ADU Shoppers

Prefab and modular ADUs can lower base unit cost on flat, accessible inland lots — but Del Mar’s coastal grades, narrow lot access, tree protection rules, and Coastal Development Permit process often eliminate the prefab cost advantage by the time site work, crane access, foundation, and coastal permit conditions are factored in. For most Del Mar lots, stick-built specialists remain the dominant economic choice.

US Modular and NestADU both market Del Mar service. We have not currently routed primary affiliate CTAs to either because no approved prefab partner has documented Del Mar coastal-zone fit in our verification, and we don’t recommend builders we can’t verify for the specific city. If you want prefab in Del Mar, the question that separates a credible prefab path from a logistics nightmare is: Are you the licensed General Contractor of record for the Del Mar permit, or are you only the unit provider?

Del Mar Prefab Site-Access Screen

Before any prefab quote is real, the property needs to clear seven gates. Take this list to any prefab provider and require written answers:

Del Mar prefab site-access screen — require written answers from any prefab provider.
Site-access questionWhy it matters
Can a 60+ ft truck and a crane reach the building pad?Many Del Mar lots have street width or overhead-line constraints that disqualify a craned modular
What is the slope of the building pad?>10% slope often requires custom foundation, eroding prefab cost advantage
Are there protected trees (Monterey Cypress, Torrey Pine) in the dripline of the planned location?Del Mar's Tree Ordinance (DMMC Chapter 23.50) can require redesign
Does the lot need a Coastal Development Permit?Modular doesn't avoid CDP review
Who is the GC of record on the building permit?The unit provider often is not the licensed GC; you need this in writing
Who handles SDG&E coordination, sewer lateral, and water meter?Major sources of timeline drift
What is included in the unit price vs. site costs?Apples-to-apples comparison against stick-built turnkey

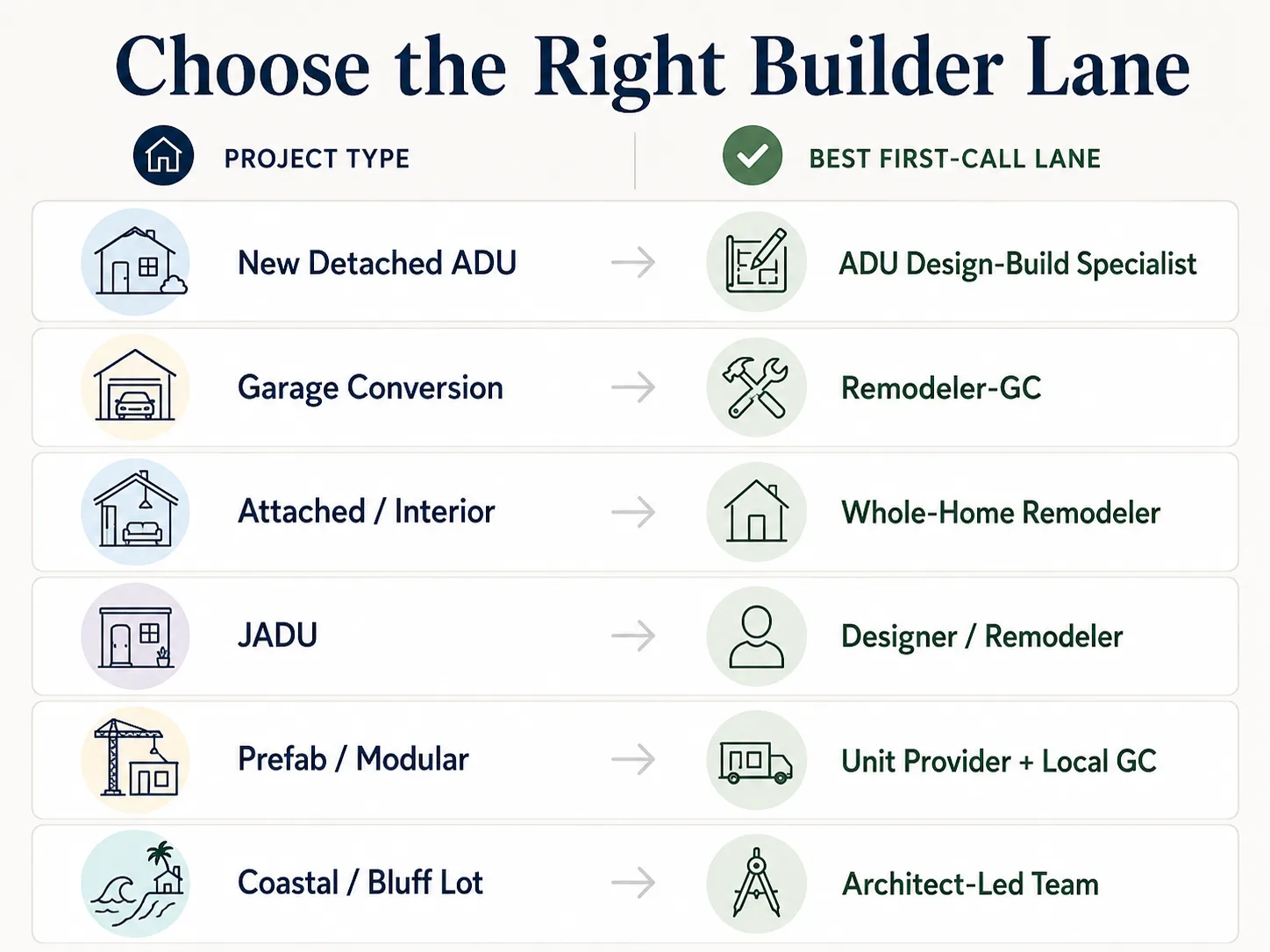

Seven ADU project lanes in Del Mar — new detached, garage conversion, attached, JADU, multifamily, coastal bluff, and prefab — each requiring a different builder fit.
Seven ADU project lanes in Del Mar. Each lane requires a different builder type. Last verified May 6, 2026.

What an ADU Actually Costs in Del Mar in 2026

New detached ADUs in Del Mar typically run $375 to $600+ per square foot turnkey, or $300,000 to $500,000+ all-in for most builds (SnapADU March 2026 cost guide; Better Place Design & Build February 2026). Builder-published guidance for coastal-zone construction in San Diego notes a coastal premium of roughly $10,000 to $16,000 above inland comparables. Site conditions, finish level, and overlay zones can swing any range by 30% before construction starts.

Per-Square-Foot Cost Ranges by ADU Type in Del Mar

Del Mar ADU cost ranges — 2026 planning estimates. Verify against builder bids for your specific project. Last verified May 6, 2026.
ADU type2026 cost per sq ftTypical all-in rangeSource
New detached (Del Mar)$375–$600+$300K–$500K+SnapADU March 2026 cost guide; Better Place Design & Build February 2026
Garage conversion (San Diego County)$200–$350$100K–$250KAggregated from BNC Builders, Subworkit Contracting 2025–2026 [verify against bid]
Attached or interior conversion$250–$400$150K–$300KAggregated from Better Place Design & Build, Fabrick Construction 2025 [verify against bid]
JADU (≤500 sq ft, inside primary)$150–$300$50K–$150KSan Diego County aggregated [verify against bid]
Pre-designed plan starting prices (OneStop ADU)n/a$215K (400 sq ft) – $273K (800 sq ft)OneStop ADU published pricing page (as of March 1, 2025; verify current pricing)

The OneStop ADU figures are starting package prices with stated inclusions and exclusions, not turnkey all-in numbers. They are not directly comparable to SnapADU or Better Place all-in pricing without adjusting for site work, utilities, permits, and additional finish allowances.

The Del Mar Coastal Cost Stack

This is the table no other page consolidates. We assembled it from city, state, and builder-published sources to show every line item that pushes Del Mar costs above generic San Diego County figures.

Del Mar 2026 coastal ADU cost stack. All amounts are estimates. Verify every fee with the relevant agency before budgeting. Last verified May 6, 2026.
Cost lineTypical Del Mar amountWhy it appliesSource
Base construction (new detached)$375–$600+/sq ftVertical build + standard finishesSnapADU 2026; Better Place 2026
Coastal Development Permit (administrative)[verify against current Del Mar fee schedule]Required unless ADU qualifies for exemption under DMMC §30.91.030(E)(2)Del Mar Planning
Coastal-zone construction premium+$10,000–$16,000Coastal building code, energy compliance, site-specific designBetter Place Design & Build, "Building an ADU in California's Coastal Zone" (2024–2025)
Stormwater mitigation / drainage$5,000–$10,000Bio-swale, drainage basin, contouringDel Mar BMP Design Manual; SnapADU
Certification of height, setback, sq ft compliance[verify with surveyor; estimate $1,000–$2,500]Required before framing inspection per DMMC §30.91Del Mar Planning
Soils / geotechnical report$3,000–$10,000Required in Coastal Bluff Overlay Zone for new structure or non-habitable→habitable conversionDMMC §30.91
School feesVerify with applicable districtSan Dieguito Union HSD lists $2.72/sq ft, exempt under 500 sq ft (current); Del Mar Union ESD collects statutory fees — verify by addresssduhsd.net; delmarschools.org
Utility connection fees$5,000–$15,000SDG&E coordination, sewer/water lateral, panel upgradesIndustry standard; SnapADU
Solar PV (Title 24)$8,000–$15,000 if requiredRequired by Title 24 depending on size and climate zone; some ADUs exempt — verify with designerSnapADU 2026 cost guide
Construction drawings (custom)$7,500–$25,000+Plans, structural engineering, MEP, Title 24SnapADU publishes ~$7,500 for standard plans

The Two-Story Reality: Why Del Mar Costs More Per Bedroom Than San Diego Proper

Del Mar’s height rules are more restrictive than most California cities, and that affects per-bedroom cost. Detached ADUs are capped at 16 feet (or 18 feet within ½ mile of a major transit stop or high-quality transit corridor) and are effectively single-story. Attached ADUs may be proposed at the second-story level only when there is insufficient buildable area to accommodate a first-story ADU up to 800 sq ft, with a second-story height ceiling of 25 feet (or the base-zone limit if lower) and a two-story maximum. In the Bluff/Slope/Canyon Overlay, the 14-foot height applies (DMMC §30.91).

The economic implication: on most Del Mar lots you cannot stack square footage vertically to maximize floor area. Where a San Diego or Encinitas homeowner could build a 1,200 sq ft two-story 3-bedroom on a tight lot for roughly $450K, a Del Mar homeowner is usually capped at a 1,000 sq ft single-story 2-bedroom or 850 sq ft single-story 1-bedroom for similar money. Price per bedroom in Del Mar is structurally higher than in any other San Diego coastal city. This is not a builder failing; it’s a code constraint, and a builder who hasn’t priced it specifically for Del Mar will quote you a number that doesn’t survive plan check.

Plan Price vs Turnkey Price: Don’t Compare Apples to Oranges

A common bid-shopping mistake: stacking a $215K pre-designed plan starting price against a $400K turnkey design-build all-in. The first is plan + shell with stated exclusions; the second includes site work, utilities, permits, finishes, and contingency. Always ask each builder, in writing, what is included and what is excluded from the price you’ve been quoted. A complete Del Mar bid should account for plans and engineering, Title 24, permits and city fees, school fees if applicable, the Administrative CDP if applicable, grading and drainage, foundation, utility trenching and upgrades, SDG&E coordination, fire and building code work, solar where required, finish materials, appliances, site access, landscape repair, inspections, and a contingency.

Need to figure out how to pay for this?

Most Del Mar ADUs are funded with a cash-out refinance, a HELOC, or a construction loan. Compare mortgage, refinance, cash-out, and construction-loan paths at the Mortgage Research Center.

Compare ADU Financing Paths at Mortgage Research Center →

Affiliate link. We are not a lender or broker. Talk to a licensed loan officer for personalized advice.

Del Mar’s ADU Rules in Plain English (DMMC Chapter 30.91 + 2026 California Updates)

Del Mar’s current ADU rules live in DMMC Chapter 30.91, effective June 12, 2025 after California Coastal Commission certification. They permit one detached or attached ADU plus one Junior ADU per single-family lot, cap detached units at 850 sq ft (1-bedroom) or 1,000 sq ft (2+ bedrooms), require 4-foot side and rear setbacks, limit detached height to 16 feet (18 feet near major transit), and require an Administrative Coastal Development Permit unless a narrow exemption applies.

Del Mar at a Glance

Del Mar ADU rules quick-reference — last verified May 6, 2026. Verify current rules with Del Mar Planning before design.
TopicDel Mar ruleSource
Maximum detached size850 sq ft (1BR) / 1,000 sq ft (2+BR)DMMC §30.91.040
Attached ADU cap≤50% of primary residence habitable space, same caps as detachedDMMC §30.91.040
JADU≤500 sq ft interior livable space, inside walls of single-family home; owner-occupancy if shared bathroomCal. Gov. Code §66333; AB 1154; SB 543
Detached ADU height16 feet (18 feet within ½ mile of major transit); 14 feet in Bluff/Slope/Canyon OverlayDMMC §30.91
Two-story attached ADUPermitted only when insufficient first-story buildable area for an 800 sq ft ADU; max 25 feet, max 2 stories, base-zone height if lowerDMMC §30.91
Side/rear setbacks4 feet minimumDMMC §30.91.040
Front setbackPer underlying zone (CVPP, R1-5, R1-5B, R1-10, R1-10B, R1-14, R1-40)DMMC §30.91
Lot coverage exemptionADUs ≤800 sq ft are exempt from lot coverage limitsDMMC §30.91
Building separation6-foot minimum between detached ADU and other structuresDMMC §30.91
Roof decks on detached ADUsNot permittedDMMC §30.91
Owner occupancy (standard ADU)Not requiredAB 976 (chaptered 2023); current state ADU statutes
Owner occupancy (JADU)Required if JADU shares sanitation with primary residence; not required if JADU has its own bathroomCal. Gov. Code §66333; AB 1154; SB 543
Short-term rentals (residential zones)Prohibited; rentals must be 30+ consecutive daysDMMC §30.91
Permit decision timeline60 days from complete submittal (state); ADU CDP also 60 days post-AB 462Cal. Gov. Code §66317; §66329 (AB 462)
Multifamily detached ADUs (state law)Up to 1 per existing unit, capped at 8 (state law supersedes more restrictive local)Cal. Gov. Code §66323 (SB 1211)
Multifamily conversion ADUsUp to 25% of existing units, minimum oneCal. Gov. Code §66323
Dark-sky lightingRequired: shielded, ≤2700K, downward-directedDMMC §30.91
Certification of compliance before framingRequired: height, setback, square footageDMMC §30.91
Stormwater mitigationRequired; bio-swale or equivalentDel Mar BMP Design Manual
Soils reportRequired only in Coastal Bluff Overlay Zone for qualifying scopeDMMC §30.91
Impact-fee waiver threshold≤750 sq ft exempt from local development impact feesCal. Gov. Code §66311.5 (SB 13)
Coastal Development PermitAdministrative CDP required unless exempt under DMMC §30.91.030(E)(2)DMMC §30.91; Cal. Gov. Code §66329 (AB 462)
AB 462 CDP timeline60-day decision clock; no public hearing; no Coastal Commission appeal under PRC §30603Cal. Gov. Code §66329 (AB 462)
AB 1332 pre-approved plansCity must operate pre-approval program; 30-day approval for qualifying detached ADUsCal. Gov. Code §66332
AB 2533 amnestyStreamlined path to legalize unpermitted ADUs built before Jan 1, 2020AB 2533 (2024)
SB 1077 guidanceCoastal Commission and HCD must publish coastal-ADU permitting guidance by July 1, 2026SB 1077 (2024)
Sample floor plans446 sq ft studio, 793 sq ft 1BR, 955 sq ft 2BR — available free at delmar.ca.us/815City of Del Mar Planning
Jurisdiction checkSome Del Mar-addressed properties are under City of San Diego jurisdiction — verify before designCounty Assessor; Del Mar Planning (858) 755-9313

What Changed in California ADU Law for 2026

2026 California ADU statute updates affecting Del Mar. Last verified May 6, 2026.
BillWhat it doesDel Mar implication
AB 462 (Oct 2025)Amends Gov. Code §66329; ADU CDPs must be approved/denied within 60 days, no public hearing, concurrent processing, no Coastal Commission appeal under PRC §30603Major: removes the Coastal Commission appeal path that previously held projects up for months. See section below.
AB 1332Each local agency must operate a pre-approval program for ADU plans; 30-day approval for qualifying detached ADU using preapproved or identical-previously-approved plansFaster permits if your design uses an accepted pre-approved plan
AB 1154 / SB 543JADUs explicitly capped at 500 sq ft interior; owner-occupancy if shared sanitation; no STRConfirms and slightly tightens the Del Mar JADU posture
SB 1211One detached ADU per multifamily unit, max 8 (Gov. Code §66323)Material entitlement upside for Del Mar multi-unit lots; supersedes more restrictive local code
SB 1077Coastal Commission and HCD must publish coastal-ADU permitting guidance by July 1, 2026Anticipated guidance — verify status before relying on
AB 2533Path to legalize unpermitted ADUs built before Jan 1, 2020Useful if you bought a Del Mar property with a non-permitted unit
SB 13 (still in effect)No impact fees on ADUs ≤750 sq ftKeeping your build under 750 sq ft can save thousands in impact fees (note: school fees are separate and may still apply per district)
AB 976 (chaptered 2023, not new for 2026)Permanently prohibits owner-occupancy requirements on standard ADUsStandard-ADU owner-occupancy is not a current local issue

Del Mar’s Sample Floor Plans

Del Mar has published three sample ADU floor plans developed by Stephen Dalton Architects under an SB 2 Grant, available free at delmar.ca.us/815: a 446 sq ft studio, a 793 sq ft 1-bedroom 1-bathroom, and a 955 sq ft 2-bedroom 1-bathroom, all designed to be fully ADA-accessible. These are floor plans only, not full pre-approved or permit-ready construction drawings — they still require formal construction drawings, structural engineering, Title 24 calculations, and a property-specific site plan before they are permit-ready. They are a useful starting point for design conversations with builders.

A Jurisdiction Trap That Catches Many Buyers

Some properties addressed in Del Mar are physically under City of San Diego jurisdiction. Del Mar Heights, parts of Del Mar Mesa, and pockets of Carmel Valley — although they share Del Mar zip codes (92014, 92130) — are reviewed by the City of San Diego’s Development Services Department under San Diego ADU rules, not Del Mar’s. The cost stack, permit timeline, and CDP process differ. Before you commission anything, confirm jurisdiction: pull up your address in the County Assessor’s record or call Del Mar Planning at (858) 755-9313 and ask directly.

The Coastal Development Permit Question (And When You’re Exempt)

Most Del Mar ADUs require an Administrative Coastal Development Permit (CDP) because the city sits inside the California Coastal Zone. The exemption under DMMC §30.91.030(E)(2) applies to ADUs created through conversion of legally established habitable space within an existing primary structure with no major structural-component removal, or directly attached ADUs that otherwise qualify as exempt development under Coastal Commission regulations. New detached ADUs and most garage conversions in the coastal zone need a CDP — but the process changed materially with AB 462 in late 2025.

The Coastal Development Permit is not a separate, parallel process for ADUs in Del Mar — the city issues an Administrative CDP under DMMC §30.75.080 alongside the building permit, and the two run concurrently. AB 462 codified this concurrent-processing requirement statewide.

When Your Del Mar ADU Is Exempt From a CDP

The exemption under DMMC §30.91.030(E)(2) is narrow and specific. The ADU must be either:

  1. Created through conversion of legally established habitable space contained in an existing primary structure with no removal or replacement of major structural components (roofs, exterior walls, foundations); or
  2. Directly attached to an existing single-family residence and otherwise qualifying as exempt development under Coastal Commission regulations.

If your project is a new detached ADU, a substantial garage conversion (the existing garage is generally not “legally established habitable space”), or anything that touches the building envelope significantly, you almost certainly need a CDP.

Did AB 462 Change Del Mar ADU Coastal Permits in 2026?

Yes — significantly. California AB 462, signed in October 2025 and amending Government Code §66329, requires local governments to approve or deny completed ADU coastal development permit applications within 60 days, prohibits public hearings on ADU CDPs, mandates concurrent processing with the building permit, and removes the Coastal Commission appeal path for ADU CDP decisions under Public Resources Code §30603. This is the single biggest improvement in Del Mar ADU coastal permitting in years.

If you’ve read older guides — including builder pages last updated before late 2025 — you’ll see warnings about Coastal Commission appeals, multi-month coastal review, and uncertainty about whether your project will be challenged after city approval. That framing was accurate before AB 462. It is no longer accurate today for ADUs.

What AB 462 Actually Changed

60-day decision clock for ADU CDPs

Local governments must now issue an approve or deny decision on a completed ADU coastal development permit application within 60 days. This aligns the CDP timeline with the broader 60-day ADU decision requirement and prevents the multi-month coastal-review tails that used to add unpredictability to Del Mar projects.

No public hearings on ADU CDPs

Del Mar already processed ADU CDPs administratively, but AB 462 makes this requirement statewide. ADU coastal permits are no longer subject to the public-hearing process that drove much of the procedural risk in older case histories.

Concurrent processing required

The Administrative CDP and building permit must run concurrently, not sequentially. This eliminates the “stacked review” delays where a city would issue the building permit and then start CDP review.

No Coastal Commission appeal under PRC §30603

Local-government ADU CDP decisions are no longer subject to appeal to the California Coastal Commission under Public Resources Code §30603. Once Del Mar approves your ADU CDP, the project doesn’t go through a second-tier state-agency review process for appeal.

What This Means for the Stratford Court / 6th Street Case (And Cases Like It)

In late 2025, the California Coastal Commission published a staff report (Item Th12a, October 2025) on a Del Mar ADU appeal at Stratford Court and 6th Street. The City of Del Mar had approved a detached two-story 1,000 sq ft ADU on the property. The Commission staff found “substantial issue” on public coastal view impacts and parking. The revised project that ultimately moved forward shifted to attached two-story at 800 sq ft, was angled to preserve blue-water public views, and added dedicated parking.

This case is now a pre-AB 462 example of what coastal review used to look like before the appeal path was closed for ADUs. The lessons from the design changes (public view sensitivity, parking, building orientation) are still useful planning considerations for any Del Mar coastal-zone build. But the procedural risk — that your city-approved ADU could be appealed to a state-level agency review months later — is no longer how the system works for ADUs.

What Hasn’t Changed

A few things AB 462 did not change. Del Mar still applies its certified Local Coastal Program during the 60-day review — the city’s height limits, setbacks, overlay zone rules, tree protection, and design standards still apply. The Bluff/Slope/Canyon Overlay still requires geotechnical reports for qualifying scopes. The 4-foot side and rear setbacks, 16-foot detached height limit, and 850/1,000 sq ft caps all still apply. Public-view, parking, and coastal-resource concerns still flag during city review.

What AB 462 did is take the state-level appeal review off the table for ADUs. The decision is local, ministerial, on a 60-day clock, and final.

Worried your lot might still trigger coastal review?

Run Our Free 60-Second Feasibility Check \u2192

We'll flag coastal-zone status, applicable overlay zones, and the recommended builder lane before you call anyone.

Del Mar 2026 ADU cost stack showing base construction at $375–$600 per square foot plus coastal premium, stormwater mitigation, soils report, school fees, utility connections, and Title 24 solar where required.
Del Mar ADU project process. New detached ADUs in the coastal zone require an Administrative CDP, which now runs concurrently with the building permit under AB 462. Last verified May 6, 2026.

How Long Does an ADU Project Actually Take in Del Mar?

A realistic Del Mar ADU project runs 10 to 14 months end-to-end — roughly 2 to 3 months for feasibility and design, 2 to 3 months for permitting (state law requires a 60-day approval decision on a complete application; AB 462 added a 60-day clock for the ADU CDP that runs concurrently), and 4 to 8 months for construction depending on size and site complexity.

The 60-day state-law clock is widely misunderstood. It runs from the date your application is determined complete by city staff, not the date you submit. Incomplete drawings, missing site plans, missing Title 24 documentation, an unclear scope, or a missing required survey can each restart or never start the 60-day clock. A common scenario: homeowners think they’re 30 days into their 60-day window and discover they’re actually still on Day Zero because their submittal lacked a stormwater management plan attachment.

Realistic Phase Breakdown

Feasibility and design (8–12 weeks)

Lot survey, site analysis, jurisdictional confirmation, schematic design, design review with the homeowner, construction documents, structural engineering, Title 24, mechanical/electrical/plumbing, stormwater management plan.

Permitting (8–12 weeks)

Initial completeness review (1–3 weeks), plan check (4–6 weeks), corrections and resubmittal (2–4 weeks), final approval and issuance (1 week). Administrative CDP processing now runs concurrently with building permit review under AB 462.

Construction (16–32 weeks)

Site work and grading (2–4 weeks), foundation (2 weeks), framing (3–5 weeks), rough trades (4–6 weeks), insulation and drywall (3–4 weeks), finishes (4–6 weeks), final inspection and certificate of occupancy (1–2 weeks).

The largest source of timeline overrun in Del Mar is utility upgrades — SDG&E coordination for a service upgrade, sewer lateral conditions, or water meter sizing can each add a month and cannot be fast-tracked. Ask any builder about their typical SDG&E coordination experience as a separate question from their general ADU experience. Bluff-adjacent and overlay-zone projects can stretch the design phase because of geotechnical studies, drainage analysis, and design responses to site conditions — but the procedural appeal risk that used to stretch coastal projects further is no longer the issue it was.

Rental Income Reality: What Del Mar ADUs Rent For (Zip 92014)

Per SnapADU’s published rent comp tables citing Rentometer data from March 2026, Del Mar zip 92014 medians run approximately $2,430/month for a 1-bedroom, $3,365 for a 2-bedroom, and $5,200 for a 3-bedroom. These are rental medians for the broader 92014 housing market (apartments, condos, and houses) — ADU-specific comps are smaller as a sample. These are illustrative figures, not guarantees of returns. Actual ADU rents depend on unit size, finish level, location within Del Mar, current market conditions, financing terms, and regulatory approvals.

Rent Comp Snapshot for 92014 / Del Mar

Del Mar 92014 rental medians — March 2026. Illustrative only; verify against current ADU-specific comps with a local property manager.
Unit typeRentometer median (March 2026)Source
1-bedroom$2,430/monthSnapADU citing Rentometer March 2026
2-bedroom$3,365/monthSnapADU citing Rentometer March 2026
3-bedroom$5,200/monthSnapADU citing Rentometer March 2026

The Damaging Admission About Del Mar ADU ROI

Here’s the honest reframe Del Mar listicles avoid. Del Mar’s height rules, the 850/1,000 sq ft cap, the limits on second-story attached ADUs, and the coastal cost premium structurally limit raw rental upside per dollar invested compared to a 1,200 sq ft two-story ADU you could legally build in many other San Diego cities. A 1,000 sq ft 2-bedroom Del Mar ADU renting at $3,365/month grosses approximately $40,400/year against a $400K–$450K all-in build — a 9–10% gross yield before financing, taxes, insurance, and vacancy.

That’s a respectable return, but it’s not the 12%+ gross yield possible on larger inland builds. Where Del Mar wins is the property-level value calculus: Del Mar’s land value, low vacancy rate, and long-term rental rate per square foot more than offset the size cap on a multi-decade ownership horizon.

Property Tax Math Under Prop 13

ADUs don’t trigger full property reassessment under California Proposition 13 — only the new improvement is reassessed. The San Diego County Assessor establishes a base-year value for the newly constructed portion of the property. The base tax rate in San Diego County is approximately 1% under Prop 13, with additional voter-approved bonds and special assessments commonly bringing the effective rate to roughly 1.15%–1.25% depending on tax-rate area.

A worked example: a $400,000 assessed ADU improvement at a 1.20% effective rate would add roughly $4,800/year in property tax. A $250,000 garage conversion at the same rate would add roughly $3,000/year. Compare these against expected rental income to see your true after-tax return. (These are illustrative calculations using assumed tax-rate areas; your actual rate and assessed value will be set by the County Assessor and depend on your specific tax-rate area.)

Short-Term Rentals: Don’t Assume Airbnb Is on the Table

Do not assume Del Mar will let you Airbnb your ADU. DMMC §30.91 specifies rental terms must be greater than 30 consecutive days for ADUs in residential zones. The city’s Short Term Rental Regulations Ordinance has gone through Coastal Commission certification rounds; verify current STR status directly with Del Mar Planning before pricing a project that depends on STR income. A builder who promises an STR-friendly design without referencing the certified ordinance is selling you a problem.

Need to figure out how to pay for this?

Most Del Mar ADUs are funded with a cash-out refinance, a HELOC, or a construction loan. Compare mortgage, refinance, cash-out, and construction-loan paths at the Mortgage Research Center.

Compare ADU Financing Paths at Mortgage Research Center →

Affiliate link. We are not a lender or broker. Talk to a licensed loan officer for personalized advice.

11 Questions That Filter a Del Mar-Competent Builder From a Generic Remodeler

These 11 questions surface the difference between a contractor who has actually permitted under Del Mar’s June 2025 ordinance and the AB 462 coastal-permit framework, and one who is hoping you don’t notice they haven’t. Use them on the first phone call, before any plans are drawn or any deposit is discussed. Vague or evasive answers are themselves a signal.

  1. 1

    How many ADUs have you specifically permitted under DMMC Chapter 30.91 since the June 2025 update?

    The certified ordinance is less than a year old. A builder who can't answer this question with a number and a project address hasn't actually worked under the new code. Strong answer: a specific number plus a property address or two we can drive past.

  2. 2

    Walk me through what AB 462 changed about the Administrative CDP process, and how it affects my project timeline.

    If they don't know AB 462 exists or can't explain the 60-day clock, no public hearing, concurrent processing, and the appeal-path closure, they are still operating on pre-2025 framing. Strong answer: references to Government Code §66329, the 60-day decision clock, and concurrent processing with the building permit.

  3. 3

    What is your protocol for the certification of height, setback, and square-footage compliance before framing inspection?

    Del Mar requires this certification specifically — generic San Diego builders frequently miss it and trigger an inspection failure. Strong answer: a documented in-house process with their typical surveyor.

  4. 4

    How do you handle stormwater mitigation on a typical Del Mar lot?

    Del Mar requires bio-swale or equivalent drainage work; budget impact is $5K–$10K. Strong answer: a costed line item in their typical scope, not a 'we'll figure it out' answer.

  5. 5

    Show me a project you have completed within the Bluff/Slope/Canyon Overlay or Coastal Bluff Overlay Zone.

    If your lot is in either overlay, you need overlay-specific experience. An honest answer of 'we haven't, your lot needs a coastal-bluff specialist' is better than a fake answer. Walk-away signal: claims of experience without project documentation.

  6. 6

    What is your CSLB license number and class, and is the license active today?

    CSLB's ADU Fast Facts states that B General Building Contractors can build or install ADUs, C-47 contractors can install manufactured-home ADUs, and specialty contractors generally cannot manage a full ADU build. Verify in real time at cslb.ca.gov while on the call.

  7. 7

    Is the legal entity on the contract the same entity that holds the CSLB license?

    Marketing brand names sometimes don't match the licensed legal entity, leaving homeowners exposed if a dispute arises. Strong answer: yes, with documentation matching.

  8. 8

    What is your written warranty, in months or years?

    Verbal warranties are not enforceable. California has a four-year statute of limitations on patent construction defects from substantial completion, but builder warranties beyond that vary. Strong answer: a written warranty with specific duration and coverage scope.

  9. 9

    How is your contract structured for milestone payments?

    California's Contractors State License Board limits down payments on home improvement contracts (which include ADUs) to the lesser of $1,000 or 10% of the total contract price (Business and Professions Code §7159; CSLB ADU Fast Facts). After the down payment, payments must follow actual progress. Any builder asking for more is violating CSLB rules. Strong answer: draws tied to inspection milestones (foundation poured, framing complete, drywall passed, final inspection).

  10. 10

    What is your protocol if a city correction adds 30+ days to permitting?

    Plan-check corrections happen on a meaningful share of California ADU submittals. A Del Mar builder should have a clear, calm process. Strong answer: their typical correction-cycle timing and how they handle the schedule slip.

  11. 11

    If your company cannot finish the build, what protections does my deposit have?

    A licensed California contractor carries a $25,000 contractor license bond required by CSLB, but this is not a project-specific performance bond. Ask whether the builder will provide project-specific bonding or escrow as additional protection. Strong answer: a discussion of project escrow, optional performance bonding for larger contracts, or other deposit-protection mechanisms.

Download the Free Del Mar ADU Starter Kit

Includes the 11-question builder script, the Del Mar coastal-permit decoder, a printable cost-stack worksheet, and the CSLB verification checklist — one PDF, emailed in two minutes.

Download the Free ADU Starter Kit →

Red Flags + the CSLB Down-Payment Rule

A confident, experienced Del Mar ADU builder welcomes hard questions. The ones who don’t have answers redirect, deflect, or push you to sign quickly.

Del Mar ADU builder red flags — verified May 6, 2026.
Red flagWhy it mattersWhat to do
"This price is good for 48 hours"Sales pressure designed to bypass due diligenceWalk. Real builders don't run countdown clocks.
"Coastal permits are no big deal here"CDP requirements under DMMC §30.91 are real and project-specificAsk for the specific exemption they expect to use — and get it in writing.
"We have tons of San Diego experience"Del Mar permits require DMMC Chapter 30.91 knowledge, not generic San Diego experienceAsk for Del Mar-specific project addresses under the June 2025 ordinance.
No mention of the Administrative CDPThe majority of Del Mar ADUs require a CDP — a builder who doesn't mention it hasn't priced itRequire explicit CDP line item and timeline in writing.
No mention of stormwater mitigation$5K–$10K line item that uninformed builders routinely omitAsk: 'What is your typical Del Mar drainage and bio-swale approach and cost?'
Quotes a 1,200 sq ft detached designDel Mar caps detached ADUs at 850 sq ft (1BR) or 1,000 sq ft (2+BR) — 1,200 sq ft is above the local capThe builder hasn't read the June 2025 ordinance. Reject the quote.
"Can't comment on overlay zones"If your lot is in a Bluff/Slope/Canyon Overlay, this is your project's main risk variableGet an answer. If they can't give one, engage a coastal-entitlement architect first.
Can't produce a CSLB license on first emailBasic verification any contractor passes instantlyVerify at cslb.ca.gov; if there's an issue, walk.
Deposit ask above 10% of contract or $1,000 (whichever is less)California CSLB cap on residential work (Business and Professions Code §7159)This is a CSLB violation. Walk.
"AB 462 means you don't need a CDP anymore"AB 462 reformed the CDP process but did not eliminate it — most Del Mar ADUs still require an Administrative CDPClarify: AB 462 shortened and streamlined the CDP; it did not remove it.
Single-paragraph contractNo protection for either partyReal ADU contracts run dozens of pages.
Promise of 'permit in 4 weeks'California law sets a 60-day clock from completeness determination; most Del Mar submittals require correctionsAsk for evidence of any sub-60-day Del Mar permit cycles in their portfolio.

The CSLB down-payment rule: California Business and Professions Code §7159 limits down payments on home improvement contracts (which include ADU construction) to the lesser of $1,000 or 10% of the total contract price. After the down payment, payments must follow actual progress on the work. Any contractor asking for substantially more upfront is either ignorant of CSLB rules or willing to violate them. Either is disqualifying. Verify this rule at cslb.ca.gov ADU Fast Facts (2025).

How AB 462 changed the Del Mar ADU coastal permit process: from a multi-stage review with potential Coastal Commission appeal to a 60-day local decision with concurrent processing.
Detached ADU on a Del Mar coastal lot. AB 462 (October 2025) removed the Coastal Commission appeal path for ADU CDPs — the decision is now local, on a 60-day clock, and final. Last verified May 6, 2026.

How Do You Compare Del Mar ADU Bids Apples-to-Apples?

Three quotes. Same scope. Same questions. Same scoring rubric. Send each builder the same one-page scope brief specifying size (within Del Mar’s 850/1,000 sq ft caps), bedroom count, finish level, known site conditions, and whether you want a fully custom plan or an AB 1332 pre-approved plan path.

Del Mar ADU bid comparison worksheet. Score each builder across these categories.
CategoryWhat you’re scoring
Del Mar permit depthNumber of ADUs permitted in the City of Del Mar under DMMC Chapter 30.91 (June 2025) in last 24 months
CDP fluencyCan they explain the Administrative CDP process and AB 462 impact accurately?
Quote completenessItemized line items vs. lump sums
CDP line itemIs the Administrative CDP scoped and budgeted explicitly?
Stormwater budgetIs bio-swale or drainage work a named line item?
Overlay zone clarityDo they know whether your lot is in a Bluff/Slope/Canyon Overlay?
Exclusions clarityAre exclusions written explicitly?
Allowance disciplineAre allowances dollar-figure rather than vague?
Timeline realismDoes the timeline include design, CDP, building permit, and construction phases separately?
Single point of contactNamed project manager?
Change-order processDocumented in the contract?
CSLB / insuranceCurrent and verifiable?
Deposit scheduleWithin California CSLB caps?

Download the Free Del Mar ADU Starter Kit

Includes the 11-question builder script, the Del Mar coastal-permit decoder, a printable cost-stack worksheet, and the CSLB verification checklist — one PDF, emailed in two minutes.

Download the Free ADU Starter Kit →

Hidden Conditions That Change the Answer in Del Mar

Seven site conditions that change both your builder choice and your budget.

Protected Trees (Monterey Cypress, Torrey Pine)

Del Mar’s Tree Ordinance (DMMC Chapter 23.50) protects specific native and significant trees. A Torrey Pine or established Monterey Cypress within the dripline of your planned ADU footprint can require redesign, arborist reports, and additional time in review. Ask any builder: “Have you walked my lot and identified tree constraints?” A builder who hasn’t asked you about trees yet hasn’t done a real site assessment.

Bluff/Slope/Canyon Overlay

Properties in the Bluff, Slope, and Canyon Overlay Zone face a 14-foot height limit (not 16 feet), mandatory geotechnical report for qualifying scopes, additional setbacks from top-of-bluff, and design review for visual impact on scenic corridors. Confirm your overlay status before any design deposit. A soil report on a bluff-adjacent lot costs $3,000–$10,000 and must precede, not follow, your design.

Public View Corridors

Properties seaward of the first public roadway must comply with street-yard setbacks where necessary to protect public scenic views to the ocean. The Stratford Court/6th Street case is instructive: the original design was flagged for blue-water view impact and required redesign at reduced size and reorientation. Even under AB 462, public view concerns still drive city-level conditions during the 60-day review.

Jurisdiction (City of San Diego vs. Del Mar)

Del Mar Heights, parts of Del Mar Mesa, and pockets of Carmel Valley are reviewed by the City of San Diego, not Del Mar. The rules, costs, CDP process, and permit timeline differ materially. Confirming jurisdiction at (858) 755-9313 is a 10-minute step that can save months of rework.

Dark-Sky Lighting Compliance

Del Mar’s ADU ordinance requires all exterior lighting to be shielded, 2700K or warmer, and downward-directed. On most builds this is a minor design constraint — but on projects with extensive outdoor lighting plans, it can require changes at plan check. Budget for it now rather than at corrections.

SDG&E Coordination Delays

SDG&E utility upgrade timelines in coastal San Diego County have stretched to 3–6 months for service panel upgrades in recent years. A builder who quotes a 10-month end-to-end timeline without accounting for utility coordination is quoting you a fantasy. Ask every builder: “What is your typical SDG&E wait time, and how do you manage it?”

HOAs and CC&Rs

Some Del Mar communities have CC&Rs with design-review provisions. California ADU law generally preempts HOA rules that block code-compliant ADUs, but design-review provisions can still slow you down. Read your CC&Rs before final design — and confirm your builder has experience navigating HOA architectural review, not just city plan check.

Methodology and What We Verified

We did not rank Del Mar ADU builders by advertising spend or referral payout. We sorted candidates by project-type fit, documented Del Mar or San Diego County service evidence, ADU specialization, current CSLB license status as of our verification date, public cost and process transparency, and whether each builder’s strengths match common Del Mar ADU risks. Major claims have inline source citations.

How We Built the Builder Shortlist

Each builder on our verified shortlist had to clear four documented filters: an active CSLB license verifiable at cslb.ca.gov on our verification date, an explicit Del Mar service area on the builder’s own current website, at least one publicly documented project in San Diego County, and no pattern of unresolved BBB complaints or CSLB disciplinary action visible at the time of verification. We then assigned each to one or more project lanes based on documented project-type experience. Builders who could not be verified on those filters appear in “research leads to verify before contacting,” not the verified shortlist.

What We Verified

Verification snapshot — May 6, 2026

Sources reviewed: City of Del Mar Accessory Dwelling Units page (delmar.ca.us/642); DMMC Chapter 30.91 effective June 12, 2025 (delmar.ca.us/DocumentCenter/View/9896); Del Mar Sample ADU Floor Plans (delmar.ca.us/815); Del Mar ADU Incentive Program (delmar.ca.us/814); California Government Code Chapter 13, Accessory Dwelling Units, §§66310–66342 (including §§66314, 66317, 66323, 66329, 66333); California AB 462 (October 2025) amending Government Code §66329; California HCD ADU Handbook with 2026 addendum; California Coastal Commission staff report Item Th12a (October 2025); CSLB Fast Facts on ADUs (2025) and CSLB Contractor License Bonds Guide; CSLB license database (cslb.ca.gov); CalHFA ADU Grant Program page (calhfa.ca.gov/adu); SnapADU service area, project, and cost guide pages (snapadu.com); Better Place Design & Build Del Mar service-area and cost pages; OneStop ADU pricing and pre-approved-plan content; Beckham Builders Del Mar service page; Green Room Design Build Solana Beach service-area page; San Dieguito Union High School District developer-fees page (sduhsd.net); San Diego County Assessor real-property assessment guidance.

Items flagged for re-verification before quarterly update: (1) CSLB license status for each named builder; (2) any City of Del Mar successor to the expired ADU Amnesty Program; (3) whether the Coastal Commission and HCD have published the SB 1077 statewide guidance (deadline July 1, 2026); (4) updated rental rate comps for zip 92014; (5) updated cost-per-sq-ft figures from each named builder’s published guidance; (6) current Del Mar fee schedule for ADU permits and Administrative CDP processing; (7) current school fees by district for Del Mar properties.

Editorial standards: The Dwelling Index is an independent research resource covering ADU financing, costs, and regulations. We are not a builder, lender, broker, or attorney. Our shortlist methodology prioritizes project-type fit and verified license + service-area data on the verification date. Affiliate relationships do not influence builder placement in lanes or matrix ordering.

What Still Needs Independent Verification on Your End

We’re an editorial research team. We have not personally hired any of the builders on this page, and we cannot verify their day-of license status or current project pipeline for you. Before you sign anything:

  • Confirm the builder’s CSLB license is active today at cslb.ca.gov
  • Confirm Workers’ Compensation insurance is current
  • Confirm BBB rating and complaint resolution pattern
  • Request three recent ADU client references and call two of them
  • Confirm the legal entity on the contract matches the entity holding the CSLB license
  • Confirm whether your specific property is under City of Del Mar or City of San Diego jurisdiction
  • Verify any rental projection against current 92014 comps with a property manager

Frequently Asked Questions

Who is the best ADU builder in Del Mar?

The best builder depends on your project type. For a new detached ADU between 700 and 1,000 sq ft, our shortlist starts with SnapADU (CSLB #1075582) — woman-owned, BBB A+, 100+ Greater San Diego ADUs, with documented Del Mar service-area projects. For pre-designed plans, OneStop ADU (#1094838) publishes transparent starting prices. For garage conversions, Better Place Design & Build (#1031735) and Beckham Builders (#975842) lead the local-remodel lane. For Bluff/Slope/Canyon Overlay or Coastal Bluff Overlay lots, engage an architect with coastal entitlement experience before selecting a contractor. (SnapADU is one of our approved affiliate partners; see disclosure at top.)

How much does an ADU cost in Del Mar in 2026?

Realistic 2026 turnkey cost in Del Mar runs $375 to $600+ per square foot for new detached construction, or roughly $300,000 to $500,000+ all-in for most builds (SnapADU March 2026; Better Place February 2026). Builder-published guidance for coastal-zone construction notes a coastal premium of roughly $10,000 to $16,000 above inland comparables. Garage conversions, attached/interior conversions, and JADUs run lower. Site conditions, finish level, and overlay zones can swing any range by 30% before construction starts.

Can I build a two-story ADU in Del Mar?

Detached ADUs in Del Mar are limited to 16 feet (or 18 feet within ½ mile of major transit), which generally means single-story (DMMC §30.91). Attached ADUs may be proposed at the second-story level only when there is insufficient first-story buildable area to accommodate an ADU up to 800 sq ft, with a height ceiling of 25 feet (or the base-zone limit if lower) and a two-story maximum. In the Bluff/Slope/Canyon Overlay, the 14-foot height applies. This is more restrictive than state law in most other San Diego cities.

Do I need a Coastal Development Permit for my Del Mar ADU?

Generally yes. Most Del Mar ADUs require an Administrative Coastal Development Permit (CDP). The exemption under DMMC §30.91.030(E)(2) covers ADUs created through conversion of legally established habitable space within an existing primary structure with no major structural-component removal, or directly attached ADUs that otherwise qualify as exempt under Coastal Commission regulations. Under AB 462 (effective October 2025), Del Mar must decide ADU CDPs within 60 days, no public hearing, with concurrent processing alongside the building permit, and the decision is no longer subject to appeal to the Coastal Commission under Public Resources Code §30603.

How big can an ADU be in Del Mar?

Detached ADUs are capped at 850 sq ft for one bedroom or 1,000 sq ft for two or more bedrooms (DMMC §30.91). Attached ADUs cannot exceed 50% of the primary residence's habitable space and are subject to the same 850/1,000 sq ft caps. JADUs are capped at 500 sq ft of interior livable space (Government Code §66333; AB 1154; SB 543). ADUs up to 800 sq ft are exempt from lot coverage requirements.

How long does it take to get an ADU permit in Del Mar?

California state law requires Del Mar to approve a complete application within 60 days, and AB 462 codifies a 60-day clock for the Administrative CDP that runs concurrently. The 60-day clock starts on the day your application is determined complete by city staff, not the day you submit. Total project timelines, including design and construction, typically run 10 to 14 months end-to-end.

Do I need to live on the property if I build an ADU in Del Mar?

Not for a standard ADU. AB 976 (chaptered in 2023) permanently prohibits owner-occupancy requirements on standard ADUs. JADUs are different — owner-occupancy is required if the JADU shares sanitation facilities with the primary residence (Government Code §66333; AB 1154; SB 543). If the JADU has its own bathroom, owner-occupancy is not required.

Can I rent my Del Mar ADU on Airbnb?

No, not in residential zones. DMMC §30.91 requires rental terms of more than 30 consecutive days for ADUs in residential zones. Short-term rentals are restricted to specific zoning districts. Verify current Del Mar STR ordinance status directly with Del Mar Planning before pricing a project that depends on STR income.

Is the California ADU grant still available in 2026?

No. The CalHFA $40,000 ADU Grant Program has been fully allocated since December 28, 2023, with no confirmed relaunch (CalHFA). Del Mar separately offers an ADU Incentive Program for owners willing to deed-restrict an ADU as affordable for at least 30 years; this is not a grant. See our ADU Grants 2026 page for the current state-by-state grant landscape.

What changed about Del Mar ADU coastal permits in 2026?

AB 462, signed in October 2025 and amending Government Code §66329, requires local governments to decide ADU coastal development permits within 60 days, prohibits public hearings on ADU CDPs, mandates concurrent processing with the building permit, and removes the Coastal Commission appeal path under Public Resources Code §30603 for ADU CDP decisions. Del Mar still applies its certified Local Coastal Program during the 60-day review, so city-level conditions for public views, parking, bluff sensitivity, and overlay zones still apply — but the state-agency appeal review is no longer part of the ADU permit process.

My Del Mar property tax bill comes from San Diego — which city's rules apply?

Your property's physical jurisdiction determines which rules apply, not the mailing address. Some properties addressed in Del Mar — particularly in Del Mar Heights, parts of Del Mar Mesa, and pockets of Carmel Valley — are reviewed by the City of San Diego's Development Services Department under San Diego ADU rules, not Del Mar's. Confirm your jurisdiction by pulling up your address in the County Assessor's record or by calling Del Mar Planning at (858) 755-9313 before you commission anything.

Can a builder ask me for 30% down on a Del Mar ADU contract?

No, that violates California law. CSLB limits down payments on home improvement contracts (which include ADU construction) to the lesser of $1,000 or 10% of the total contract price (Business and Professions Code §7159; CSLB ADU Fast Facts 2025). After the down payment, payments must follow actual progress on the work. Any contractor asking for substantially more upfront is either ignorant of CSLB rules or willing to violate them. Either is disqualifying.

Your Next Three Steps

The fastest credible path from “I want an ADU” to a confident builder shortlist is feasibility first, builder lane second, written all-in scopes third — with CSLB verification before any money moves. This sequence costs nothing, takes about a week, and eliminates the most expensive mistakes Del Mar homeowners make.

Step 1 — Run a property-level feasibility check.

Before you call a single builder, confirm your jurisdiction, coastal-zone status, applicable setbacks, max buildable size, and overlay-zone constraints. If you contact a builder before doing this, your first conversation will be about basic feasibility instead of about fit.

Step 2 — Shortlist 2–3 builders by project lane.

Use the matrix at the top of this guide. Don’t compare a stick-built specialist against a prefab provider against a remodeler-GC — they’re different products. Compare within a lane.

Step 3 — Request written all-in scopes from each shortlisted builder.

Use the 11-question script. Insist on inclusion/exclusion specificity. Verify CSLB before any deposit. Check that the legal entity on the contract matches the license holder. Limit the down payment to the lesser of $1,000 or 10%.

See What You Can Build \u2192 Get Your Free ADU Report

See What You Can Build \u2192 Get Your Free ADU Report

The fastest first step is checking what your specific Del Mar lot can build. Our free Feasibility Engine returns coastal-zone status, applicable setbacks, max buildable size, and a recommended builder lane in 60 seconds. No phone call, no commitment.

Affiliate disclosure. SnapADU is an approved Dwelling Index referral partner. We may earn a commission if you become their client at no extra cost to you. See full disclosure above.

Planning a new detached ADU? Request a free design-build proposal from SnapADU — for Del Mar new detached ADUs, our approved partner SnapADU offers a Feasibility SnapShot that evaluates 75+ project variables and locks in pricing before submittal.

Planning a New Detached ADU? Request a Proposal from SnapADU →

Affiliate link — see disclosure at top.

Download the Free Del Mar ADU Starter Kit

Includes the 11-question builder script, the Del Mar coastal-permit decoder, a printable cost-stack worksheet, and the CSLB verification checklist — one PDF, emailed in two minutes.

Download the Free ADU Starter Kit →

Editorial Disclosure

The Dwelling Index is reader-supported. When you use our links to explore financing options, request prefab pricing, request a builder consultation, or purchase floor plans, we may earn a commission at no extra cost to you. Our editorial recommendations are based on independent research; affiliate relationships do not influence builder placement, matrix ordering, or section inclusion. We are not a builder, lender, broker, or attorney; this guide is for educational purposes and is not legal, financial, or tax advice. Always consult the City of Del Mar Planning Department, a licensed California contractor, and a licensed loan officer for guidance specific to your property and finances.

Cost ranges, rental projections, property-tax calculations, and timeline estimates on this page are illustrative, not guarantees. Actual results depend on local market conditions, construction costs, financing terms, and regulatory approvals. Builder-by-builder claims are sourced from each builder’s own publicly available website and California CSLB records as verified on May 6, 2026; verify current license status at cslb.ca.gov before signing any contract. Where specific dollar figures or fee amounts are marked “verify against current schedule” or similar, those items must be confirmed with the source on the date of your decision.

Last updated: May 6, 2026 · Last verified: May 6, 2026

Not sure where to start? See what’s possible at your address — get your free ADU report in 60 seconds.
