Carlsbad ADU Permit Process 2026: Fees, Timeline, Coastal Rules & Pre-Application Checklist

Updated May 12, 2026 — verified against Carlsbad IB-111 (October 2025), Master Fee Schedule FY 2025-26, and California Government Code post-AB 462 / SB 543

At a Glance: Carlsbad ADU Permit Facts (2026)

  • Permit tracks: Building permit only (non-coastal or attached/JADU in coastal); building permit + Minor CDP Form P-6 (detached ADU in Coastal Zone)
  • Coastal Zone: About 37% of Carlsbad — check via city's online lookup before designing
  • Review clocks: 15 business days to completeness determination + 60 days to approve/deny complete application (deemed approved if missed)
  • Building permit fee: ~$2,000–$4,000 for most ADUs per carlsbadca.gov
  • Total permit stack (mid-five-figures): adds school fees (over 500 sq ft), impact fees (over 750 sq ft), utility/SDG&E, soils, Minor CDP where applicable
  • Permit Ready Program: Currently paused — updated plans anticipated summer 2026
  • Max size: 1,200 sq ft detached or attached; 500 sq ft JADU
  • Height bonus: 18–20 ft within ½ mi walk of Carlsbad Village Station or Poinsettia Station
  • Permit Center: 1635 Faraday Ave, Carlsbad — 442-339-2719

The Carlsbad ADU permit process is a two-track sequence, not a single application. Every accessory dwelling unit in Carlsbad needs a building permit. Detached ADUs in the Coastal Zone — about 37% of the city — also need a Minor Coastal Development Permit (Form P-6) that must be approved before or concurrent with the building permit. Attached ADUs and JADUs in the Coastal Zone are typically exempt from the Minor CDP and only need a building permit, subject to the exceptions in CMC § 21.201.060(B)(1). California law gives the city 15 business days to determine whether your application is complete and 60 days after a complete application to approve or deny it, with deemed-approval if the city misses the window. Carlsbad's free Permit Ready Program is currently paused — the city says updated, 2025-Code-compliant plans should be available by summer 2026.

We are The Dwelling Index — an independent research resource covering ADU financing, costs, and regulations. We assembled this page from the city's own ADU Information Bulletin (IB-111, October 2025), the Carlsbad Municipal Code, the California Government Code, HCD's 2026 ADU Handbook, the Carlsbad Master Fee Schedule, and current builder analyses. Where official documents and current state-law amendments disagree, we tell you which one applies and which phone number to call.

Which Carlsbad ADU permit path applies to your property?

Most homeowners don't know which permit path applies until they understand four facts about their lot. Use the table below to land on the right column before you spend money on design.

Your projectLikely permit pathFirst thing to check
Detached custom ADU outside Coastal ZoneBuilding permit only (B-1, B-75)Lot zoning, size and setback fit, utilities, fee thresholds
Detached ADU using city Permit Ready plansBuilding permit (program currently paused)City plan availability; B-75 ADU Checklist
Detached ADU in the Coastal ZoneMinor CDP (P-6) + building permitCoastal Zone status; P-6 form; LCP-compliance constraints
Attached ADU or JADU in the Coastal ZoneBuilding permit only (Minor CDP typically exempt)CMC § 21.201.060(B)(1) exceptions; LCP and habitat/geologic constraints still apply
Garage conversion ADUBuilding permit (+ Minor CDP if detached and coastal)Existing structure legality, code upgrades, parking-replacement check
Junior ADU (JADU) inside primary dwellingBuilding permit500 sq ft cap; owner-occupancy rule; deed restriction

See What You Can Build → Get Your Free ADU Report

Free property check. No builder commitment.

Check My Property →

What we verified — May 12, 2026

ClaimSourceStatus
Permit Ready plans currently unavailable; updated plans anticipated summer 2026carlsbadca.gov Permit Ready Program pageVerified
ADU applicants use B-75 checklist, B-1 application, and Hold Harmless Agreement; detached coastal adds P-6Carlsbad IB-111 October 2025; carlsbadca.govVerified
Permitting fees approximately $2,000–$4,000 for most ADUscarlsbadca.gov ADU pageVerified
15-business-day completeness window + 60-day approval clock with deemed-approved remedyGov. Code § 66317 as amended by SB 543 (eff. Jan. 1, 2026)Verified
Coastal ADU permit decisions not appealable to California Coastal CommissionGov. Code § 66329(c) as amended by AB 462 (eff. Oct. 10, 2025)Verified (note: IB-111 not yet updated)
About 37% of Carlsbad is in the Coastal ZoneCity of Carlsbad Coastal Zone Development Permits pageVerified
No impact fees for ADUs at 750 sq ft or less; no school fees for ADUs at 500 sq ft or lessGov. Code §§ 66311.5, 66324 (SB 543); Cal. Ed. Code § 17620 (SB 543)Verified
SDG&E separate meter for new detached ADUs ~$15,000SnapADU March 2026; Better Place Design & Build February 2026Builder-reported — confirm for your parcel
Submission method (in-person vs. digital) for combined building + coastal submittalscarlsbadca.gov Building & Permits pageUnresolved — call 442-339-2700 before submitting
Ordinance CS-506 (adopted February 2026) pending California Coastal Commission certificationeCode360 Carlsbad "New Laws" listPending certification — coastal lots should confirm
A finished detached ADU in coastal Southern California — Carlsbad ADU permit process guide

A finished detached ADU in a Southern California coastal community. The Carlsbad permit process typically takes 3 to 4 months to permit; construction adds another 4 to 8 months.

Do you need a building permit, a coastal permit, or both?

Every Carlsbad ADU and JADU requires a building permit. Detached ADUs in the Coastal Zone also require a Minor Coastal Development Permit (Form P-6). Attached ADUs and JADUs in the Coastal Zone are typically exempt from the Minor CDP, subject to the narrow exceptions in CMC § 21.201.060(B)(1). Outside the Coastal Zone, only a building permit applies and ministerial review under Government Code § 66317 governs the timeline.

Outside the Coastal Zone

If your property is not in the Coastal Zone, you only need a building permit. The review is ministerial — a yes/no decision against fixed, objective standards, with no public hearing and no discretionary commission vote. Once your application is complete, Carlsbad has 60 days to approve or deny (Gov. Code § 66317).

The submittal package includes:

Inside the Coastal Zone — detached ADUs

If your property is in the Coastal Zone and you're building a detached ADU, you need a Minor Coastal Development Permit in addition to the building permit. The Minor CDP form is P-6. The decision is administrative — no public hearing — and neighbors receive written notice but cannot block the permit. The Minor CDP must be approved before or concurrent with the building permit per IB-111.

Inside the Coastal Zone — attached ADUs and JADUs

Attached ADUs and JADUs in the Coastal Zone are typically exempt from the Minor CDP requirement and only need a building permit, with the narrow exceptions listed in CMC § 21.201.060(B)(1). Coastal Zone development standards still apply — LCP compliance, habitat-preserve buffers, geologic-stability setbacks, and visual-resource policies — even when the Minor CDP itself is not required.

Appeals — what changed in October 2025

Until October 2025, a Carlsbad coastal ADU decision could be appealed to the California Coastal Commission in the appealable area. AB 462, effective October 10, 2025, amended Government Code § 66329 to provide that a local-government decision on a coastal ADU permit is not subject to appeal to the Coastal Commission under Public Resources Code § 30603. The Coastal Commission's own appeals FAQ confirms ADU coastal decisions are not appealable. If you read older bulletins — including Carlsbad's October 2025 IB-111 — that mention CCC appeal rights for ADU coastal decisions, the current state-law rule controls.

The real meaning of “60-day ADU permit”

You will read that California “guarantees a 60-day ADU permit.” That's a partial truth. The 60-day clock starts only when your application is complete. The 15-business-day window before that is the city's first chance to tell you it isn't. If your plans are missing a Title 24 form, your site plan is off-scale, your soils report is missing, or your Coastal supplemental documents are the wrong year's version — Carlsbad will mark the application incomplete and the 60-day clock does not start. Two correction cycles is the most common outcome. Each cycle adds weeks. Spend the extra two weeks getting the package right before you submit.

The Carlsbad ADU permit process, step by step

The Carlsbad ADU permit process moves through nine practical steps. Total elapsed time from first design conversation to occupancy typically runs 10 to 18 months.

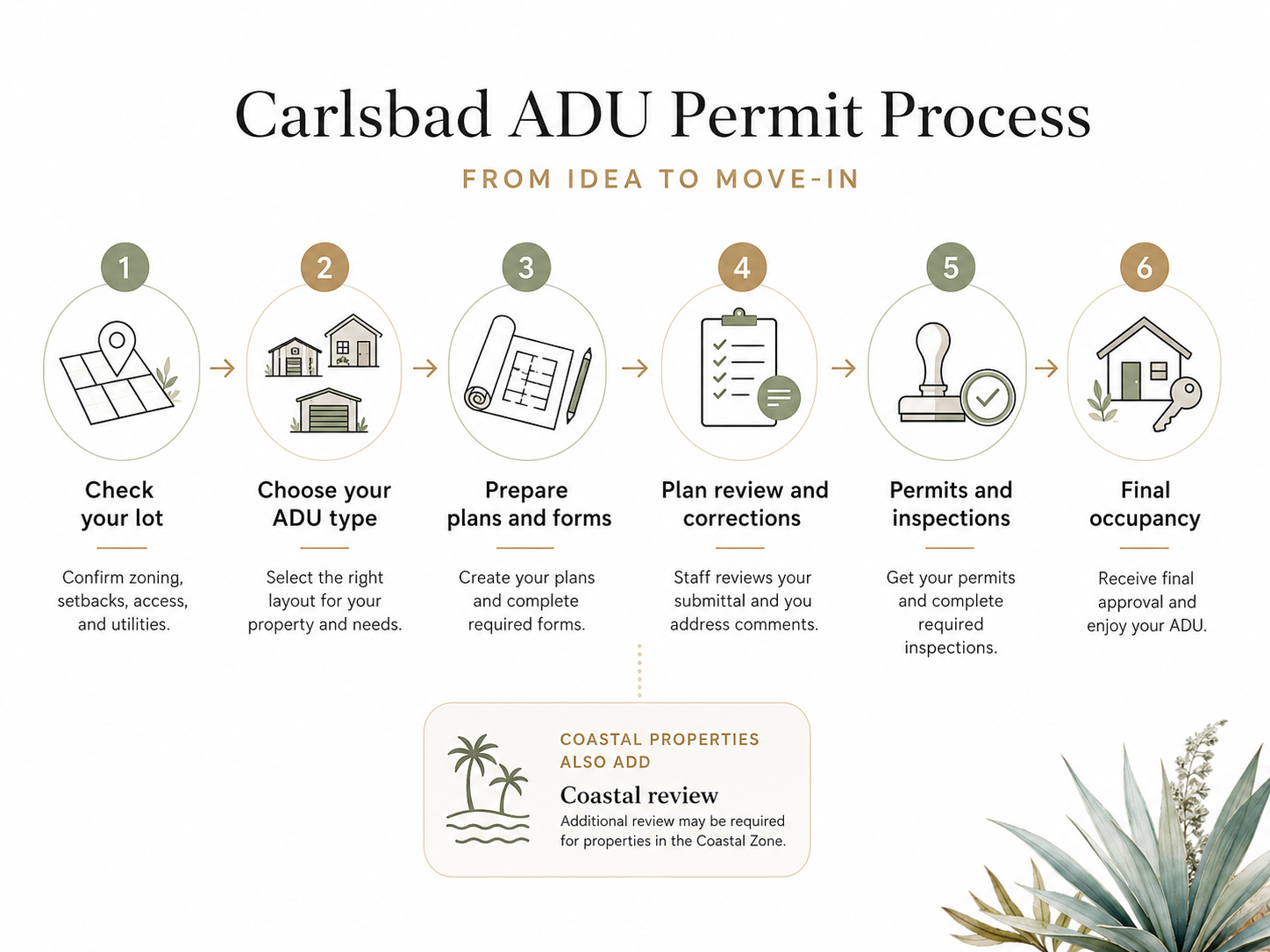

Carlsbad ADU permit process infographic showing 6 key stages with coastal zone callout

Overview of the Carlsbad ADU permit process stages, with Coastal Zone callout for projects requiring a Minor Coastal Development Permit.

1

Confirm your property's zoning, coastal status, and utility situation

Before you spend a dollar on design, you need four facts about your lot:

  • Zoning. ADUs are permitted in single-family and multi-family residential zones and certain mixed-use zones. Carlsbad imposes no minimum lot size for ADUs.
  • Coastal Zone status. Use the city's online address lookup, interactive zoning map, or PDF Coastal Zone map. About 37% of the city sits inside the zone.
  • Transit-stop proximity. Only Carlsbad Village Station and Poinsettia Station count as “major transit stops” for the ADU height bonus per IB-111. Within ½ mile walking distance — not radius — detached ADUs can reach 18 ft (20 ft with roof-pitch alignment).
  • Utility connection. Sewer vs. septic changes the feasibility and fee math. Properties on septic must verify capacity with San Diego County's Department of Environmental Health and Quality.
2

Decide your ADU type and design path

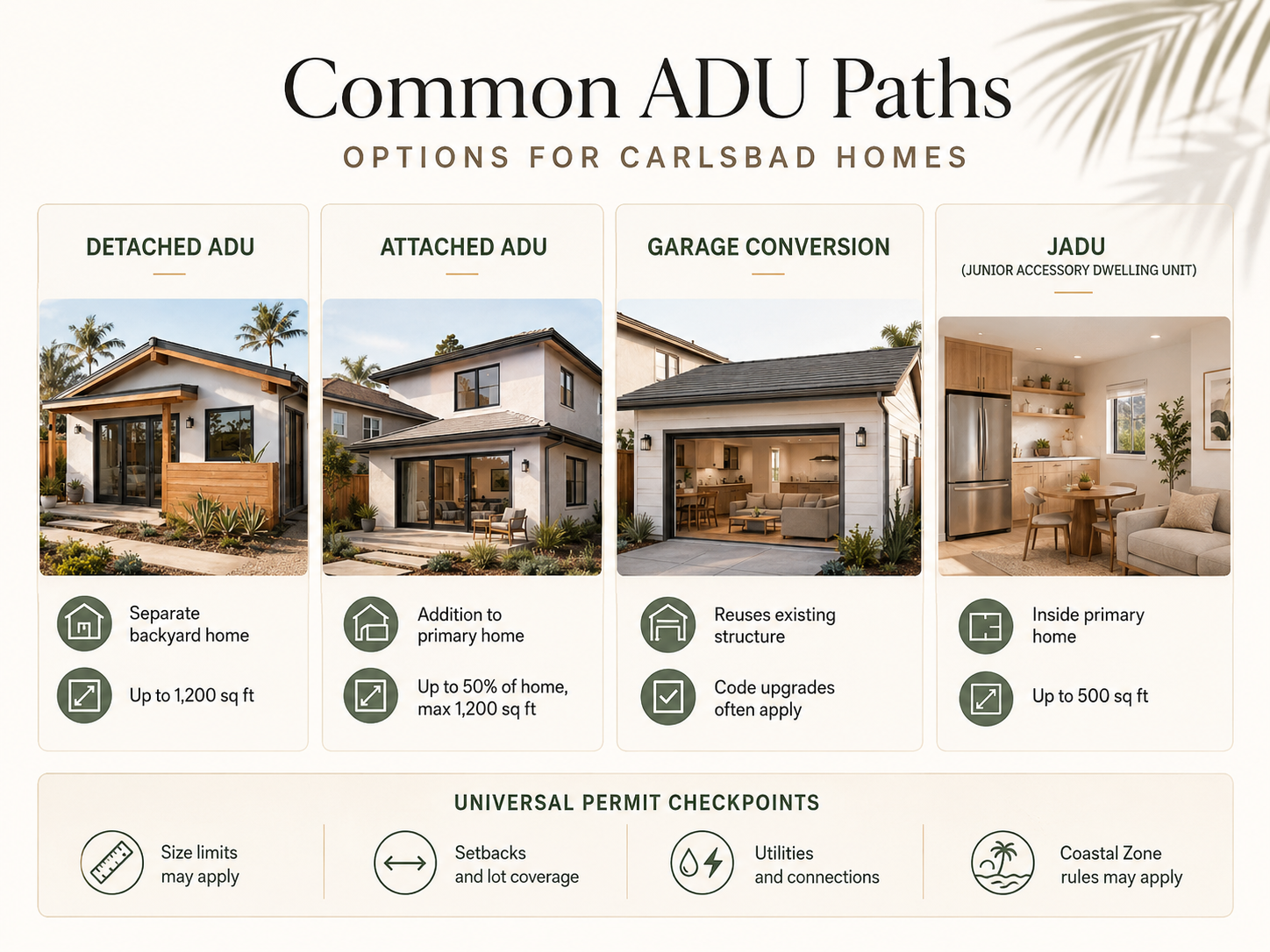

Carlsbad allows four ADU types: detached, attached, conversion, and JADU. On a single-family lot, you may build one ADU plus one JADU. Under Gov. Code § 66323's mandatory-approval pathway, you may also be eligible for one converted ADU + one detached ADU + one JADU on a single-family lot, subject to state-law standards. On a multifamily lot, up to eight detached ADUs are allowed outside the Coastal Zone (up to two detached inside). Once you know your type, choose the design path: Permit Ready (currently paused until summer 2026), semi-custom, or fully custom.

3

Commission plans, soils report (if required), and Title 24 documents

Hire an architect or licensed designer experienced with Carlsbad ADUs. The deliverable is a complete plan set: site plan, floor plans, elevations, sections, structural details, electrical and plumbing schematics, Title 24 energy compliance documents, and (for new detached ADUs) the solar PV plan. If your ADU is over 500 sq ft single-story or includes a second story, expect to commission a soils (geotechnical) report. Hillside and bluff lots typically require a soils report regardless of ADU size.

4

Assemble the application package

Pull every form from carlsbadca.gov — not third-party sites. Required forms for a typical Carlsbad ADU:

  • B-1 Building Permit Application Form
  • B-75 Permit-Ready ADU Checklist
  • Hold Harmless Agreement
  • Plan set per B-75 requirements
  • Title 24 energy compliance forms
  • Solar PV plan (new detached ADUs)
  • Soils report or signed waiver if the project qualifies

Coastal-zone detached ADU applications also require the P-6 Minor Coastal Development Permit application and any coastal-specific exhibits (LCP-consistency narrative, habitat-buffer site plan, geotechnical findings for coastal bluffs, view-corridor analysis).

5

Submit to the Carlsbad Permit Center

The Carlsbad Permit Center is at 1635 Faraday Ave, Carlsbad, CA 92008, open Monday–Friday 8 a.m. to 5 p.m.

  • 442-339-2719 — Building permits
  • 442-339-2700 — Permit status and inspections
  • 442-339-2610 — Planning Division

Many ADU building permits can be submitted online — the city's portal lists “Residential Second Dwelling Unit” among online application types. For Coastal Zone projects requiring a Minor CDP, confirm the combined submittal route (digital, in-person, or hybrid) with the Permit Center before assembling plans.

6

Respond to plan-check corrections

Plan check is the city's technical review. You will almost certainly receive a correction list. Treat each correction as a sentence-by-sentence response: every comment fully addressed, with the page-and-detail reference where you made the change. Sloppy correction responses trigger a second correction cycle. Per SB 543, the city's completeness review on resubmittal is generally limited to the items it identified the first time — Carlsbad cannot reopen settled review on items not flagged.

7

Permit issuance

Once corrections are resolved and fees are paid, the city issues your building permit and (for detached coastal projects) your Minor Coastal Development Permit. The permit comes with conditions of approval — read them. They include inspection points, expiration dates, and any site-specific requirements that flowed out of plan check.

8

Build with inspections at each stage

Carlsbad inspections track standard construction milestones: foundation, framing, rough electrical/plumbing/mechanical, insulation, drywall, and final. Schedule each inspection through the city's online portal or the inspections line (442-339-2700). Don't cover work until it's been inspected — opening walls back up because you skipped a rough inspection is one of the costliest mistakes a homeowner can make.

9

Final inspection and Certificate of Occupancy

After the final inspection passes, the city issues a Certificate of Occupancy. That's when the unit is legally habitable and rentable. Until then, occupancy is not authorized. Total elapsed time from first design conversation to Certificate of Occupancy typically runs 10 to 18 months.

Can I submit my Carlsbad ADU permit online?

Carlsbad's online permit portal accepts many residential building permit applications, and “Residential Second Dwelling Unit” appears in the city's list of online building-permit application types. Standard planning entitlement applications — including some Coastal Zone Minor CDP submittals — may still require appointments and hard-copy plans at the Permit Center.

The practical rule for May 2026: most non-coastal Carlsbad ADU building permits can be submitted online. Combined building + Coastal Zone Minor CDP submittals should be confirmed with the Permit Center before assembling plans. The answer affects printing costs, correction-response workflows, and whether you need to coordinate a drop-off appointment.

Application typeCurrent route
Building permit (non-coastal ADU)Online via carlsbadca.gov portal (“Residential Second Dwelling Unit”)
Planning entitlement (Minor CDP P-6)Standard entitlement applications may require appointment + hard-copy plans at 1635 Faraday
Combined building + coastal detached ADUUnresolved — confirm with Permit Center (442-339-2700) before assembling plans

Carlsbad ADU development standards: size, setbacks, height, parking

Carlsbad allows one ADU plus one JADU on most single-family lots. Maximum sizes are 1,200 sq ft for detached ADUs, 1,200 sq ft (or 50% of the primary home, with a floor of 800 sq ft) for attached ADUs, and 500 sq ft for JADUs. Minimum side and rear setbacks are 4 ft. Detached ADUs near Carlsbad Village Station or Poinsettia Station may rise to 18 ft (20 ft with roof-pitch alignment).

Size matrix

TypeMax size (interior livable space)Max heightMin side/rear setbacks
Detached ADU1,200 sq ft16 ft standard; 18–20 ft within ½ mi walk of Carlsbad Village or Poinsettia Stations; 18 ft on multifamily lots with multistory dwellings4 ft
Attached ADU1,200 sq ft or 50% of primary, whichever less; minimum 800 sq ftUp to 25 ft, not more than 2 stories, subject to zone height limit4 ft
JADU500 sq ftInside existing single-family residence or attached garageN/A (internal)
Multifamily conversionUp to 25% of existing units' non-habitable space; minimum 1Existing structureExisting

Height — and the two-station rule almost nobody decodes correctly

Standard detached ADU height in Carlsbad is 16 ft. Three height bonuses are available per IB-111:

Carlsbad's IB-111 names only two major transit stops for the ADU height bonus: Carlsbad Village Station and Poinsettia Station. The qualifying ½-mile is walking distance, not radius — Carlsbad publishes Transit Stations ½ Mile Walking Distance Maps on its ADU resource page. Roof decks are prohibited on detached ADUs per IB-111. Don't design a project around a roof deck and then ask for an exception.

Setbacks — and the coastal exception

Side and rear setbacks for ADUs are 4 ft minimum. Front-yard setbacks normally follow the underlying zone. Government Code § 66323 (mandatory-approval pathway) provides that a detached ADU up to 800 sq ft may protrude into the front-yard setback when there is no other alternative location on the lot — except in the Coastal Zone. IB-111 states directly: “If there is a conflict with state government code ADU regulations and the LCP, the LCP shall apply.” The state's 800-sq-ft front-setback override does not apply inside Carlsbad's Coastal Zone.

Parking — and the replacement-area trap

State law (Gov. Code § 66322) caps ADU parking at one space per ADU and exempts ADUs in these situations:

State law also generally prohibits cities from requiring replacement parking when a garage, carport, or covered parking is demolished or converted for an ADU (Gov. Code § 66314). Carlsbad's local ordinance includes specific exception areas — the Parking Replacement Areas Map — typically along the rail/I-5 corridor. Inside the Coastal Zone, IB-111 adds an important nuance: uncovered parking spaces demolished or converted into an ADU do still require replacement. If your project is near the rail corridor, Avenida Encinas, or Batiquitos Lagoon, or anywhere in the Coastal Zone with uncovered parking, confirm parking treatment with the Planning Division before final design.

Coastal Zone ADUs in Carlsbad: who actually needs the second permit

About 37% of Carlsbad sits within the Coastal Zone established under the California Coastal Act. Detached ADU projects on those lots require a Minor Coastal Development Permit (Form P-6) in addition to the standard building permit. Attached ADUs and JADUs in the Coastal Zone are typically exempt from the Minor CDP and only need a building permit, subject to the narrow exceptions in CMC § 21.201.060(B)(1). Coastal Zone decisions on ADU permits are no longer appealable to the California Coastal Commission under Gov. Code § 66329 (amended by AB 462, effective October 10, 2025) — but LCP, habitat-preserve, geologic-stability, and visual-resource policies still apply.

Who needs a Minor CDP and who doesn't

Project type in Coastal ZoneMinor CDP (Form P-6)?
Detached ADURequired
Attached ADUTypically exempt; check CMC § 21.201.060(B)(1) exceptions
JADUTypically exempt; check CMC § 21.201.060(B)(1) exceptions
Garage conversion to detached ADUTypically required (treated as detached ADU)
Multifamily detached ADURequired

What the Coastal Zone overrides — and what it doesn't

Coastal Zone overrides state ADU law on:

  • • Front-yard setback — the state's 800-sq-ft protrusion right does not apply
  • • Parking replacement for uncovered spaces demolished or converted for an ADU (still required)

Coastal Zone does not override state ADU law on:

  • • 4-ft side and rear setback rule
  • • 800-sq-ft minimum ADU size right (outside front setback)
  • • Most parking exemptions for covered parking
  • • Ministerial review process
  • • 60-day approval clock

Carlsbad's 2026 ordinance — pending Coastal Commission certification

Carlsbad adopted Ordinance CS-506 in February 2026 to update its ADU ordinance for current state law. eCode360 lists CS-506 as pending California Coastal Commission certification. Until CS-506 is certified, the prior LCP-certified language controls in the Coastal Zone, while CS-506 controls outside the Coastal Zone. If your project relies on a CS-506 change that affects coastal lots, confirm with the Planning Division (442-339-2610) whether the relevant provision is currently in force at your address.

SB 1077 — coastal guidance still landing

Senate Bill 1077 directed the California Coastal Commission to issue guidance for coastal ADUs. The Commission released draft guidance on April 13, 2026, with public comment closing May 13, 2026 and final guidance due no later than July 1, 2026. Coastal-lot applicants planning a summer 2026 submission should check the Commission's SB 1077 page and the Carlsbad Planning Division for the final guidance.

Check My Property → Get Your Free ADU Report

Free property check. Coastal Zone, transit, school district, and utility notes in about 60 seconds.

Check My Property →

What documents and forms do you need before you submit?

Carlsbad publishes its required ADU forms on the city's ADU and Permit Ready Program pages. The core ADU forms are B-1 (Building Permit Application Form), B-75 (Permit-Ready ADU Checklist), and a Hold Harmless Agreement. Detached coastal projects add P-6 (Minor Coastal Development Permit). IB-111 is the city's plain-English ADU fact sheet you should read first.

Non-coastal or coastal attached/JADU

Coastal detached ADU — additional forms

Pre-design verification checklist

Before you pay an architect, verify these facts so your plans aren't wasted:

Check before spending design moneyWhy
Is the property in the Coastal Zone?Determines whether you need a Minor CDP (detached only) and changes front-setback flexibility
ADU size category (under 500 / 500–750 / over 750 sq ft)Drives school-fee, impact-fee, and soils-report triggers
JADU vs. ADU intentChanges size limits, location rules, owner-occupancy treatment, and deed restriction
New build vs. garage conversion vs. interior conversionChanges setback rules, parking treatment, and structural-upgrade scope
Parking-replacement risk areaCarlsbad has local exception areas; Coastal Zone uncovered parking has its own rule
Sewer vs. septicSeptic feasibility depends on capacity review by San Diego County DEHQ
HOA / CC&R restrictionsHOAs cannot ban qualifying ADUs (Civil Code § 4751) but can impose reasonable design standards
Within ½ mi walk of Carlsbad Village or Poinsettia Stations?Unlocks 18–20 ft height bonus for detached ADUs
Hillside, fire zone, or habitat-buffer overlay?Adds geotechnical, fire-rated assembly, or siting constraints

How Carlsbad's Permit Ready ADU Program works in 2026

The Carlsbad Permit Ready ADU Program offers free, pre-approved building plans for single-story detached ADUs, with the goal of saving homeowners three to six months of planning time and approximately $8,000–$16,000 in private architectural design fees. The program features four floor plans (studio, one-bedroom, two-bedroom, three-bedroom) across three architectural styles (Spanish, Farmhouse, Modern). As of May 12, 2026, the plans are unavailable while being updated to the 2025 California Building Codes; the city anticipates updated plans by summer 2026. Coastal Zone detached ADUs can still use Permit Ready when it returns — the program does not eliminate the Minor CDP requirement.

What the program saves

  • • Architectural design fees (~$8,000–$16,000)
  • • 3 to 6 months of design calendar time
  • • Some plan-check friction (reviewers familiar with the plans)

What the program does not save

  • • Construction cost
  • • Site work (grading, drainage, utility laterals)
  • • Soils report (same thresholds apply)
  • • SDG&E service review and separate meter
  • • Impact, school, and utility fees
  • • Coastal Zone Minor CDP review
  • • Permit calendar time (roughly the same as a well-prepared custom design)

What to do while the program is paused

  1. Wait for the city's updated plans (anticipated summer 2026). Reasonable if your timeline is flexible.
  2. Commission semi-custom plans that adapt a standard footprint to your lot. Splits the difference on cost and time.
  3. Run a feasibility check now, then decide. Useful when you're not sure whether your lot qualifies for the standard Permit Ready footprint anyway.
  4. Go fully custom. Right answer for unusual lots, two-story projects, attached ADUs, garage conversions, and JADUs — none of which the Permit Ready Program covered even when active.

For broader context on the program's plan catalog and the 750-sq-ft fee cliff, see our companion guide on Carlsbad pre-approved ADU plans.

How long does the Carlsbad ADU permit process take?

California Government Code § 66317 (as amended by SB 543, effective January 1, 2026) requires Carlsbad to determine completeness within 15 business days and approve or deny a complete ADU/JADU application within 60 days of a complete application. If the city misses the 60-day window, the application is deemed approved. AB 462 (effective October 10, 2025) requires the city to act on a coastal ADU permit within the same 60-day window after a complete coastal application. Practical permit-in-hand time is typically 3 to 4 months because of correction cycles, fee payment, and applicant response time. Total project elapsed time from first design conversation to Certificate of Occupancy is typically 10 to 18 months.

What actually extends your calendar

Realistic phase timing

PhaseTypical durationNotes
Design and engineering2 to 4 monthsFaster for Permit Ready (when available); slower for custom or attached
Permit submission and plan check2 to 4 months (non-coastal); 3 to 5 months (coastal detached)Includes correction cycles; coastal adds Minor CDP review steps
Construction4 to 8 months (site-built); ~9 months (prefab including delivery)Varies with ADU size and complexity
Final inspection and Certificate of Occupancy2 to 4 weeksFinal inspection schedule and any punch-list items
Total elapsed10 to 18 monthsCoastal lots, two-story attached builds, and design-heavy custom projects at upper end

How much should you budget for Carlsbad ADU permit fees?

Carlsbad's ADU page states that permitting fees for most ADUs are approximately $2,000–$4,000, depending on square footage. That figure is the building permit fee itself. The total permit-and-fee stack — once school fees on ADUs over 500 sq ft, impact fees on ADUs over 750 sq ft, utility connection or capacity charges, the SDG&E meter/service scope, and (for detached coastal projects) the Minor CDP are added — typically lands in the mid-five-figures for a new detached ADU. Architectural design fees of $8,000–$16,000 are separate.

The two state-law fee thresholds you must understand

500 sq ft or less
No impact fees
No school fees
500–750 sq ft
No impact fees
School fees may apply
Over 750 sq ft
Proportional impact fees
School fees apply

The single most common ADU sizing mistake: bumping from 749 sq ft to 760 sq ft to “get a slightly bigger kitchen” without realizing the project just absorbed the proportional impact-fee bill.

Full Carlsbad ADU permit cost stack

Verification key: [O] Official Carlsbad/state document. [E] City example or older city-published figure used as a sanity check. [B] Builder-reported. [*] Editorial assembled estimate.

Fee categoryUnder 500 sq ft500–750 sq ftOver 750 sq ftSource
City building permit + plan check~$2,000~$2,500–$3,500~$3,000–$4,000[O] carlsbadca.gov ADU page; Master Fee Schedule FY 2025-26
School district developer fee$0 (exempt ≤500 sq ft per SB 543)Authorized over 500 sq ft per Cal. Ed. Code § 17620Authorized; rate set by State Allocation Board[O] Cal. Ed. Code § 17620; SB 543. Verify current $/sq ft with your school district.
City impact fees (traffic, park, etc.)$0 (≤750 sq ft exempt per Gov. Code § 66311.5)$0 (≤750 sq ft exempt)Proportional to primary dwelling per Gov. Code § 66324[O] Gov. Code §§ 66311.5, 66324
Sewer / water capacity & meterReduced if existing serviceReduced if existing serviceNew connection fees may apply[O] Carlsbad Municipal Water District; verify per parcel
SDG&E separate meter / service scopeOften required for new detached ADUs; ~$15,000 reportedSameSame[B] SnapADU March 2026; Better Place Design & Build February 2026; SDG&E Service Standards & Guide
Soils report (geotechnical)Generally exempt for ≤500 sq ft single-story per B-75May be required for larger or steeper sitesGenerally required[O] Carlsbad B-75 ADU Checklist; [B] SnapADU April 2026
Minor Coastal Development Permit (Form P-6) — detached coastal onlyRequired if detached + coastalRequired if detached + coastalRequired if detached + coastal[O] CMC Chapter 21.201; confirm current MCDP fee with Planning Division

The city's published Building and Development Fee Guide (Rev. 12/2023) includes an 800-sq-ft detached ADU example totaling approximately $8,220.58. Use it as a sanity-check example only — it is based on FY 2023-24 fees and does not include all fees. For a current project-specific estimate, submit a B-40 Fee Estimate Request to the Permit Center or call 442-339-2700.

See Your Property's Permit Path → Get Your Free ADU Report

We'll flag the size thresholds and fee triggers most likely to apply to your project.

Check My Property →

What Carlsbad ADU issues cause the most permit delays?

Delay causePrevention
Coastal Zone surprise (discovered after design starts)Confirm Coastal Zone status via city's online lookup before engaging an architect
Incomplete first submission (most common)Complete every B-75 checklist item before submitting; attend Permit Center walkthrough
Fee-threshold sizing mistake at 500 or 750 sq ftChoose your target size category before finalizing design; ask your designer about fee-threshold tradeoffs
Paused Permit Ready plansConfirm plan availability with the city before relying on Permit Ready timeline; clarify in writing if a builder uses their own plans vs. the official city plans
Parking-replacement confusion in Coastal Zone or mapped exception areasConfirm parking-replacement treatment with Planning Division (442-339-2610) before finalizing garage conversion design
HOA architectural review running in parallelSubmit to HOA before you submit to the city; don't let HOA modification requests force you back through plan check
SDG&E meter / service coordinationStart SDG&E Builder Services application at the same time you submit your building permit application, not after
Slow correction responsesRespond to every correction notice within 5 business days; assign a designer or builder who monitors the portal proactively

Permit Ready vs. custom vs. garage conversion vs. JADU vs. prefab: which path?

The right Carlsbad ADU design path depends on your timeline, your lot, your budget, and whether you're in the Coastal Zone.

Carlsbad ADU design paths: four common ADU types and their permit considerations

Common Carlsbad ADU design paths. Each type has different permit checkpoints, fee implications, and Coastal Zone considerations.

PathBest forCarlsbad permit checkpoint
Carlsbad Permit Ready (when restored)Flexible timeline, simple detached single-story ADU on a standard lotPlans currently unavailable until anticipated summer 2026; Coastal Zone detached lots still need the Minor CDP
Custom detached ADUUnusual lots, two-story builds, design-specific requirementsCoastal Zone detached: requires Minor CDP (P-6); soils report typically required over 500 sq ft single-story or for steeper sites
Custom attached ADULots where a detached unit doesn't fit; matching primary dwelling architectureCoastal Zone: typically exempt from Minor CDP; height up to 25 ft / 2 stories changes architecture and structural scope
Garage conversionExisting garage, smaller budget, faster conceptExisting-structure code upgrades (egress, ceiling height, insulation, fire separation) can be expensive; parking-replacement check inside Coastal Zone and in mapped exception areas
JADU (in-home unit)Smaller in-family housing, lowest construction cost500 sq ft max; owner-occupancy required when JADU shares sanitation with primary dwelling; deed restriction; coastal: typically exempt from Minor CDP
Prefab / modularFixed product footprint, faster site phase, predictable pricingSite work, foundations, utilities, crane access, and Carlsbad permitting all still apply; not exempt from coastal review when detached

Get a Carlsbad ADU feasibility review with SnapADU

SnapADU is an active Carlsbad-area ADU specialist who has navigated Carlsbad permitting — including coastal review, correction cycles, and the Minor CDP process — on projects across Carlsbad, La Costa, Cardiff By The Sea, and other San Diego County cities. Useful when you already know your ADU type and want a builder feasibility review.

Get a Carlsbad ADU feasibility review with SnapADU →

Sponsored link — see our partner vetting policy

What changed in 2026: California state ADU law and the Carlsbad effect

The most consequential 2026 changes for Carlsbad ADU applicants are:

State lawWhat it doesCarlsbad effect
2025 California Building Code (eff. Jan. 1, 2026)New energy, structural, and electrical code cyclePaused Carlsbad's Permit Ready Program; all designs must use 2025 code from day one
AB 462 (urgency, eff. Oct. 10, 2025)Coastal ADU permits must run concurrent with building permit; 60-day clock; CCC appeal rights removedMinor CDP and building permit run on parallel clocks; City Planner's decision is final at local level (IB-111 not yet updated)
SB 543 (eff. Jan. 1, 2026)Tightened 15-day completeness rule; added applicant appeal right; school-fee exemption for ADUs ≤500 sq ft; deemed-approval remedy codified; clarified interior-livable-space measurementInterior-livable-space clarification typically adds 30–50 usable sq ft to a project without triggering size-threshold consequences
AB 976 (eff. Jan. 1, 2024)Permanently removed owner-occupancy requirement for standard ADUsIB-111 confirms: “ADUs are exempt from owner-occupancy requirements”
AB 1154 + SB 9 (eff. Jan. 1, 2026)JADU: 30-day minimum rental term added; owner-occupancy not required when JADU has independent sanitationSanitation configuration now drives the JADU owner-occupancy question; reconcile with IB-111 and confirm deed-restriction language with Planning Division
AB 2533 (eff. Jan. 1, 2025)Legalization pathway for ADUs built before January 1, 2020Carlsbad cannot deny permit for older unpermitted ADU based on prior zoning issues alone — only for substandard health/safety conditions
SB 1211 (eff. Jan. 1, 2025)Up to 8 detached ADUs on multifamily lots outside Coastal ZoneIB-111 limits multifamily/two-family lots inside the Coastal Zone to up to 2 detached ADUs under CMC § 21.10.030.D
AB 1033 (eff. Oct. 2023)Allows cities to permit separate condo sale of ADUs by local ordinanceCarlsbad has not opted in. IB-111 states: “The city does not permit separate sales of ADUs.”
SB 1077 (draft guidance April 13, 2026)Directs CCC to issue coastal ADU guidance; final guidance due by July 1, 2026Monitor CCC SB 1077 page and Carlsbad Planning Division for implementation updates before a summer 2026 submission

Can you rent, Airbnb, or sell a Carlsbad ADU?

Carlsbad ADUs and JADUs may only be rented for terms longer than 30 days — short-term rental (under 30 days) on a newer permitted ADU or JADU is not the permitted pathway. ADUs cannot be sold separately from the primary dwelling: Carlsbad has not opted into the AB 1033 separate-condo-sale pathway per IB-111. JADU owner-occupancy depends on whether the JADU has independent or shared sanitation facilities (post-SB 9, effective January 1, 2026).

Long-term rental — allowed

You can rent a permitted Carlsbad ADU on a 30-day-or-longer term basis. Standard residential leasing applies. The primary dwelling can be rented at the same time — AB 976 permanently removed the owner-occupancy requirement for standard ADUs. IB-111 confirms: “ADUs shall only be rented for a term of at least 30 days.”

Rental and ROI examples discussed in this guide are illustrative, not guarantees of returns. Actual results depend on local market conditions, construction costs, financing terms, tenant demand, and regulatory approvals.

A narrow IB-111 carve-out: ADUs within the Coastal Zone that were issued a building permit prior to January 1, 2020 are exempt from the 30-day minimum-rental requirement.

Short-term rental — not permitted for newer ADUs

The state-law and Carlsbad-ordinance default is that ADU and JADU rentals must be for terms longer than 30 days. Carlsbad runs a separate Short-Term Vacation Rental (STVR) permit program for whole-home and primary-residence STVRs — but newer ADUs are not eligible for STVR use. If short-term rental income is central to your investment thesis, verify current STVR rules with the city's Community Development Department before designing the project.

Separate sale — not currently permitted in Carlsbad

IB-111 is explicit: “The city does not permit separate sales of ADUs.” AB 1033 (effective October 2023) makes it legally possible for cities to allow separate condo sales of ADUs, but Carlsbad has not enacted the required ordinance. If separate sale is essential to your investment plan, watch for a future Carlsbad ordinance opt-in or confirm current status with the Planning Division at 442-339-2610.

JADU-specific rules

Edge cases that catch Carlsbad homeowners off guard

A handful of Carlsbad-specific situations consistently surprise homeowners six weeks into a project. The list below covers the cases we see discussed most often.

My property is on a septic system

Properties on septic must verify capacity with San Diego County's Department of Environmental Health and Quality before designing an ADU. A failing or at-capacity septic system will block the ADU permit regardless of state-law clocks. An ADU at 500 sq ft or less connected to an existing septic system is exempt from standard state-law septic inspection requirements, but the city still requires proof of adequate capacity before issuing a building permit. ADUs over 500 sq ft on septic typically require a full septic capacity study and may require system expansion.

My ADU is on a multifamily lot

Outside the Coastal Zone, Carlsbad allows up to 8 detached ADUs on an existing multifamily lot (not to exceed existing unit count), plus conversions of non-livable space at up to 25% of existing units (with at least one conversion always allowed per Gov. Code § 66323). Inside the Coastal Zone, IB-111 limits multifamily/two-family lots to up to 2 detached ADUs under CMC § 21.10.030.D. If you're planning multiple units on a multifamily parcel, confirm Coastal Zone status and current IB-111 provisions before commissioning a multi-unit design.

I have an unpermitted ADU from years ago

AB 2533 (effective January 1, 2025) created a clear legalization pathway for ADUs built before January 1, 2020. Carlsbad cannot deny a permit for an older unpermitted ADU based on prior zoning issues alone — only for substandard health/safety conditions. Owners can hire a licensed contractor for a confidential pre-inspection, then proceed with the legalization application. Impact fees are limited unless new utility connections are required. IB-111 confirms: "Existing nonconforming ADUs or JADUs constructed before Jan. 1, 2020, shall be permitted, unless conformance is necessary to protect the health and safety of the public, resident and/or occupant, or if the building is deemed substandard." Talk to a local design-build firm about the legalization scope before assuming the unit can't be brought into compliance.

My HOA's CC&Rs ban ADUs

Per Civil Code § 4751, any HOA governing-document provision that effectively prohibits or unreasonably restricts a qualifying ADU or JADU is void and unenforceable. HOAs can impose reasonable design standards but cannot block the project. If the HOA tries, your remedy is typically a letter from a real-estate attorney citing § 4751, followed by escalation if necessary.

I'm trying to combine an ADU with a SB 9 lot split

SB 9 lot splits and ADU construction are separate state-law pathways. Combining them is possible but adds complexity — SB 9 splits create a new property with its own primary-dwelling-and-ADU question. If you're planning both, get a planner involved at the feasibility stage.

Your Carlsbad ADU pre-application checklist

Before you submit your Carlsbad ADU permit application, work through this 12-step checklist. Each item is a chance to catch a problem before the city does — which saves you a correction cycle and weeks of calendar time.

1
Confirm the property is in the City of Carlsbad, not unincorporated San Diego County. The county uses different rules and a different permit pathway.
2
Confirm Coastal Zone status via the city's online lookup tool at carlsbadca.gov.
3
Confirm transit-stop proximity if you're hoping for the 18–20 ft height bonus (Carlsbad Village Station or Poinsettia Station, ½ mi walking distance).
4
Choose ADU type: detached, attached, conversion, or JADU.
5
Choose size category: under 500 / 500–750 / over 750 sq ft. Each band has different fee implications.
6
Verify side/rear setbacks — 4 ft minimum.
7
Check parking treatment: state-law exemption (½ mi from transit, historic district, conversion, JADU); local Parking Replacement Areas map; Coastal Zone uncovered-parking replacement rule.
8
Verify utility status: sewer or septic; existing SDG&E service capacity; gas service plan.
9
Check HOA restrictions and submit to architectural review in parallel with city permit application.
10
Pull the current B-1 Building Permit Application, B-75 Permit-Ready ADU Checklist, and Hold Harmless Agreement from carlsbadca.gov; add P-6 Minor Coastal Development Permit if your project is a detached ADU in the Coastal Zone.
11
Request a fee estimate by submitting a B-40 Fee Estimate Request to the Permit Center, or verify line items against the current Master Fee Schedule FY 2025-26.
12
Submit a complete package — every B-75 checklist item fully addressed.

Get the property-specific version of this checklist

Free address-level check. Coastal Zone, transit, school district, sewer-vs-septic, and the permit path most likely to apply to your lot.

See What You Can Build → Get Your Free ADU Report

Frequently asked questions

Do I need a permit to build an ADU in Carlsbad?

Yes. Every Carlsbad ADU and JADU requires a building permit. Detached ADUs inside the Coastal Zone — about 37% of the city — also require a Minor Coastal Development Permit (Form P-6) that must be approved before or concurrent with the building permit. Attached ADUs and JADUs in the Coastal Zone are typically exempt from the Minor CDP per CMC § 21.201.060(B)(1). Verify your property's Coastal Zone status using the city's online lookup at carlsbadca.gov before designing the project.

How much does a Carlsbad ADU permit cost?

The city's published building-permit fee for most ADUs is approximately $2,000–$4,000, depending on square footage. The total permit-and-fee stack — including school fees (on ADUs over 500 sq ft per Cal. Ed. Code § 17620), impact fees (on ADUs over 750 sq ft per Gov. Code § 66311.5), utility connection or capacity charges, the SDG&E meter and service scope, and (for detached coastal projects) the Minor CDP — typically lands in the mid-five-figures for a new detached ADU. Architectural design fees of $8,000–$16,000 are separate. Submit a B-40 Fee Estimate Request to the Permit Center for a project-specific estimate.

How long does a Carlsbad ADU permit take?

California Government Code § 66317 (as amended by SB 543, effective January 1, 2026) requires the city to determine completeness within 15 business days and approve or deny a complete application within 60 days. If the city misses the 60-day window, the application is deemed approved. AB 462 (effective October 10, 2025) imposes the same 60-day clock on coastal ADU permits. Practical permit-in-hand time is typically 3 to 4 months because of correction cycles, fee issuance, and applicant response time. Total project elapsed time from first design conversation to Certificate of Occupancy is typically 10 to 18 months.

Are Carlsbad's Permit Ready ADU plans available right now?

No. As of May 12, 2026, the City of Carlsbad's Permit Ready building plans are unavailable while being updated to comply with the 2025 California Building Codes, which took effect statewide January 1, 2026. The city anticipates updated plans will be available by summer 2026. Verify availability on carlsbadca.gov/planning/adu-permit-ready-program before counting on the program for your project timeline.

Does Carlsbad require a coastal development permit for ADUs?

Detached ADUs in Carlsbad's Coastal Zone require a Minor Coastal Development Permit (Form P-6) in addition to the building permit. Attached ADUs and JADUs in the Coastal Zone are typically exempt from the Minor CDP and only require a building permit, subject to the exceptions listed in CMC § 21.201.060(B)(1). About 37% of Carlsbad sits within the Coastal Zone; confirm your property's status using the city's online lookup.

Can a Carlsbad coastal ADU decision be appealed to the California Coastal Commission?

No. Government Code § 66329 (amended by AB 462, effective October 10, 2025) provides that a local-government decision on a coastal ADU permit is not subject to appeal to the California Coastal Commission under Public Resources Code § 30603. The Coastal Commission's own appeals guidance confirms ADU coastal decisions are not appealable. Older bulletins, including Carlsbad's October 2025 IB-111, may still reference CCC appeal rights; the current state-law rule controls.

How big can a detached ADU be in Carlsbad?

Detached ADUs in Carlsbad can be up to 1,200 square feet of interior livable space. The standard height limit is 16 feet, with bonuses up to 18 feet (and 20 feet with roof-pitch alignment) on lots within ½ mile walking distance of Carlsbad Village Station or Poinsettia Station, and up to 18 feet on multifamily lots with existing multi-story dwellings. ADUs up to 800 square feet are exempt from lot-coverage limits.

How big can an attached ADU be in Carlsbad?

Attached ADUs in Carlsbad can be up to 1,200 square feet of interior livable space or 50% of the primary dwelling's floor area, whichever is less, with a state-law-protected minimum of 800 square feet regardless of the primary home's size. Attached ADUs can be up to 25 feet tall and not more than two stories, subject to the underlying zone's height limit.

Do I need a soils report for my Carlsbad ADU?

Carlsbad's B-75 ADU Checklist indicates detached single-story ADUs at 500 sq ft or less generally do not require a soils investigation report. Larger or two-story ADUs typically require one. ADUs near geotechnical hazards, slopes, or coastal bluffs may require a report regardless of size. Confirm current submittal requirements with the Carlsbad Building Division at 442-339-2719 before commissioning the report.

Can my HOA block my Carlsbad ADU?

No. California Civil Code § 4751 makes void and unenforceable any HOA covenant, restriction, or governing-document provision that effectively prohibits or unreasonably restricts construction or use of an ADU or JADU on a single-family lot. HOAs can impose reasonable design standards but cannot block the project. Submit to HOA architectural review in parallel with the city permit application.

Does my Carlsbad ADU need its own electric meter?

Carlsbad's submittal documents reference utility work orders when new meters or panel upgrades apply. Builder analyses from SnapADU and Better Place Design & Build report that SDG&E has been requiring a separate electric meter for new detached ADU construction in San Diego County since March 2023, with installation typically running around $15,000. Confirm meter and service scope for your parcel with a CSLB C-10 licensed electrician and SDG&E Builder Services.

Can I rent my Carlsbad ADU on Airbnb?

No for newer ADUs. Carlsbad's ADU rules and California state ADU law require rentals to be for terms longer than 30 days. Short-term rentals (under 30 days) on a newer permitted ADU are not the standard pathway. ADUs in the Coastal Zone that were issued a building permit prior to January 1, 2020 are exempt from the 30-day minimum-rental requirement under IB-111.

Can I sell my Carlsbad ADU separately?

No. Per IB-111, the City of Carlsbad does not permit separate sale of ADUs and has not enacted the local ordinance required to opt into the expanded separate-sale option under Government Code § 66342 (the AB 1033 pathway). Confirm with the Carlsbad Planning Division at 442-339-2610 if you need the current status, since the city could opt in by ordinance in the future.

Does building an ADU increase my Carlsbad property taxes?

Your property taxes will increase based on the added value of the ADU itself, but the base value of your existing property is not reassessed under California's Proposition 13. The increase is calculated as the new ADU's assessed value multiplied by your property tax rate (typically approximately 1.1% in San Diego County). Confirm with the San Diego County Assessor's Office for the exact reassessment treatment of your project.

Does an ADU at 750 sq ft or less avoid impact fees?

Yes. California Government Code § 66311.5 (as amended by SB 543) prohibits local agencies, special districts, and water corporations from imposing impact fees on ADUs with 750 sq ft or less of interior livable space. Impact fees on ADUs over 750 sq ft must be charged proportionally in relation to the primary dwelling's square footage. School fees (governed by Cal. Ed. Code § 17620) are a separate category and can apply to ADUs over 500 sq ft.

Where do I submit my Carlsbad ADU application?

The Carlsbad Permit Center is at 1635 Faraday Ave, Carlsbad, CA 92008, open Monday–Friday 8 a.m. to 5 p.m. Phone numbers: 442-339-2719 for building permits, 442-339-2700 for permit status and inspections, 442-339-2610 for the Planning Division. The city's online portal accepts many residential building permit applications including "Residential Second Dwelling Unit." Coastal Zone projects requiring a Minor CDP may need a hybrid submittal — confirm the route with the Permit Center before assembling plans.

Do I have to use Carlsbad's Permit Ready plans?

No. You can submit a building permit application for a fully custom ADU without using the city's Permit Ready plans. If you plan to build a Junior ADU (which must be within the walls of the primary residence or attached garage), you will need a building permit application; JADUs are not covered by the Permit Ready Program.

Download the Free Carlsbad ADU Starter Kit

Permit checklist, size-threshold cheat sheet, Coastal Zone decision tree, and form links.

Get the Free Carlsbad ADU Starter Kit →

Methodology and sources

This guide was researched and written by The Dwelling Index Editorial Team. The Dwelling Index is an independent research resource covering ADU financing, costs, and regulations.

Verification approach: We separated official city/state documents (current and dated) from builder-reported claims and flagged unresolved conflicts inline. Where current state law and an older city bulletin disagree on a point (notably the coastal-permit appeal rule under AB 462), we identify both and tell readers which one controls.

Primary sources reviewed for this guide:

Industry references (cross-check and practitioner perspective):

Update cadence: Monthly through summer 2026 while Carlsbad's Permit Ready Program is paused and while SB 1077 final guidance is pending, then quarterly. Fee schedules re-verified each July (Carlsbad's fiscal year reset) and each January (school district State Allocation Board cycle). Coastal Zone rules re-verified after the California Coastal Commission issues SB 1077 final guidance (due no later than July 1, 2026). Last updated: May 12, 2026. Last verified: May 12, 2026.

Not sure where to start?

See what's possible at your address — get your free ADU report in 60 seconds.

Check My Property →
